Global AI Data Center Industry - Market Landscape, Business Models, and M&A Playbook

Data-Center AI

The global data center industry is in the midst of an unprecedented "supercycle." The 2024 total market is estimated at $350–390 billion, and powered by the explosive demand for AI compute, is projected to exceed $650 billion by 2030 at a CAGR of 9–11%. The headline numbers are even more striking: in Q3 2025 alone, global hyperscale capex reached $142 billion — a roughly 180% year-over-year increase (Synergy Research); Dell'Oro Group reports that full-year 2025 data center capex grew 57% YoY, with 2026 projected to cross $1 trillion. Severe supply-demand imbalance is the defining feature of the current market — the global weighted average vacancy rate has fallen to a record-low 6.6% (CBRE Q1 2025), with North American core markets at just 1.4% and Singapore below 2%. Power access has replaced land and capital as the primary bottleneck constraining industry growth.

Chapter I: Global Data Center Market Overview

1. Total Market Size: A Cross-Validated Panoramic View

Market Revenue and Growth

Due to methodological differences (whether IT hardware, software, and construction investment are included), market-sizing figures vary across research firms, but the trend is consistent. The following is a cross-reference of 2024–2030 data from major institutions

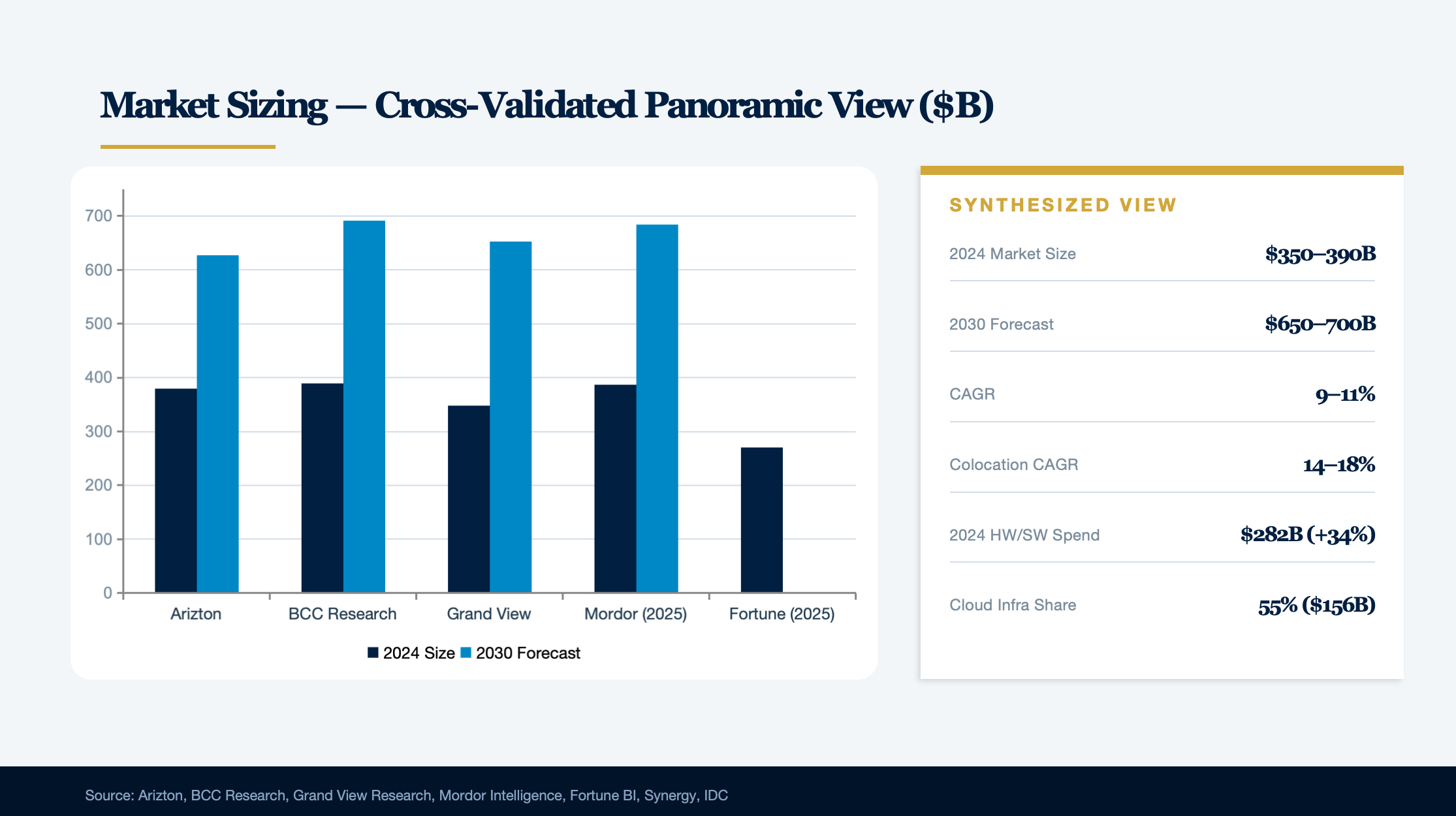

Institution 2024 Size 2030 Forecast CAGR Publication Date
Arizton $379.3B $627.4B 8.75% 2025
BCC Research $389.0B $691.6B 10.6% December 2025
Grand View Research $347.6B $652.0B 11.2% 2025
Mordor Intelligence $386.7B (2025) $684.4B (2031) 9.98% January 2026
Fortune Business Insights $269.8B (2025) 11.1% 2025

Synthesized view: On a full-scope basis including infrastructure investment, the 2024 market size of $350–390 billion is the reasonable range, growing to $650–700 billion by 2030 at a 9–11% CAGR.

Within sub-segments, the colocation market is experiencing the strongest growth. Grand View Research estimates the 2024 global colocation market at $69.4 billion, with a CAGR as high as 16.0% (reaching $165.5 billion by 2030). Mordor Intelligence presents a more aggressive view — $105.9 billion in 2025 at an 18.63% CAGR. MarketsandMarkets takes the middle ground at a 14.4% CAGR.

On the hardware and software layer, Synergy Research Group's January 2025 data shows 2024 global data center hardware and software spending reached $282 billion, a 34% YoY jump, with public cloud infrastructure spending of $156 billion accounting for 55% of the total. IDC's same-period tally of infrastructure investment was $231.5 billion, up 35.7% YoY.

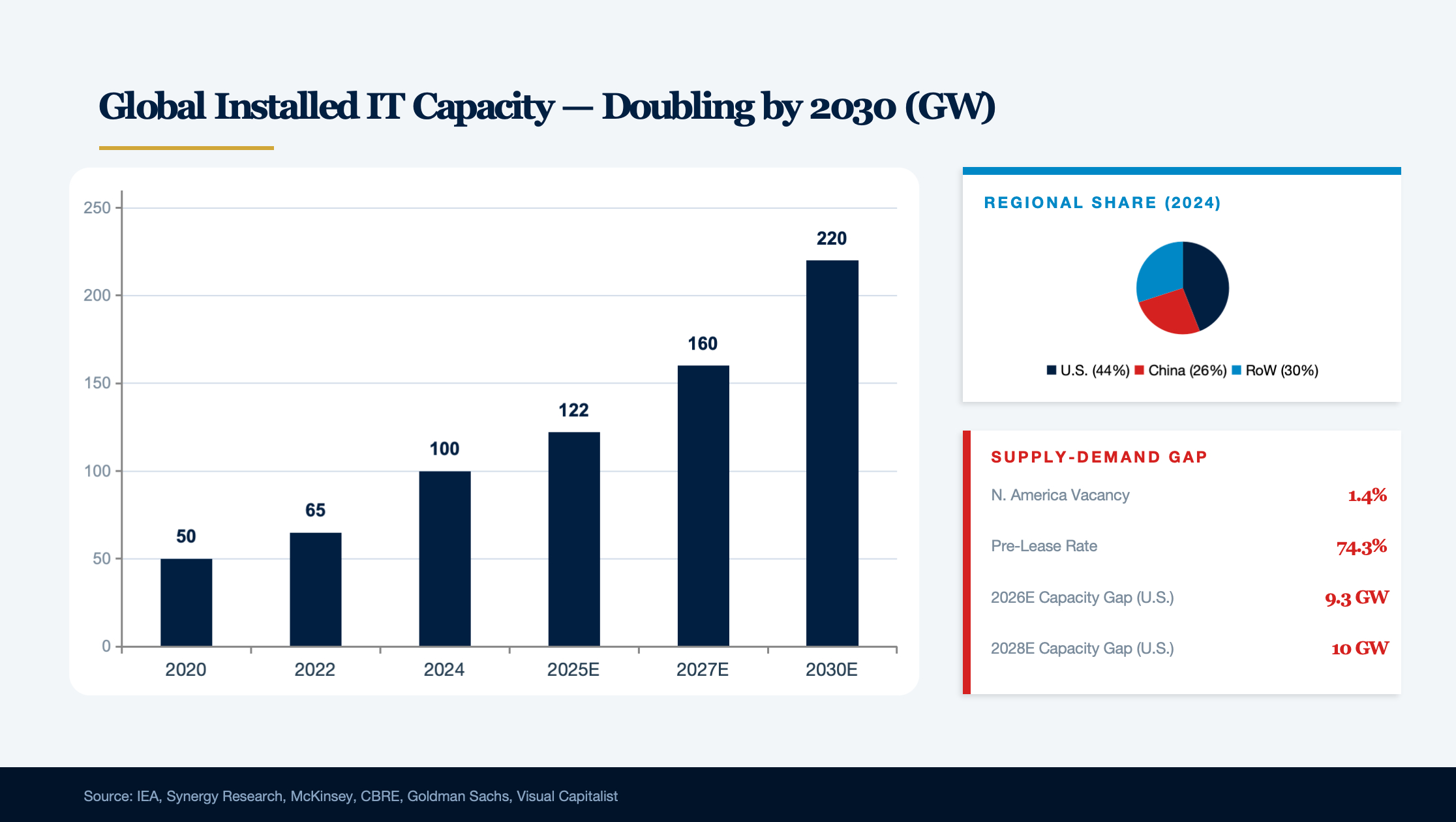

Global Installed Capacity Is Doubling

Total installed IT power capacity is climbing rapidly. Aggregating multiple data sources:

  • IEA: 2024 global installed capacity approaching 100 GW
  • Synergy Research: Q1 2025 reaching 122.2 GW
  • Knight Frank: 2024 live IT capacity of 45,676 MW, projected to reach 66,504 MW by 2026 (a 45% increase)
  • Mordor Intelligence: approximately 119 GW in 2025, projected at 240 GW by 2030, CAGR 15.08%
  • McKinsey: global demand projected at ~220 GW by 2030

Note the methodological differences between IEA and Synergy — IEA's 100 GW is closer to facility-level total power consumption, while industry trackers typically focus on IT load capacity. Cushman & Wakefield tracks 97 global markets, with end-2024 third-party operated capacity exceeding 40 GW. By regional breakdown, U.S. installed capacity stands at 53.7 GW (44% of global), China at approximately 32 GW (26%), with the two countries combined representing 70% of the global total (IEA 2024 data).

Supply-Demand Gap at Critical Levels

The severity of the supply-demand imbalance is unprecedented. North American core market vacancy is just 1.4% (CBRE H2 2025), with 74.3% of under-construction capacity already pre-leased. JLL reports that North American vacancy has held at approximately 1% for two consecutive years, with 60% of 35 GW under construction fully leased. Goldman Sachs projects global occupancy will rise from approximately 85% in 2023 to a peak of over 95% by end-2026. Visual Capitalist, citing industry data, notes that the U.S. data center capacity gap is projected to reach 9.3 GW in 2026 and 10 GW in 2028. Key bottlenecks include: power access and grid interconnection delays (2–5 years in many locations), transformer delivery delays (24–40 weeks), tighter permitting, and tight cooling equipment supply chains.

2. Global Competitive Landscape of Leading Operators

Map of the World's Top 20 Operators

Industry concentration continues to rise, with hyperscale operators and private capital dominating the landscape. The following summarizes key metrics for major operators in 2024–2025:

Rank Operator Total Capacity Data Centers 2025 Revenue Geographic Coverage
1 QTS (Blackstone) >3 GW 70+ Undisclosed North America, UK
2 Equinix ~2.1 GW (U.S.) 251 $9.22B 70 metros across 32 countries
3 Vantage ~2.6 GW 24+ (NA) Undisclosed North America, EMEA, APAC
4 Digital Realty 2,431 MW 312 $6.11B Six continents
5 Aligned + ODATA >2.5 GW 40+ Undisclosed North America, LatAm
6 STT GDC 2.3 GW design capacity 100+ Undisclosed 12 countries (APAC, Europe)
7 NTT Global DC 2,000+ MW 160+ ~$1.8B 20+ countries
8 CyrusOne (KKR/GIP) ~1,000 MW 55+ Undisclosed U.S., Europe
9 CoreWeave 850 MW (active) 43 ~$5.2B (2025E) U.S., Europe
10 GDS Holdings 510,511 sqm in service 102 ¥11.29–11.59B (guidance) China, SE Asia

Other important operators include: STACK Infrastructure (23+ global markets, with major projects including a 220 MW Malaysia campus and 200 MW Virginia facility); EdgeConneX (350 MW in Japan, AI data center partnership with Lambda); Iron Mountain (18 U.S. data centers, 233 MW, with rapid data center revenue growth); CloudHQ (7 U.S. data centers, 260 MW, with the Ashburn, VA campus reaching 1.7 GW at full build-out); Switch (5 major campuses, 500+ MW potential capacity); VNET Group (452 MW under construction, Microsoft Azure's China partner); Colt DCS (£2.5 billion London expansion plan); Africa Data Centres (Africa's largest independent operator); and ODATA (Latin America's leading hyperscale operator, with a $3.3 billion project in Querétaro).

Chapter II: Global Data Center Trends Driven by AI Compute Demand

AI is reshaping every dimension of the global data center industry at unprecedented speed and scale — from chip to rack, from grid to capital structure. The 2024 global AI server market crossed $125 billion (IDC basis), and combined 2025 capex from the five largest hyperscalers is approaching $400 billion, with roughly 75% flowing to AI infrastructure. The IEA forecasts global data center electricity consumption will double from 415 TWh in 2024 to 945 TWh by 2030, with most of the increment driven by AI. Concurrently, rack-level power density has surged from the traditional 5–10 kW to over 120 kW; GW-scale campuses are moving from blueprint to reality; and non-traditional power solutions such as nuclear and on-site gas generation are being deployed at pace. The depth, breadth, and speed of this transformation are rewriting the rules of the infrastructure industry.

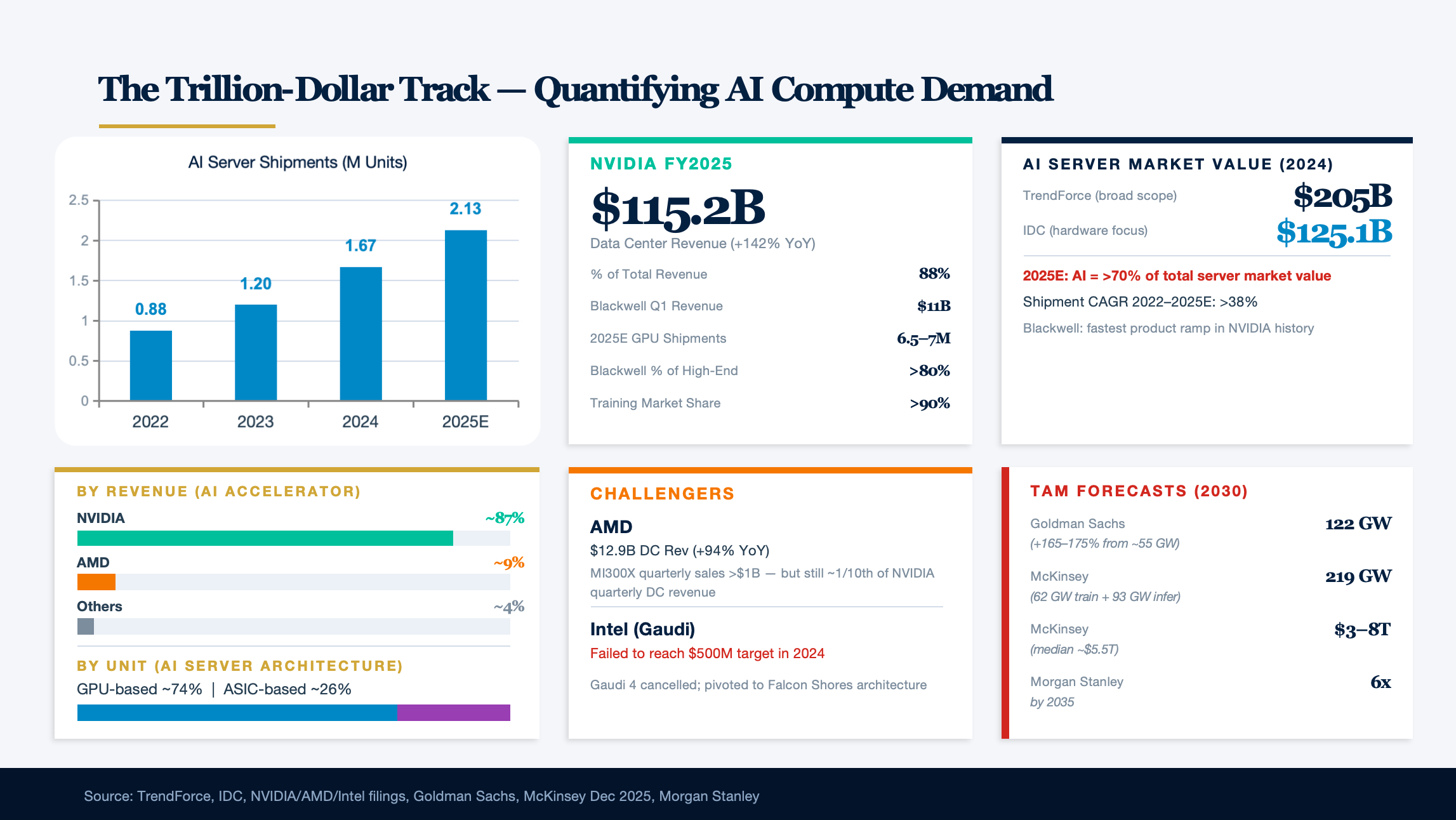

1. The Trillion-Dollar Track: Quantifying AI Compute Demand

Global AI server shipments grew from approximately 880,000 units in 2022 to 1.67 million units in 2024 (TrendForce), a CAGR exceeding 38%. By market value, TrendForce pegs the 2024 AI server industry at approximately $205 billion, while IDC's narrower hardware-focused count is $125.1 billion — both showing explosive growth. TrendForce projects 2025 AI server shipments will reach 2.13 million units, representing over 70% of total server market value.

NVIDIA holds absolute dominance in this arms race. Its FY2025 (ended January 2025) data center revenue reached $115.2 billion, up 142% YoY and accounting for 88% of total company revenue. Blackwell-architecture GPUs contributed $11 billion in revenue in their first full shipment quarter — the fastest ramp of any product line in NVIDIA's history. By revenue, NVIDIA commands approximately 87% of the AI accelerator market and over 90% in training. In 2025, NVIDIA is expected to ship 6.5–7 million GPUs, with Blackwell accounting for over 80% of high-end GPU shipments.

AMD, as the only competitor with meaningful traction, recorded approximately $12.9 billion in 2024 data center revenue (+94% YoY), with MI300X quarterly sales crossing $1 billion — but this still represents only one-tenth of NVIDIA's quarterly data center revenue. Intel's Gaudi line suffered a major setback: 2024 failed to reach the $500 million revenue target, Gaudi 4 was cancelled, and the roadmap pivoted to the Falcon Shores architecture. Proprietary ASICs such as Google TPU and AWS Trainium are gaining ground, with ASIC AI servers rising to approximately 26% share in 2024 — though they have not yet disrupted NVIDIA's dominance in the near term.

Forecasts for the global AI data center TAM are converging in direction but diverge significantly in methodology. Goldman Sachs projects global data center power demand will grow from approximately 55 GW today to 122 GW by 2030, an increase of 165–175%. McKinsey's December 2025 forecast is more aggressive: 2030 global data center power demand will reach 219 GW, consisting of 62.2 GW for AI training and 93.3 GW for AI inference. By investment scale, McKinsey estimates cumulative AI data center investment requirements of $3–8 trillion, with a median of approximately $5.5 trillion. Morgan Stanley projects global data center capacity will need to grow 6x by 2035.

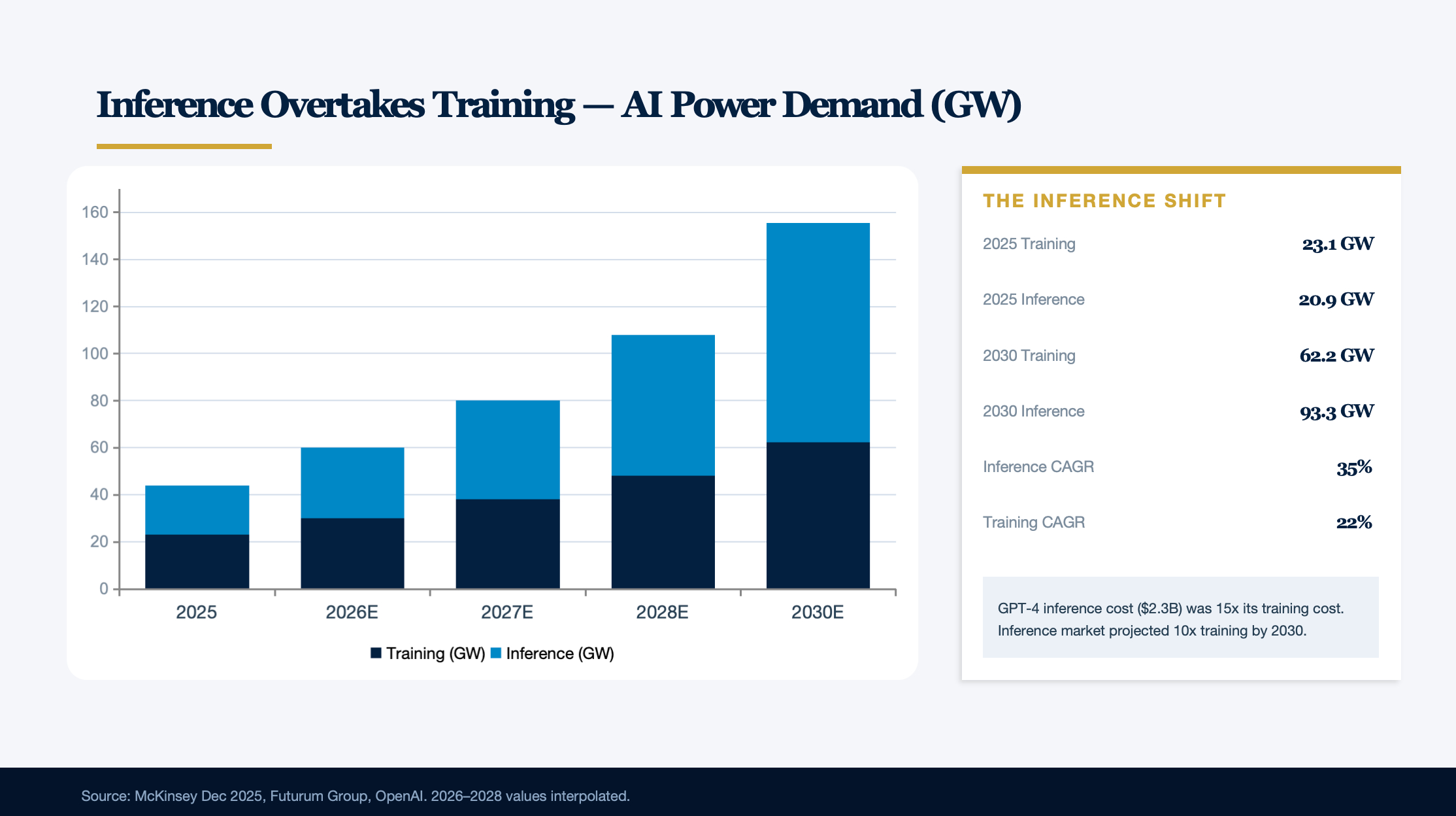

Inference Is Overtaking Training as the Dominant Workload

The internal structure of AI compute demand is undergoing a profound shift. McKinsey data shows that in 2025, AI training power demand is approximately 23.1 GW and inference is 20.9 GW — roughly balanced. By 2030, however, inference will surge to 93.3 GW (CAGR 35%), substantially exceeding training at 62.2 GW (CAGR 22%). The Futurum Group projects inference revenue will surpass training by 2026; for reference, GPT-4's 2024 inference expenses of approximately $2.3 billion were already 15x its training cost. The inference market is projected to be 10x the size of the training market by 2030. This structural shift means data centers must simultaneously serve two fundamentally different workload profiles — training requires sustained high power and mega-scale clusters, while inference demands low latency and flexible scaling.

On per-query AI energy consumption, the early "ChatGPT uses 10x the energy of a Google search" narrative now requires correction. EPRI's initial estimate placed ChatGPT at approximately 2.9 Wh per query, but updated data from Epoch AI and Sam Altman in 2025 shows GPT-4o standard queries consume only approximately 0.3 Wh — comparable to the per-query figure Google published for its search service back in 2009. That said, complex queries (long text, file attachments) can consume 2–40 Wh, and reasoning-chain models (such as o1) require several multiples of the compute of standard queries. More importantly, Google Search itself has integrated AI Overview, driving actual energy consumption upward.

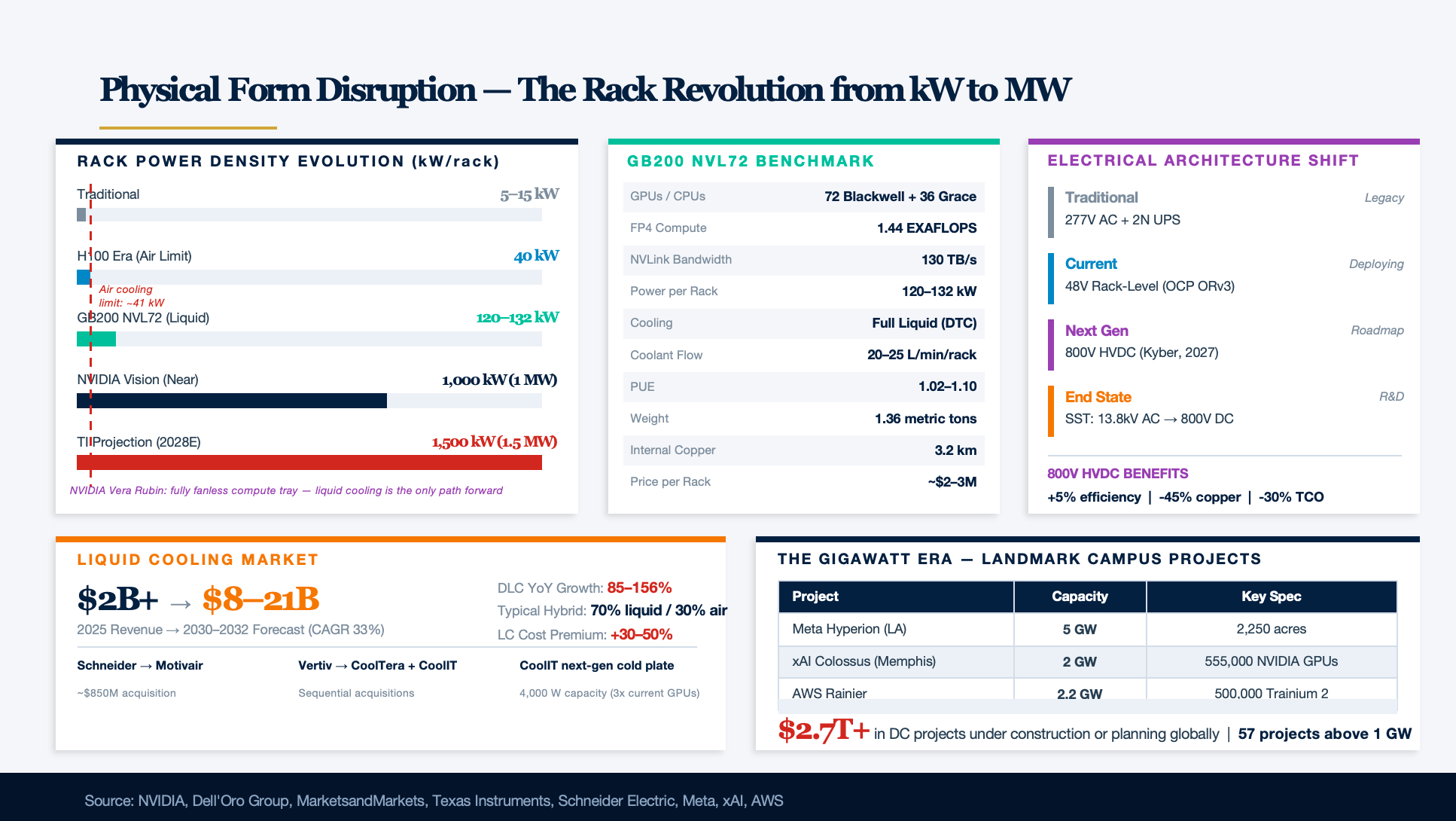

2. Physical Form Disruption: The Rack Revolution from Kilowatts to Megawatts

AI's impact on data center physical infrastructure first manifests in the leap in power density. Traditional data center rack power density runs 5–15 kW; H100-era AI training racks reach 40 kW (the air-cooled limit); and NVIDIA Blackwell GB200 NVL72 pushes this figure to 120–132 kW/rack — making liquid cooling a hard prerequisite.

GB200 NVL72 represents the current benchmark for AI infrastructure: 72 Blackwell GPUs paired with 36 Grace CPUs across 36 superchips, forming a single NVLink domain delivering 130 TB/s of interconnect bandwidth and 1.44 EXAFLOPS of FP4 compute. A single rack weighs approximately 1.36 metric tons, contains over 3.2 km of internal copper cabling, and sells for approximately $2–3 million. The system requires full liquid cooling (direct-to-chip cold plate), with coolant flow of approximately 20–25 L/min/rack and inlet temperatures of 25–45°C, driving PUE down to 1.02–1.10.

But this is not the endpoint. NVIDIA has shown the vision of 1 MW-class racks, and in May 2025 released an 800V high-voltage DC (HVDC) power distribution architecture, planned for volume deployment with the Kyber rack system in 2027. The architecture delivers up to 5% end-to-end efficiency improvement, 45% less copper use, and up to 30% lower TCO. Texas Instruments projects that by 2028, a single IT rack will require 1.5 MW of power — 10x current levels.

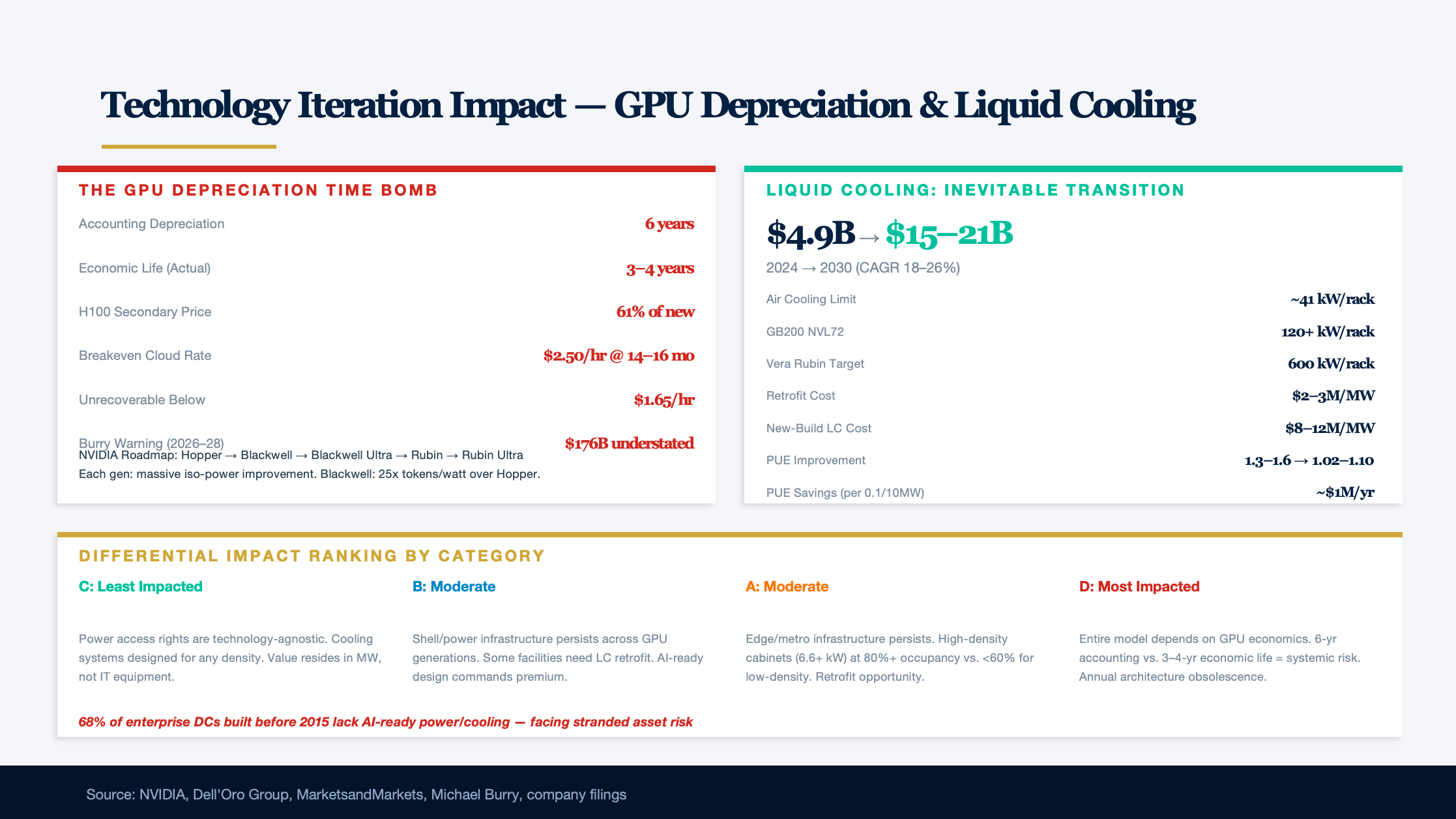

Liquid Cooling Moves from Optional to Mandatory

The liquid cooling market is experiencing explosive growth. Dell'Oro Group data shows the direct liquid cooling (DLC) market grew 85–156% YoY in 2025, with full-year revenue on track to exceed $2 billion, and projected to surpass $8 billion by 2030. MarketsandMarkets projects the liquid cooling market will grow from $2.84 billion in 2025 to $21.14 billion by 2032, a CAGR of 33.2%.

Key suppliers are aggressively expanding capacity and pursuing acquisitions: Schneider Electric acquired a majority stake in liquid cooling specialist Motivair for approximately $850 million; Vertiv successively acquired CoolTera and CoolIT's joint venture technology; CoolIT unveiled a next-generation cold plate prototype capable of handling approximately 4,000 W — sufficient to cool chips 3x the power of current NVIDIA GPUs. DLC has become the de facto standard for large AI clusters — NVIDIA's next-generation Vera Rubin compute tray has completely eliminated fans, achieving a fully liquid-cooled configuration. Current typical deployments are hybrid 70% liquid / 30% air, with liquid cooling system construction costs 30–50% above traditional air-cooled designs.

The electrical architecture is also undergoing a generational shift. From the traditional 277V AC distribution plus 2N UPS model, the industry is transitioning to 48V rack-level power (OCP ORv3 standard), with the ultimate target being 800V HVDC. NVIDIA's 800V roadmap has gained support from over 20 semiconductor and power equipment companies including ADI, Infineon, Eaton, Schneider, and Vertiv. The end-state solution is solid-state transformers (SSTs) that directly convert 13.8 kV AC to 800V DC, eliminating multi-stage conversion — but commercial deployment is still years away.

Data center campuses have crossed from the "megawatt era" into the "gigawatt era." Meta's Hyperion project in Louisiana targets capacity of up to 5 GW on 2,250 acres; xAI's Memphis Colossus campus has 2 GW operating and under expansion, deploying 555,000 NVIDIA GPUs; AWS's Project Rainier plans 2.2 GW with 500,000 Trainium 2 chips. Globally, data center projects under construction or in planning are valued at over $2.7 trillion, including 57 projects above 1 GW in capacity.

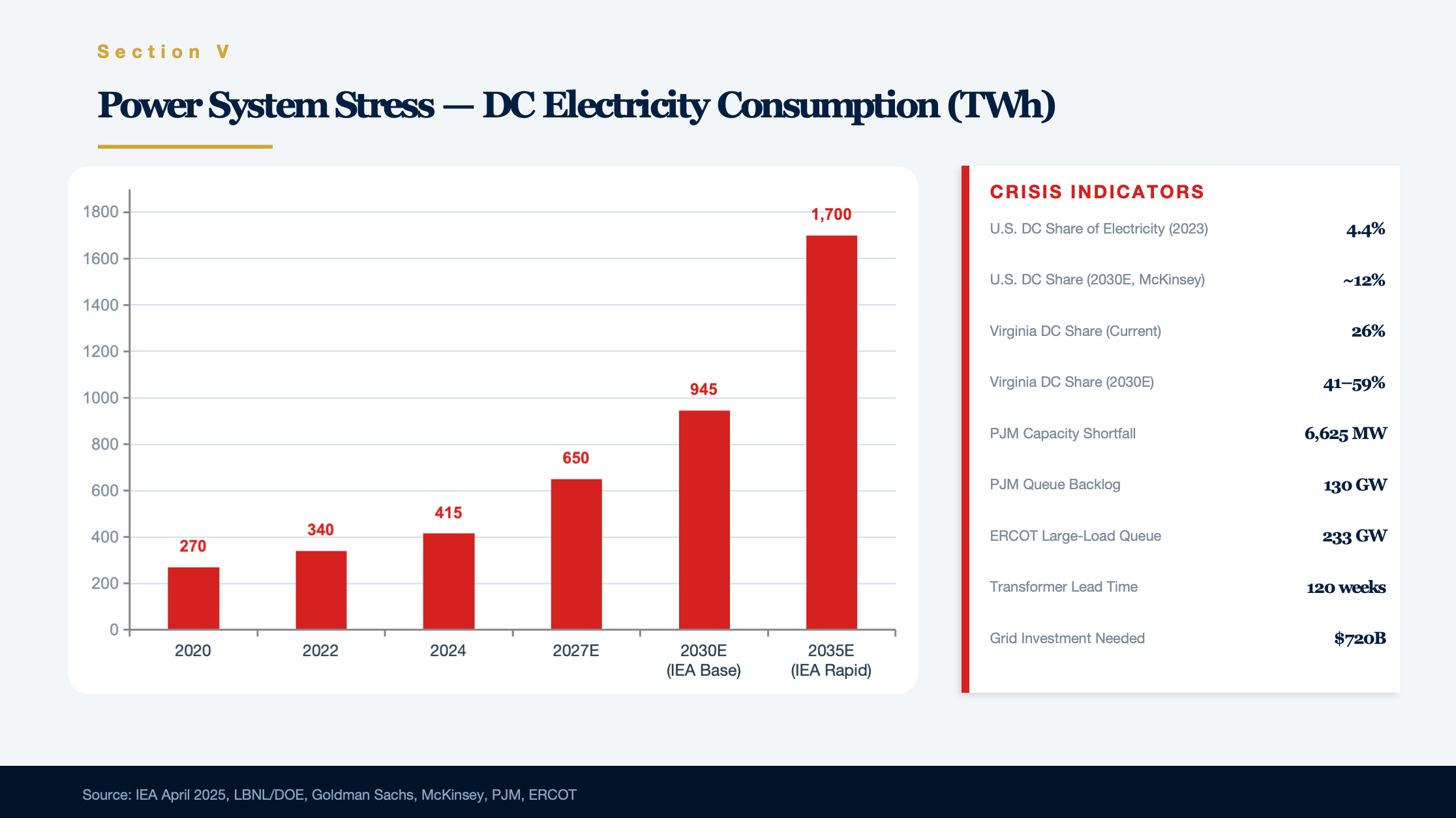

3. Power System Stress Test: From Bottleneck to Crisis

AI data centers' impact on the global power system is shifting from forecast to reality. The IEA's April 2025 Energy and AI report shows global data center electricity consumption grew from approximately 270 TWh in 2020 to 415 TWh in 2024, representing approximately 1.5% of global electricity consumption. Under the baseline scenario, 2030 consumption will reach 945 TWh (~3% of global total), and under the rapid-growth scenario, 2035 could exceed 1,700 TWh. Goldman Sachs' forecast focuses on the power dimension: global data center power demand grows from approximately 55 GW today to 84–92 GW by 2027 and 122 GW by 2030, requiring approximately $720 billion in global grid investment.

The United States is where the pressure is most concentrated. The LBNL/DOE December 2024 report shows 2023 U.S. data center consumption reached 176 TWh, or 4.4% of total U.S. electricity. IEA forecasts 2030 consumption will reach 426 TWh; McKinsey's estimate is higher, projecting U.S. data center share will reach approximately 12%. Virginia's situation is particularly extreme — data centers already account for 26% of state electricity, and EPRI projects this could reach 41–59% by 2030.

PJM Grid Posts Its First Capacity Shortfall; Reliability on the Edge

The PJM Interconnection grid, covering 65 million people across 13 Eastern U.S. states, is under tremendous pressure. Its interconnection queue holds approximately 130 GW of capacity awaiting connection — equivalent to 73% of existing system capacity. More alarmingly, the December 2025 capacity auction posted its first-ever 6,625 MW capacity shortfall, failing to meet reliability targets, with capacity prices surging to a record $333.44/MW-day. PJM peak load is projected to grow 32 GW from 2025–2030, with 30 GW coming from data centers. The organization's scenario analysis shows new data center capacity additions are running at 2x the pace of new generation additions annually, with the cumulative deficit widening and reliability standards potentially being breached from summer 2027.

The Texas ERCOT grid faces similar pressures. As of end-2025, its large-load interconnection queue had surged to over 233 GW, up approximately 300% year-over-year. Data-center-related proposals alone total 156 GW (through 2030), while only approximately 3 GW of large loads were actually approved between June 2024 and June 2025. Interconnection wait times are a system-wide issue — extending from under 2 years in 2000–2007 to approximately 5 years on average today. At end-2023, the national interconnection queue totaled approximately 2.6 TW — more than double existing U.S. installed capacity.

Supply chain bottlenecks for critical power equipment have become a hard constraint on data center construction. Large power transformer delivery times have extended from approximately 50 weeks in 2021 to an average of 120 weeks in 2024, with some transmission-class transformers requiring 3–6 years. Prices have risen 150% since 2020 — 4–6x pre-2022 levels. The U.S. imports 80% of transformer MVA capacity, with severely inadequate domestic production. High-voltage circuit breakers have delivery times of approximately 151 weeks (nearly 3 years), switchgear is in severe shortage, and gas turbines require 5–7 years. The core bottlenecks are shortages of grain-oriented electrical steel (GOES) and copper, and insufficient manufacturing capacity.

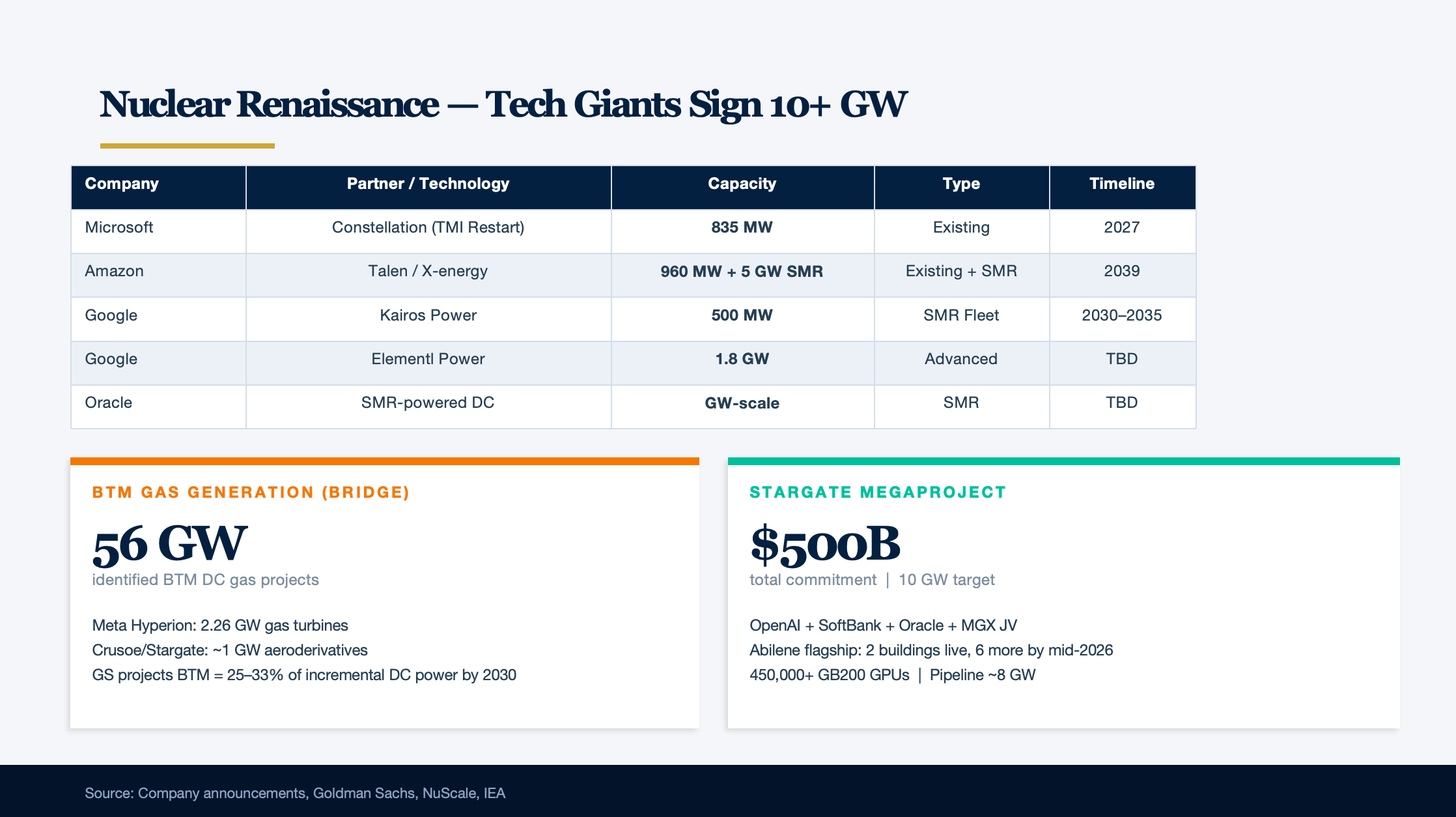

Nuclear Renaissance: Tech Giants Sign for 10+ GW of New Capacity

Facing power bottlenecks, tech giants are embracing nuclear energy with unprecedented intensity. Microsoft signed a 20-year agreement with Constellation Energy, investing $1.6 billion to restart the 835 MW Three Mile Island plant, targeting resumption in 2027. Amazon, through investments in X-energy and a 17-year PPA with Talen Energy, has locked in significant nuclear capacity including 960 MW from the Susquehanna plant, with a goal of deploying 5 GW of SMRs by 2039. Google signed the U.S.'s first corporate SMR fleet contract with Kairos Power for 500 MW to be delivered 2030–2035, and is partnering with Elementl Power to develop 1.8 GW of advanced nuclear. Oracle plans to build a GW-scale data center powered by three SMRs. NuScale's 462 MW US 460 design received Standard Design Approval from the NRC in May 2025, becoming the only NRC-certified SMR technology. Major tech companies have now collectively signed for over 10 GW of new nuclear capacity.

But nuclear timelines are long, making on-site natural gas generation a short-term bridge. Identified behind-the-meter data center gas generation projects total 56 GW. Meta's Hyperion project includes 2.26 GW of H-class gas turbines; Crusoe has deployed approximately 1 GW of aeroderivative turbines for Stargate in Abilene; global natural gas generation under construction exceeds 1,000 GW, including over 250 GW of new U.S. additions. Goldman Sachs projects BTM generation will meet 25–33% of incremental data center demand by 2030, with fuel cell capacity reaching 8–20 GW. Fuel cell suppliers such as Bloom Energy, with deployment cycles of under a year and higher efficiency, are becoming important complements to gas turbines.

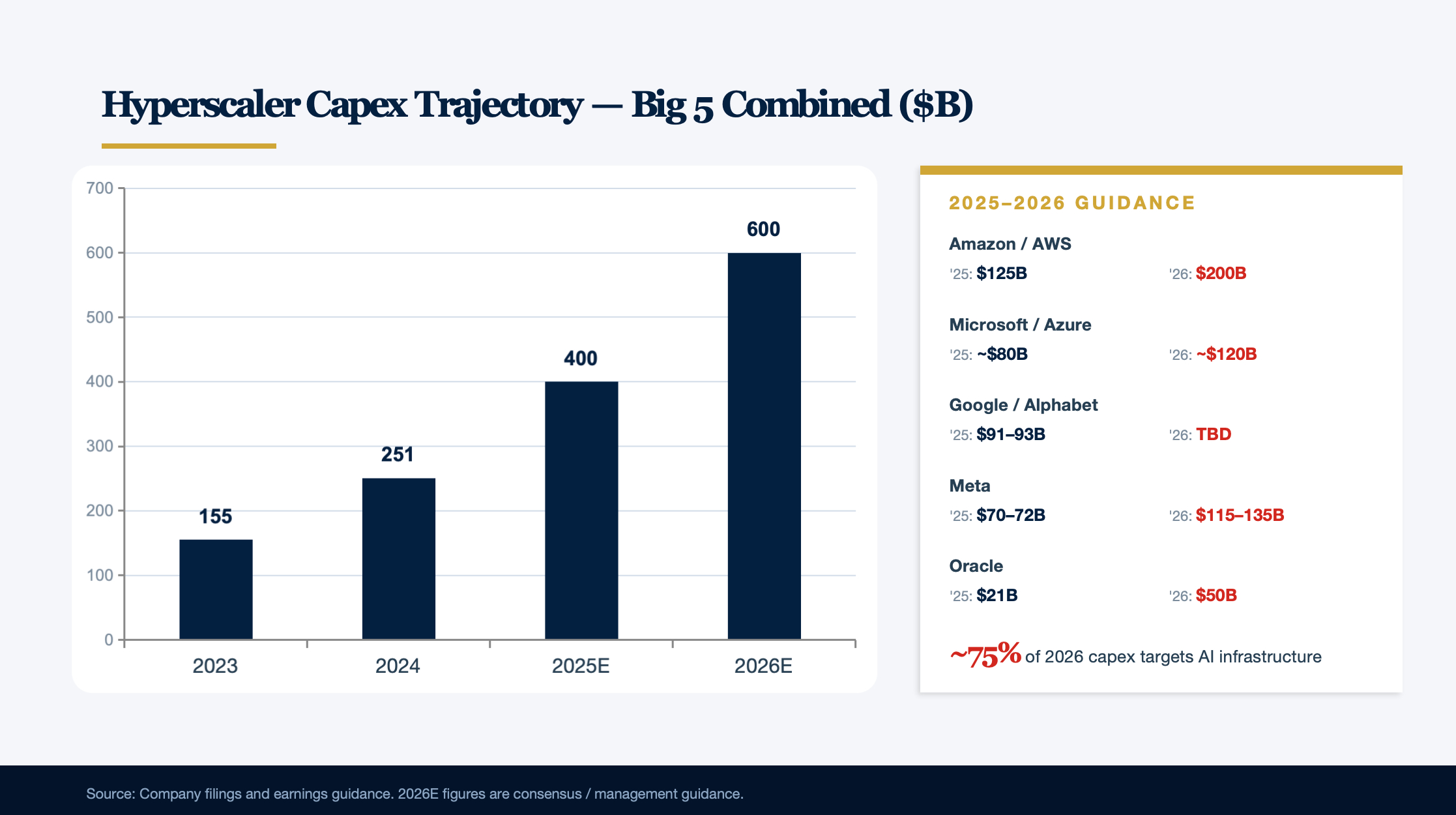

4. The Hyperscaler Arms Race: A $400 Billion Annual Bet

The five hyperscaler AI infrastructure race has reached white-hot intensity. In 2024, Amazon, Microsoft, Google, and Meta combined capex was approximately $251 billion, up 62% YoY. The 2025 figure is projected to approach $400 billion, and 2026 could exceed $600 billion.

Amazon/AWS leads with the most aggressive posture. 2024 capex was approximately $77 billion; 2025 guidance is approximately $125 billion; and Andy Jassy has confirmed 2026 will reach $200 billion — the vast majority directed toward AI infrastructure. AWS has deployed 1.4 million of its own Trainium 2 chips, all sold out; Trainium 3 will roll out in 2026 with ~40% performance improvement; Trainium 4 is expected in 2027 with FP4 performance 6x that of Trainium 3. Combined annualized revenue from the Trainium and Graviton lines has exceeded $10 billion.

Microsoft/Azure FY2025 (ended June 2025) capex was approximately $80 billion, with FY2026 projected at approximately $120 billion. Its in-house Azure Maia 100 chip, built on TSMC's 5nm process, delivers 1,600 TFLOPS of MXInt8 compute. The second-generation Maia is already in mass deployment, with 40% improvement in performance-per-watt.

Google/Alphabet actual 2024 spending was approximately $52 billion; 2025 guidance has been raised three times to $91–93 billion. TPU v7 (Ironwood) was launched in April 2025, with peak compute of 4,614 TFLOPS and 9,216-chip cluster configurations. An agreement with Anthropic for the use of up to 1 million TPUs is valued in the tens of billions.

Meta was approximately $39 billion in 2024, raised to $70–72 billion in 2025, with 2026 guidance of $115–135 billion (nearly double). Meta has announced a 4-generation MTIA chip roadmap aimed at reducing dependency on NVIDIA. It has purchased over 1.3 million GPUs, with multiple GW-scale campuses under construction globally.

Oracle has emerged as the dark horse "coming from behind." FY2026 capex has been raised from $35 billion to $50 billion, with capex as a share of revenue reaching 57% — the highest among the five hyperscalers. RPO (remaining performance obligations) has surged from $80 billion in FY2024 Q3 to the latest figure of $553 billion.

AI-Native Insurgents and the Stargate Megaproject

CoreWeave is the most closely watched AI-native data center company. It raised approximately $1.5 billion in its March 2025 IPO. 2024 revenue of $1.9 billion (+737% YoY), with a contract backlog of $66.8 billion. Active power is approximately 850 MW, total contracted capacity exceeds 3.1 GW, and it has announced an all-stock ~$9 billion acquisition of Core Scientific to secure 1.3 GW of power resources, targeting 5+ GW by 2030. NVIDIA is a core partner, having signed a $6.3 billion capacity agreement.

Crusoe Energy, with its vertically integrated model (energy → data center → cloud), has risen rapidly, with a latest valuation exceeding $10 billion and a power pipeline exceeding 45 GW. Lambda Labs is valued at approximately $4 billion and is deploying Blackwell B200s, with 25,000+ NVIDIA GPUs. Applied Digital has contracted for 600 MW and approximately $16 billion in expected lease revenue.

The Stargate project is the most grandiose undertaking in this race. A joint venture among OpenAI, SoftBank, Oracle, and MGX, announced at the White House in January 2025, with total investment commitments of $500 billion and a 10 GW capacity target. As of early 2026, the Abilene flagship site has 2 buildings operational and 6 more expected to complete by mid-2026, deploying over 450,000 GB200 GPUs. Through a series of bilateral agreements, the total project pipeline approaches 8 GW. However, the joint venture entity's governance and execution mechanism remain disputed — actual construction is largely being advanced through bilateral Oracle-OpenAI and SoftBank-OpenAI agreements.

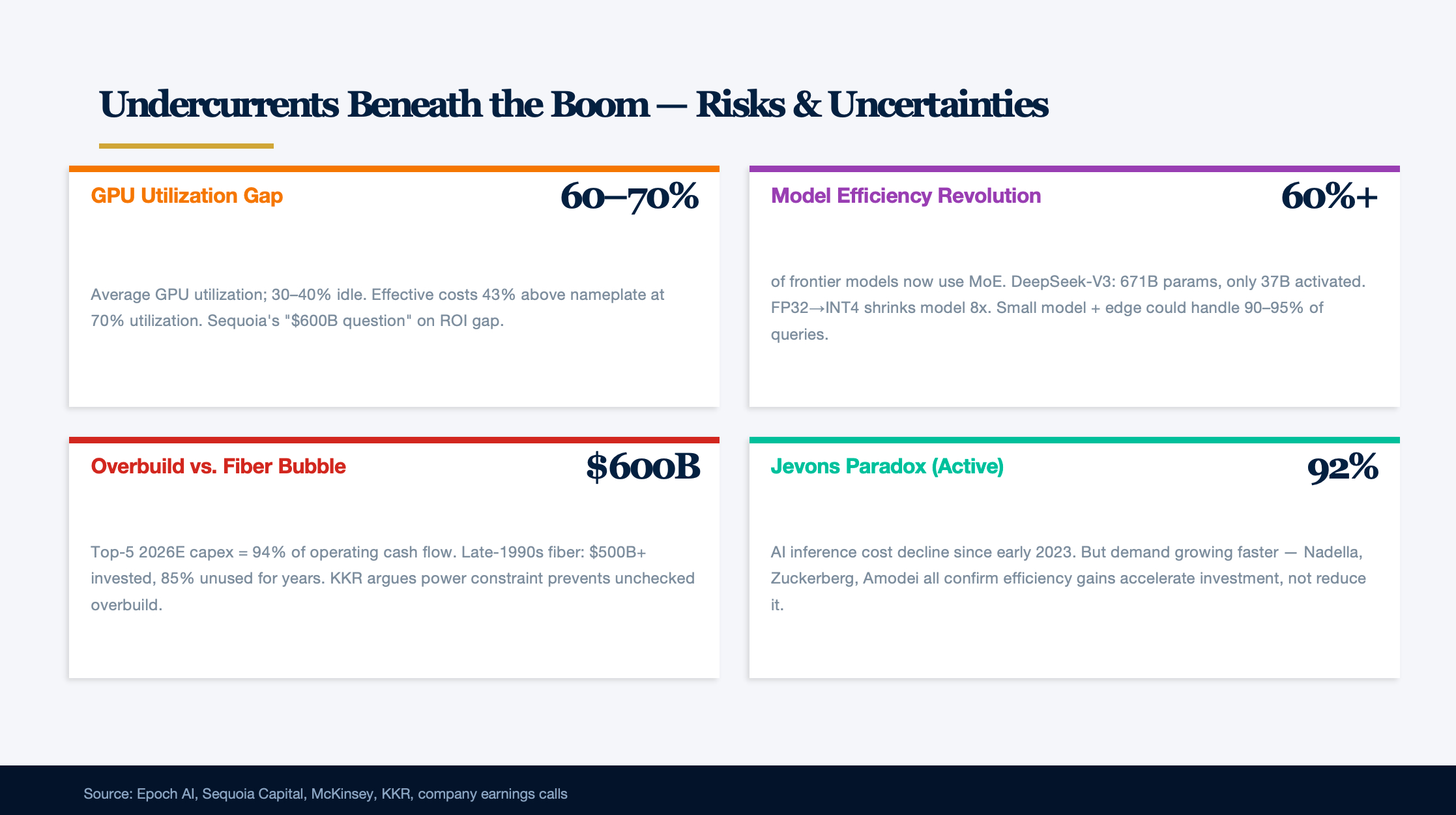

5. Undercurrents Beneath the Boom: Uncertainties and Risks

Jevons Paradox Is Operating Strongly — But Not Without Ceilings

AI chip efficiency gains are stunning — B200 inference efficiency is 8–15x that of H100, though power draw has risen from 700 W to 1000 W. Epoch AI data shows AI inference costs have dropped approximately 92% since early 2023 — but demand is growing faster. Microsoft CEO Satya Nadella, Meta CEO Mark Zuckerberg, and Anthropic founder Dario Amodei have all stated explicitly that efficiency gains will not reduce spending but will instead accelerate investment. DeepSeek V3's training cost on the surface was only approximately $5.6 million (versus over $100 million for GPT-4), but this stunning efficiency did not dampen hyperscaler spending intent — Meta raised its 2025 AI spending guidance to $60–65 billion within days of DeepSeek's release.

That said, some researchers have noted the limits of Jevons' applicability. LED lighting efficiency improvements did not lead to runaway energy consumption, and the AI market may face application-layer saturation. Short-term (2025–2027) demand growth almost certainly overwhelms efficiency gains, but the long-term trajectory depends on whether AI application end-value can continue to expand.

GPU Utilization and Overbuild Risk

Average GPU utilization is only 60–70%, with 30–40% of capacity sitting idle. In training deployments, GPUs wait for data 30–50% of the time, and data preprocessing consumes up to 65% of training cycles. 70% utilization implies effective costs are 43% above nameplate. MIG, dynamic batching, GPU pooling, and similar techniques can push utilization to 90–95%, but significant optimization headroom remains in actual deployments.

Sequoia Capital's "$600 billion question" highlighted the massive gap between AI infrastructure investment and actual revenue — only "low single-digit to low double-digit percentages" of enterprises have achieved sustainable ROI from generative AI. The late-1990s fiber optic bubble offers a historical warning: over $500 billion in investment, 85% of fiber unused for years, but ultimately birthing Netflix and Facebook. KKR argues that the current cycle differs critically from the fiber bubble — long-term contracts provide support, and the hard constraint of power makes unconstrained overbuild impossible.

The Model Efficiency Revolution Is Reshaping Demand Structure

The shift from dense Transformers to sparse MoE is the most profound technical variable. Since early 2025, over 60% of frontier models have adopted MoE architectures — DeepSeek-V3 achieves performance comparable to dense models using 671B total parameters but only 37B activated. Quantization has become standardized as "16-bit training, 4-bit deployment"; FP32 → INT4 quantization shrinks model size 8x. Microsoft's Phi-4-reasoning (14B parameters) achieves reasoning task performance approaching full DeepSeek-R1 (671B parameters) — meaning compute and memory requirements for equivalent performance are declining rapidly.

The small-model + edge-inference trend suggests a possible hybrid architecture: 90–95% of queries handled by on-device small models, with only 5–10% requiring cloud-based large models. Over 2 billion smartphones can now run local SLMs. If this trend accelerates, it could materially alter the demand growth trajectory for cloud-based AI compute.

6. Summary

This AI-driven data center transformation carries three high-conviction characteristics: power will replace land as the scarcest resource (120-week transformer lead times, PJM's 6.6 GW capacity shortfall); liquid cooling and HVDC distribution will become standard for new builds within 3–5 years (DLC penetration is moving from single digits to majority); and inference will overtake training as the dominant workload between 2026–2028 (changing data center geographic distribution and design paradigms).

The greatest uncertainty lies in whether demand growth can keep pace with investment growth. The top five hyperscalers' combined 2026 capex of $600 billion means they are channeling 94% of operating cash flow into AI build-out — an unprecedented collective bet. MoE architectures and inference optimization are driving unit compute costs down by factors of tens per year, and Jevons' paradox is strongly active in the short term — but whether AI application-layer end revenue can match the pace of infrastructure investment remains the key variable determining whether this supercycle is "rational build-out" or "a new fiber bubble." The physical constraint of power may be the most effective "circuit breaker" preventing overbuild — even with unlimited capital, transformer delivery cycles and grid interconnection capacity set a hard speed limit on this race.

Chapter III: The New Global Data Center Map in the AI Era

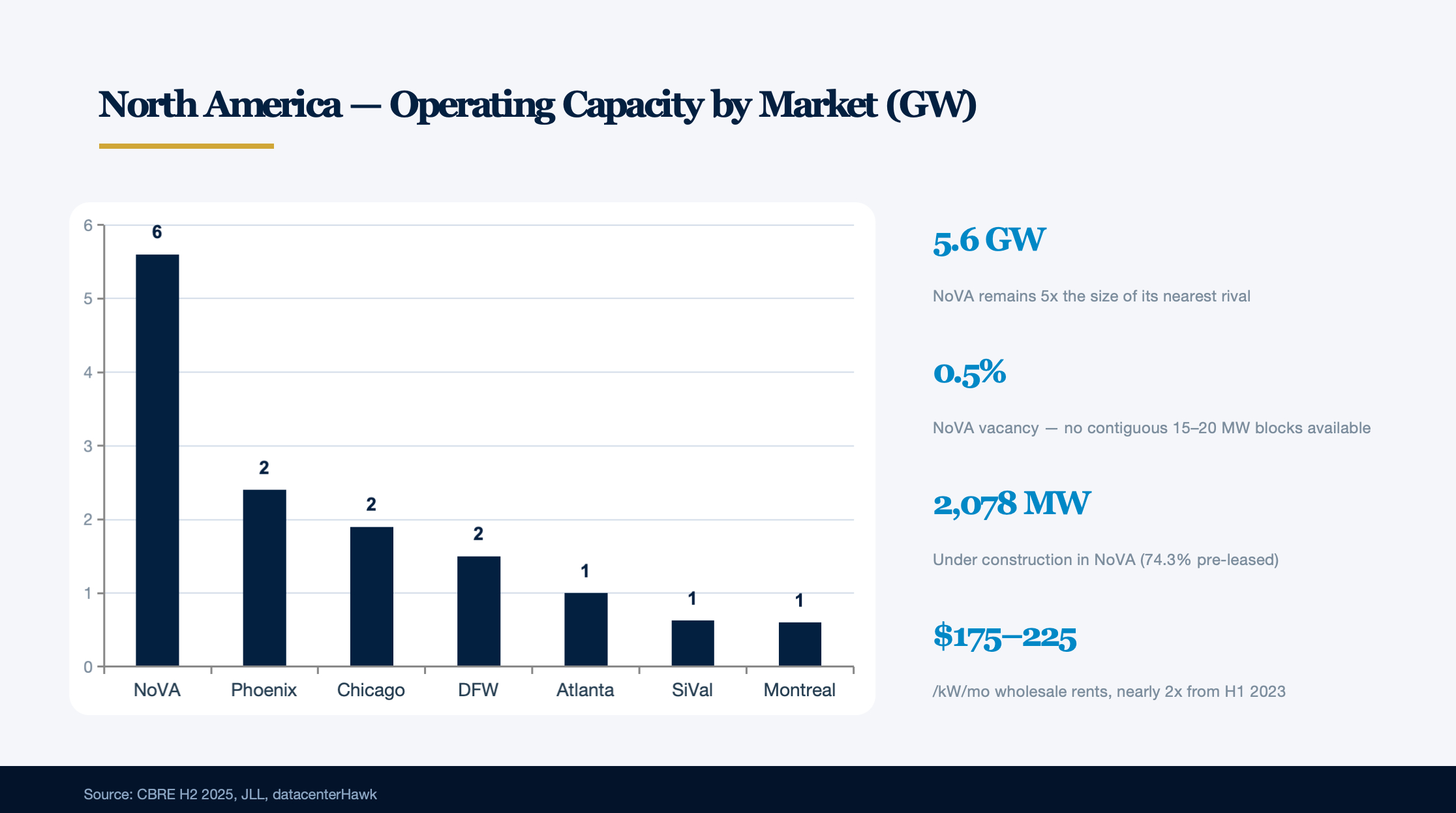

Market Operating Capacity Under Construction Pipeline Vacancy Rent ($/kW/mo) Power Rate (¢/kWh)
Northern Virginia 5.6 GW 2,078 MW 5.9 GW 0.5% $175–225 8–10
Dallas–Fort Worth 1.5 GW ~606 MW 3.9 GW <1% $200+ 6–8
Phoenix 2.4 GW 1,300 MW 4.2 GW 3% $190 7–9
Chicago 1.9 GW 1,180 MW 3+ GW 1.9% $155–165 6.9
Silicon Valley ~625 MW 168 MW Limited 5.5% $155–250 12.6–26
Atlanta 1,000 MW 2,150 MW Massive 0.72% Relatively stable 9.94
Montreal 600+ MW pipeline Multiple Large Tight 2.8–4.2

Part I: North America — The Global Compute Engine at Full Stretch

Northern Virginia Still Reigns Supreme, but the Cost of Growth Is Rising

Northern Virginia (NoVA) remains the world's largest data center market at 5.6 GW of total capacity — five times the size of its nearest rival. Net absorption in 2025 reached 1,102 MW, leading all major markets. Yet this "Data Center Capital" faces unprecedented pressure.

Supply-demand at breaking point. CBRE data shows colocation vacancy fell to just 0.5% in H2 2025, with no contiguous blocks of 15–20 MW available anywhere in the market. Under-construction capacity stands at 2,078 MW (up 80% YoY), but 74.3% is already pre-leased, with signed power agreements extending through 2026–2028. Wholesale rents have soared to $175–$225/kW/month, nearly doubling from the $90–$110 range seen in H1 2023. Data center land prices have breached $8 million per acre, compared with $200K–$300K for other land in the same area.

Dominion Energy grid queue hits record levels. As of October 2025, data center-related power applications total 47.1 GW — more than double Dominion's historical peak load of 23 GW. Filings submitted in February 2025 show pending applications with no confirmed interconnection date reaching approximately 70 GW. Individual campus applications have scaled from a typical 30 MW to 300 MW or even multi-GW levels. Dominion projects an 85% load increase over 15 years, requiring 3.4 GW of offshore wind, 12 GW of solar, and 4.5 GW of storage. Data centers already account for 21–24% of Virginia's total electricity sales.

Loudoun County ends by-right approvals. On March 18, 2025, Loudoun County voted 7:2 to amend its zoning rules, shifting data center construction from administrative approval to a Special Exception (SPEX) process — requiring public hearings before the Planning Commission and Board of Supervisors. The change is expected to add 12–24 months to approval timelines. Nonetheless, data centers still contribute roughly half the county's property tax revenue, with FY2025 collections of approximately $895 million, generating $26 in tax revenue for every $1 of public services consumed.

The southern corridor accelerates. Vantage is developing a $2 billion, 929,000 sq ft campus in Stafford County. STACK Infrastructure has planned a 1 GW Stafford Technology Campus spanning 500 acres with 19 buildings and 300 MW of battery storage. CleanArc has broken ground on a 900 MW campus in Caroline County, while PowerHouse is constructing an 800 MW facility in Spotsylvania County. The I-95 corridor is extending southward from NoVA toward Richmond as a new data center belt.

Phoenix, Chicago, DFW, Silicon Valley, and Atlanta Each Carve Distinct Positions

Phoenix boasts a 4.2 GW pipeline — second nationally only to NoVA's 5.9 GW — with 1.3 GW under construction, the most of any market outside NoVA. Vacancy stands at 3% and rents at approximately $190/kW/month. Yet water constraints are intensifying: the Bureau of Reclamation cut Arizona's Colorado River allocation to 512,000 acre-feet/year in August 2024, amid the region's driest period in 1,200 years. Data centers consume 500,000 to 5 million gallons of water daily. The industry is accelerating adoption of waterless cooling. The largest planned development is the Vermaland campus in Pinal County: 3,300 acres, up to 3 GW, and a $33 billion investment.

Chicago operates 1.9 GW with 1.18 GW under construction and a record-low vacancy of 1.9%. ComEd's grid faces immense pressure: 75+ large load applications total over 28 GW (exceeding ComEd's historical peak of 24 GW), including 7 projects requesting 1 GW each. Power delivery is delayed to 2032 or later. Illinois industrial electricity at approximately 6.9¢/kWh remains competitive among major markets.

DFW has grown to 1.5 GW of total capacity. JLL projects the market will double by end of 2026. Net absorption in 2025 reached 470.8 MW (up 424 MW YoY), while vacancy dropped below 1%.

Vantage Frontier is the market's marquee development — announced in August 2025, located in Shackelford County, roughly 125 miles west of Fort Worth. Total investment exceeds $25 billion, with 1.4 GW of capacity across 1,200 acres, 10 data centers, and 3.7 million sq ft, supporting 250+ kW ultra-high-density racks with liquid cooling. The first building is expected to deliver in H2 2026, linked to the Oracle/OpenAI Stargate project. Other major DFW projects include Crusoe and Blue Owl's $15 billion / 1.2 GW AI campus in Abilene, and Compass Red Oak's 350 MW development.

ERCOT grid — advantages and challenges. Oncor interconnection timelines of approximately 18 months are far faster than NoVA's 36 months or Silicon Valley's 5+ years. However, ERCOT interconnection applications have surged from 41 GW in early 2024 to 226 GW by November 2025, with roughly 73% attributable to data centers. Texas Senate Bill 6 requires new large loads to meet performance obligations during emergencies, with developers paying a $100K initial study fee.

Silicon Valley / San Jose is the highest-rent data center market in the U.S. ($155–$250/kW/month), with power delivery expected to take 5+ years — the longest of any major market. PG&E has virtually no additional megawatt-scale capacity available in Santa Clara or San Jose. Land prices approach $4.4 million/acre, forcing developers into 3–4-story vertical builds. But its interconnection density remains irreplaceable — Equinix's Great Oaks campus is a critical cloud connectivity hub hosting AWS Direct Connect, Azure ExpressRoute, and Google Cloud Interconnect.

Atlanta was 2024's biggest breakout market — net absorption of 705.8 MW was 39 times the 2023 figure, surpassing NoVA for the first time. Total inventory grew 222% to 1,000.4 MW, with over 2,150 MW under construction. Georgia Power received regulatory approval for approximately 10 GW of new generation capacity ($16.3 billion investment), with 80% earmarked for data centers. AWS is investing $11 billion in Georgia, and QTS is planning a 615-acre campus in Fayetteville. Georgia offers a 100% sales tax exemption on server equipment investments exceeding $15 million. However, political winds are shifting — Clayton County has imposed a construction moratorium, and state legislators considered curtailing data center tax incentives in March 2026.

Secondary Markets Explode: Ohio, Mississippi, Indiana, Reno

Ohio is rising on the back of AEP's power infrastructure and its central geographic position. AEP Ohio's queue includes 50+ customers requesting over 30,000 MW. The largest project is SoftBank's Pike County $33 billion development (10 GW data center + 10 GW power plant). Amazon has invested over $11.3 billion in Ohio. AEP plans $72 billion in grid upgrades from 2026–2030.

Mississippi has attracted approximately $29 billion in investment — including AWS's $10 billion Madison County campus (1,713 acres, 16 buildings), Compass's $10 billion Meridian campus, and xAI's 1.2 GW Southaven project. The state offers 10-year/100% corporate income tax exemptions, sales tax incentives, and 30-year rolling abatements.

Indiana has secured over $31 billion in Amazon investment alone, including the $11 billion Project Rainier in New Carlisle (2.4 GW, 1,100 new jobs). Meta is investing $10 billion in a 1 GW campus in Lebanon. Indiana offers 35-year sales tax exemptions with a starting threshold of just $10 million — among the lowest in the nation.

Reno hosts Switch's Citadel campus (2,000 acres, 7.2M sq ft, 650 MW) alongside major projects from Apple, Google, and Vantage. Notably, Reno's construction cost of $15M/MW is the highest in the country, driven primarily by labor scarcity requiring workers to be imported from other regions.

Canada: Hydroelectric Advantage Powers Montreal's Rise

Canada's total IT capacity now exceeds 10 GW (including operational, under construction, committed, and early-stage). Three hubs — Toronto, Montreal, and Alberta — account for 93% of national IT load.

Montreal has emerged as an AI data center hotspot, leveraging Québec's hydroelectric advantage with industrial power rates locked at CAD 0.036–0.054/kWh (~$0.028–$0.042/kWh) — the lowest in North America. Operating costs run 40% below the Canadian national average. Over 600 MW of announced pipeline capacity is in the 2025 queue, with campus designs targeting 70 kW/rack densities for AI workloads.

Toronto holds 370+ MW of power capacity, representing approximately 40% of Canada's total. Alberta's Wonder Valley project (O'Leary Ventures, 5.6 GW) is the largest single development ever announced in Canada.

U.S. Policy Landscape: A Tug-of-War Between Incentives and Resistance

Tax incentive competition. At least 36–42 states have some form of data center tax incentive legislation. 37 states have enacted sales tax exemptions, with 16 states collectively granting nearly $6 billion in abatements over the past five years. Virginia's exemptions have ballooned from an initial $1.5M/year to $1.6 billion/year — a JLARC evaluation rated the program as delivering only "moderate economic benefit" and noted it "does not pay for itself." Texas is expected to exceed $1 billion in subsidies in 2025. A counter-trend is emerging: Virginia, Minnesota, Texas, and Georgia are all reconsidering or attaching conditions to their programs.

Community opposition at record levels. The Data Center Watch project tracked 142 grassroots groups (across 24 states) opposing data centers, growing to 188 groups (40 states) by Q2 2025. A cumulative $18 billion in projects have been directly blocked, and $46 billion delayed — a combined $64 billion. In Q2 2025 alone, $98 billion across 20 projects in 11 states were stalled. Project cancellations surged from 2 in 2023 to 25 in 2025. Core grievances include daily water consumption of 5 million gallons, permanent facilities creating only 15–100 jobs, noise levels reaching 100 decibels, and residential electricity rates rising 11.5% in 2025. Senator Bernie Sanders called for a national construction moratorium in December 2025.

The ADVANCE Act and nuclear energy. Signed in July 2024, the ADVANCE Act streamlines NRC licensing and sets a 25-month review deadline for new reactors at existing nuclear plant sites. A May 2025 executive order targets quadrupling nuclear capacity from 100 GW to 400 GW by 2050. Key nuclear-data center deals include: Talen Energy/Amazon's $18 billion / 1,920 MW / 17-year PPA (Susquehanna); Microsoft/Constellation's $1.6 billion / 835 MW / 20-year PPA (Three Mile Island restart, targeting 2028); and Meta's agreement with TerraPower for 8 Natrium reactors (2.6 GW nuclear + 1.2 GW storage). Google signed the first corporate SMR fleet deal with Kairos Power for 500 MW by 2035, with the first unit online by 2030. However, no SMRs are currently operational in the U.S. — the earliest commercial deployments are expected in the late 2020s or early 2030s.

North American AI-Driven Supply-Demand Dynamics: A Historic Inflection Point

Net absorption surges. Full-year 2025 net absorption across major markets reached 2,497.6 MW (CBRE); datacenterHawk's broader tracking scope shows 15+ GW. The 2024 full-year figure of approximately 4.4 GW (JLL) represented a fourfold increase from 2020. Under-construction pre-lease rates stand at 74.3% (CBRE), with pre-lease timelines extending 3–4 years out.

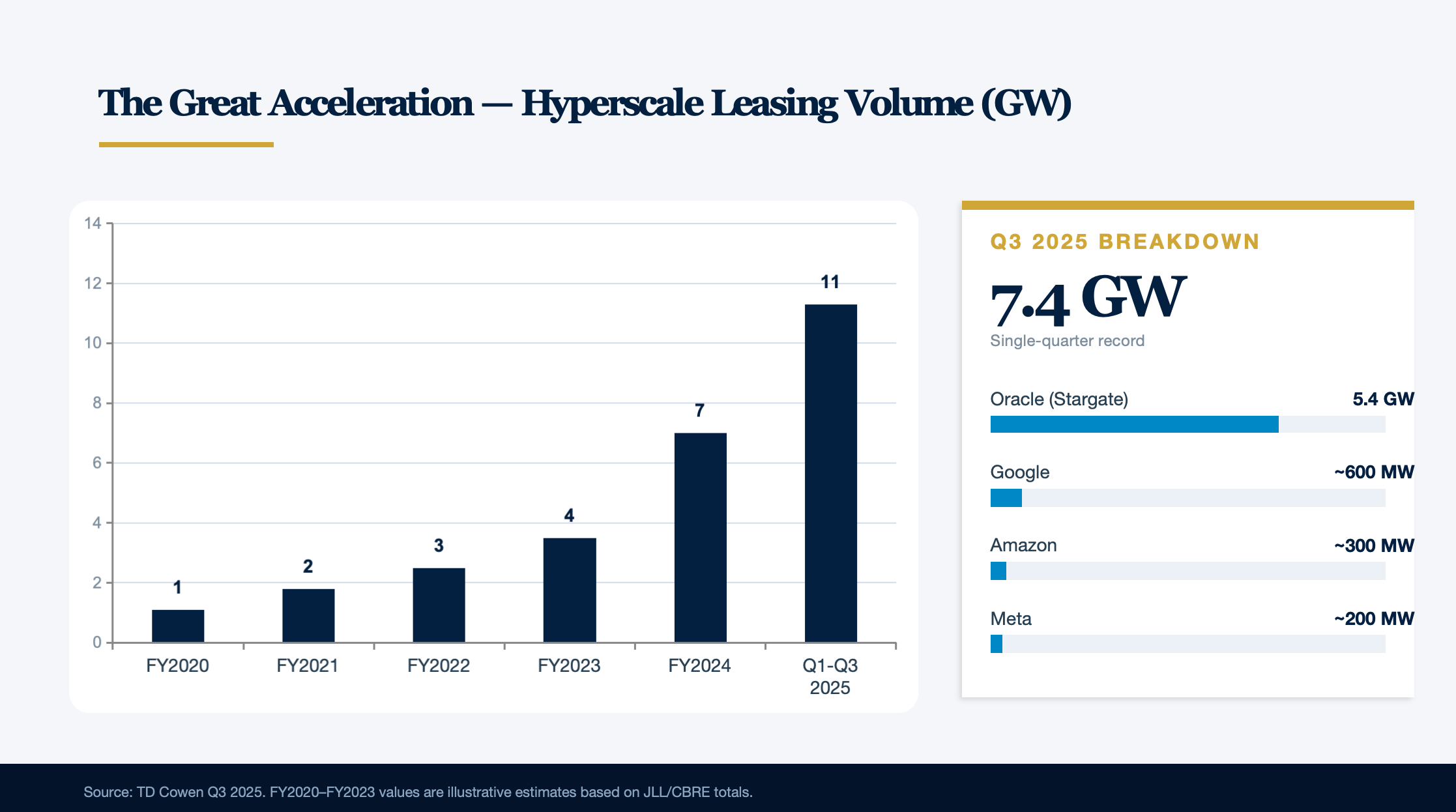

The "Great Acceleration" in hyperscale leasing. TD Cowen confirmed that Q3 2025 single-quarter leasing volume reached 7.4 GW — exceeding the full-year 2024 total of 7 GW. Oracle accounted for 5.4 GW (supporting Stargate), Google ~600 MW, Amazon ~300 MW, and Meta ~200 MW. The first three quarters of 2025 aggregated to 11.3 GW. TD Cowen called this "the most significant demand inflection since the data center industry's inception."

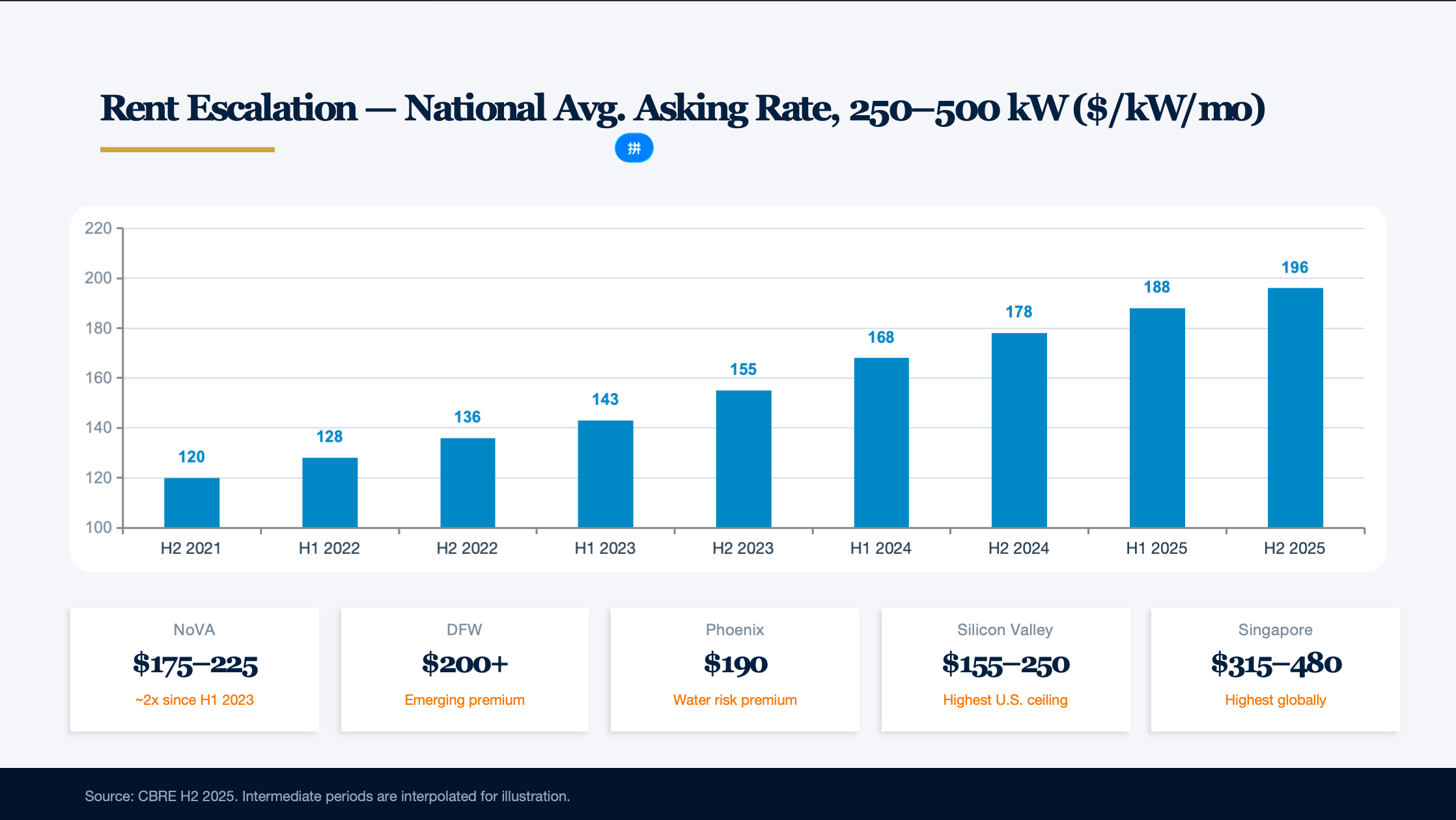

Rents continue to climb. The national average asking rate for 250–500 kW demand rose from approximately $120/kW/month in H2 2021 to $195.94/kW/month in H2 2025 (CBRE) — a 63%+ increase over four years and the fourth consecutive year of growth. Large-block 10–30 MW demand saw even steeper 19% increases. NoVA wholesale rents broke through $215/kW/month in Q2 2025 — a new all-time high. CBRE expects rents to remain above $200/kW/month in 2026.

Part II: Europe — Regulatory-Driven Green Transformation and Expansion

EMEA operating capacity stands at 10.3 GW (Cushman & Wakefield H1 2025, up 21% YoY), with 2.6 GW under construction, 11.5 GW in planning, and a 24.4 GW total pipeline (up 43% YoY). New capacity additions of approximately 850 MW in 2025 and a projected 710 MW in 2026 are expected to fall short of 848 MW in projected demand, driving vacancy still lower.

Vacancy is projected to fall to approximately 6.5% by end of 2026 — a historic low (CBRE European Data Centres Outlook 2026), down dramatically from 20.6% in 2019.

European construction costs exceed U.S. levels. Turner & Townsend's 2025 index shows Zurich at $14.2/W, Paris and Amsterdam at $10.8/W, Madrid and Dublin at $10.0/W, versus Atlanta at $9.9/W, Phoenix at $9.8/W, and Charlotte at $9.5/W. Drivers include: stricter sustainability regulation (EED compliance costs), limited contractor pools, higher labor costs (UK MEP wages up 12% YoY in 2025), transformer delivery times extending from 26 to 42 weeks, post-Brexit skills shortages, and more complex planning environments. 60% of industry respondents expect construction costs to increase by 5–15% in 2026.

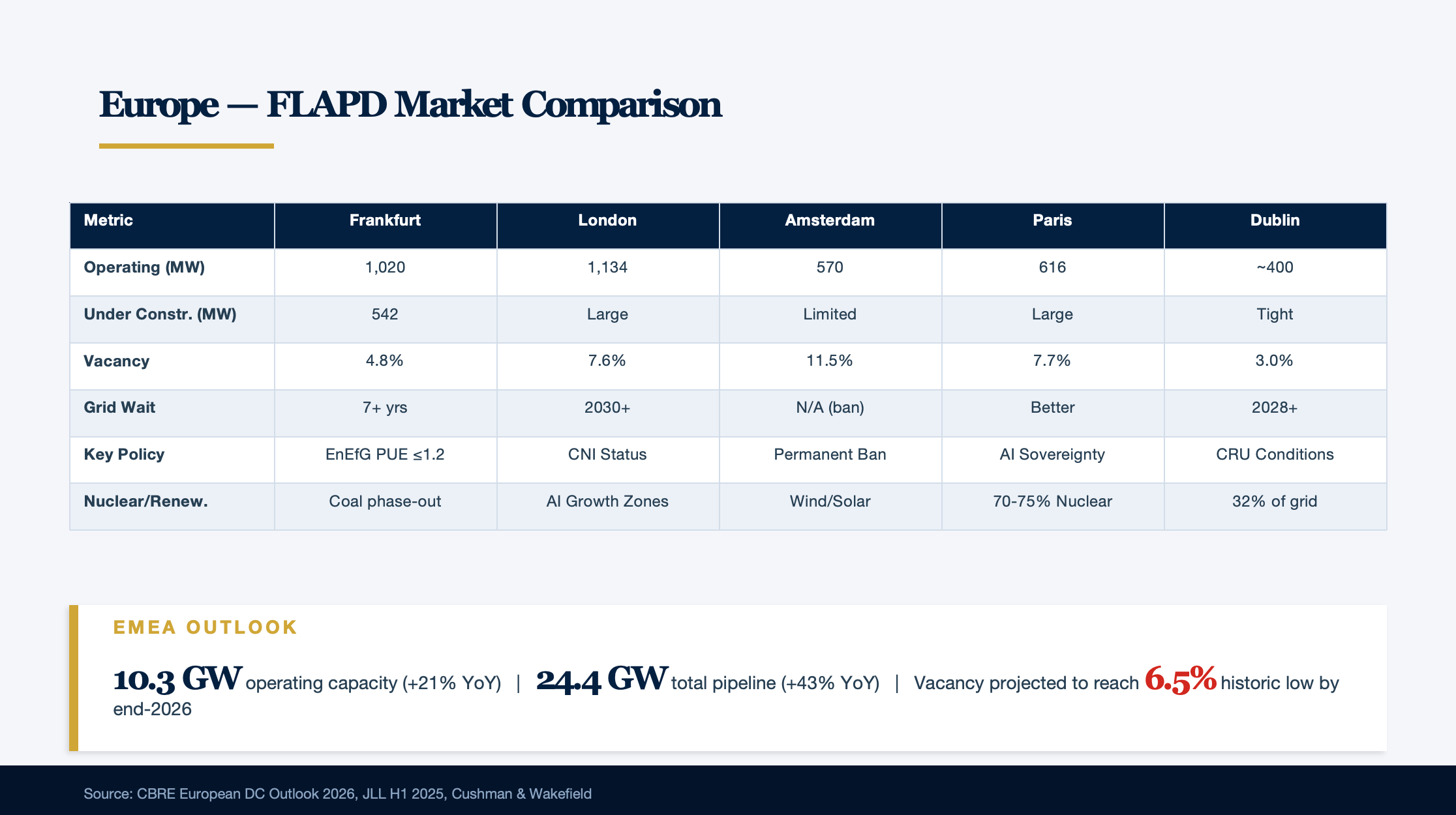

The FLAPD Five: Divergent Paths Among Core Markets

Frankfurt reached 1,020 MW of operating capacity (CBRE Q2 2025), becoming the second European city after London to breach 1 GW. Vacancy is 4.8%, projected to fall to 3.4% by year-end. Approximately 542 MW is under construction. Frankfurt faces unique regulatory pressure — Germany's Energy Efficiency Act (EnEfG), effective September 2023, imposes strict requirements: new data centers must achieve PUE ≤ 1.2 by July 2026; 100% renewable energy supply by January 2027; and waste heat utilization ≥ 20% by July 2028. Grid interconnection wait times exceed 7 years, with some developers shifting 30–40 km west to find power. However, the 2025 CDU/SPD coalition agreement signals potential relaxation of PUE and waste heat requirements. Hyperscaler investment in Germany is substantial: Microsoft €3.2 billion, AWS €8.8 billion (through 2026), Google €5.5 billion (through 2029).

London maintains its position as the largest EMEA market with 1,134 MW of operating capacity, but faces severe growth bottlenecks. West London's grid is fully allocated through 2029, with new projects waiting until 2030 or later. National Grid ESO has suspended new 132 kV connection offers in Greater London; self-built substations require an additional £150 million per 100 MW. Data centers already consume 18% of West London's electricity. Alternative zones are emerging rapidly — East London (Dagenham, Havering), Crawley, and northern regions. Vacancy has fallen to a historic low of 7.6% (JLL H1 2025), with large-block (5 MW+) vacancy at just 5.9%. The UK government announced a £14 billion AI data center program in January 2025, designating data centers as Critical National Infrastructure and establishing AI Growth Zones (minimum 500 MW each).

Amsterdam has the most restrictive policy environment among the FLAPD markets. Operating capacity stands at 570 MW, having been overtaken by Paris to drop to Europe's third-largest. Policy evolution: July 2019 sudden moratorium → 2022 lift with PUE ≤ 1.2 conditions → November 2022 national ban on hyperscale (>10 hectares and >70 MW) → April 2025 Amsterdam announces a permanent ban on new data center construction and expansion, with reassessment in 2030. This is not a "2035 ban" — there is no specific 2035-targeted legislation. The actual situation is an ongoing national hyperscale ban plus Amsterdam's comprehensive new-build prohibition. Netherlands data center count declined from 189 in 2019 to 187 in 2023, with colocation operators falling from 111 to 95. Vacancy at 11.5% is the highest among the FLAPD markets, but demand is being artificially suppressed by policy — international wholesale demand has largely redirected to other European markets.

Paris is achieving leapfrog growth through France's AI sovereignty strategy. Operating capacity reached 616 MW (CBRE Q2 2025), overtaking Amsterdam to become Europe's third-largest market in 2024. Vacancy plunged from 16.1% to 7.7% within a year — the steepest decline of any market. Early-stage pipeline exceeds 1.8 GW. France's AI action plan has announced €109 billion in investment, headlined by a 1.4 GW Paris AI Supercampus — a joint €8.5 billion venture between MGX (Abu Dhabi), Bpifrance, NVIDIA, and Mistral AI, breaking ground in H2 2026 with operations by 2028, billed as "Europe's largest AI campus." Brookfield has committed €20 billion to French AI infrastructure. France's core competitive advantage lies in nuclear power — approximately 70–75% of electricity comes from nuclear, providing stable, low-carbon, price-predictable baseload power.

Dublin has a vacancy rate of just 3% (JLL H1 2025), with large-block (5 MW+) vacancy even lower at 1.3% — pre-lease rates of 94.8% are the highest in EMEA. Data centers already consume 21% of Ireland's total electricity, projected to reach 32% by 2026. EirGrid has imposed a de facto grid connection moratorium on the Dublin region since 2021, expected to continue through 2028. In December 2025, the CRU issued a landmark final decision requiring large energy users (>10 MVA, Tier B) to: (1) provide dispatchable on-site/near-site generation matching 100% of maximum import capacity; (2) connect generation independently to the grid and participate in the SEM; (3) match 80% of annual consumption with additional renewable energy within Ireland (existing REFIT/RESS contracts ineligible); and (4) achieve renewable energy compliance within 6 years of energization. This effectively ends the 4-year moratorium, but on highly demanding terms.

Emerging European Markets: The "Second Tier" Takes Shape

The Nordics offer a unique combination of climate and renewable energy advantages — collectively sourcing 90%+ of electricity from renewables, with prices 40–50% below Western European core markets. Finland leads in growth (CAGR 9.10%), with a pipeline exceeding 5 GW. TikTok is investing €1 billion in Finland; XTX Markets is building a 250 MW supercompute campus in Kajaani for over €1 billion. In Sweden, Brookfield announced a $10 billion AI data center investment in Strängnäs (initial 300 MW, expandable to 750 MW) — the largest planned AI infrastructure cluster in Europe. Norway has attracted the OpenAI Stargate Norway project (Narvik, 230 MW renewable-powered AI campus), while CoreWeave has committed $2.2 billion to three Nordic data centers. Iceland, with 100% renewable energy (geothermal + hydro) and year-round free cooling, is emerging as ideal for energy-intensive AI workloads.

Southern Europe is experiencing an unprecedented investment boom. Portugal's Start Campus SINES is Europe's largest single colocation site — 1.2 GW total capacity, €8.5 billion total investment. The first facility SIN01 (26 MW) went live in April 2025; subsequent buildings (SIN02–06) scale up to 240 MW each, targeting rack densities of up to 700 kW/rack, PUE of 1.1, and zero WUE (seawater cooling). Microsoft has announced a $10 billion investment at Start Campus. Spain's market is valued at $6.89 billion (2025), with IT load CAGR of 23.92%. Italy/Milan has been elevated to "Powerhouse" market status by Cushman & Wakefield, with projected total capacity reaching 1.2 GW. Greece/Athens has planned capacity of 250+ MW — 6 times existing capacity — and has been upgraded to "Developing" market status.

Poland/Warsaw is Central and Eastern Europe's bridgehead — installed capacity of 660 MW (2025), projected to reach 1,000 MW by 2030. Hyperscale and enterprise AI commitments exceed $6 billion. Grid interconnection takes approximately 18 months, with an annual ICT talent gap of 50,000 professionals.

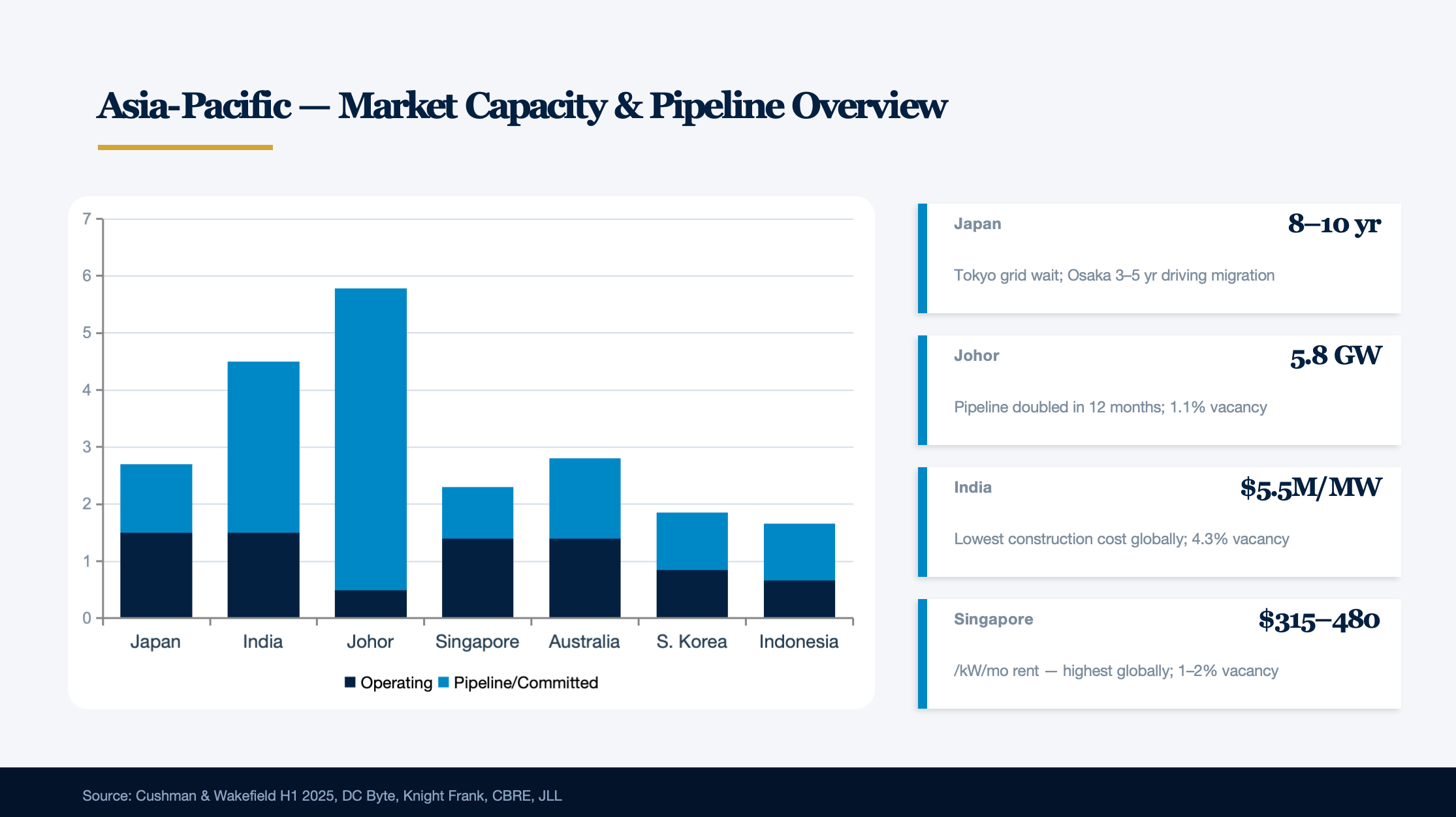

Part III: Asia-Pacific — An AI Investment Tsunami Sweeps the Region

Asia-Pacific is experiencing the most dramatic data center expansion wave globally. Japan's construction pipeline exceeds 1.2 GW, Johor has 5.8 GW of committed capacity, and India's operational capacity has surpassed 1.5 GW — these three figures encapsulate a core reality: AI-driven compute demand is rewriting the Asia-Pacific data center map, creating a once-in-a-decade window for M&A investors.

Japan — Structural Opportunity Behind the Power Bottleneck

Three Markets Diverge; Osaka and Hokkaido Rise

Japan's data center market is valued at approximately $12.76 billion in 2025 (Arizton), with operational IT load capacity of approximately 1.5 GW (Cushman & Wakefield H1 2025), projected to reach $38.9 billion by 2031 (CAGR 20.42%). Tokyo still commands 40.7% market share, but Osaka is the fastest-growing region at 13.28% CAGR.

Metric Tokyo Osaka Hokkaido
Operating capacity (est.) ~800–1,000 MW ~300–400 MW ~50 MW
Under construction / pipeline 1.3 GW+ 440 MW+ 300 MW+ (SoftBank)
Wholesale rent ($/kW/mo) $190–355 Slightly below Tokyo Lower (undisclosed)
Industrial power rate (¥/kWh) ~¥18–20 ~¥17–19 Lower (renewable PPA)
Grid connection wait 8–10 years (>10 MW) 3–5 years Relatively short
Natural disaster risk High (earthquake + liquefaction) Moderate (typhoon/storm surge) Low-moderate (heavy snow)

Tokyo's primary bottleneck is TEPCO power queues exceeding 36 months (154 kV connection waits can stretch to 7 years), while Osaka's 3–5-year timeline is driving significant developer migration to the Kansai region. OCCTO projects that electricity consumption from data centers and semiconductor factories will surge from 3.6 TWh in FY2025 to 51.4 TWh by FY2034 — roughly a 14-fold increase.

Emerging markets: Kyushu/Fukuoka is rising rapidly, with APL+GCI planning a 250 MW campus (first phase 120 MW, operational 2027). Hokkaido's SoftBank Tomakomai project spans 700,000 sqm with long-term potential of 1 GW, powered entirely by local renewables.

Japan Operator Landscape: NTT Leads; New Entrants Charge In

NTT is Japan's and one of the world's largest data center operators, with approximately 1,500 MW of global capacity, planning to double to 4 GW across 34 projects and targeting 5 GW+ within five years. Its most strategically significant move was the NTT DC REIT listing on the SGX on July 14, 2025, raising $773 million — Singapore's largest REIT IPO in over a decade, at 4.6x oversubscription and a projected annualized distribution yield of 7.5%.

SoftBank is the most aggressive AI data center player: the Sakai factory (initial 150 MW, expandable to 400 MW+, ¥100 billion investment, JV with OpenAI) and the Tomakomai project (initial 50 MW, long-term 1 GW). SoftBank also acquired DigitalBridge for $4 billion, gaining a global digital infrastructure management platform.

AirTrunk (Blackstone-owned) has invested over $8 billion in Japan across four campuses totaling approximately 530 MW. TOK1 secured a ¥191.6 billion ($1.24 billion) green loan — the largest data center financing in Japanese history. Princeton Digital Group is investing $1 billion in a 96 MW campus in Saitama, with rack density of 140 kW/rack.

Policy Tailwinds and FEFTA Scrutiny Coexist

The Japanese government offers multi-layered policy support. METI's Clean Energy Investment Subsidies provide up to 50% capex subsidies (from FY2026, over 5 years), with data centers explicitly included. The government has committed to investing at least ¥10 trillion ($66 billion) in AI by 2030.

Nuclear restart is a key variable. As of April 2026, Japan has 15 reactors operating, with total installed capacity of approximately 33 GW. TEPCO's Kashiwazaki-Kariwa Unit 6 restarted in February 2026 (1,356 MW) — TEPCO's first nuclear restart since Fukushima.

FEFTA foreign investment review requires prior notification and approval for acquisitions touching telecommunications and cybersecurity (triggered at 1% for listed companies). FY2024 filings hit a record 2,903. However, 2026 legislative amendments aim to narrow IT-sector review to critical cybersecurity operations only, potentially reducing the burden on pure real estate data center transactions.

M&A opportunity assessment: Yen depreciation (2024–2025 range: 145–160), relatively reasonable asset valuations, and increasing asset-sale willingness from domestic companies (NEC has already divested data centers; Fujitsu and Hitachi may follow) create a favorable entry window for foreign investors. Osaka Bay Area brownfield conversions of former factory sites (with existing power capacity) offer a low-cost entry path. Tokyo central-area data center development land commands premiums of up to 770% (for power-secured parcels).

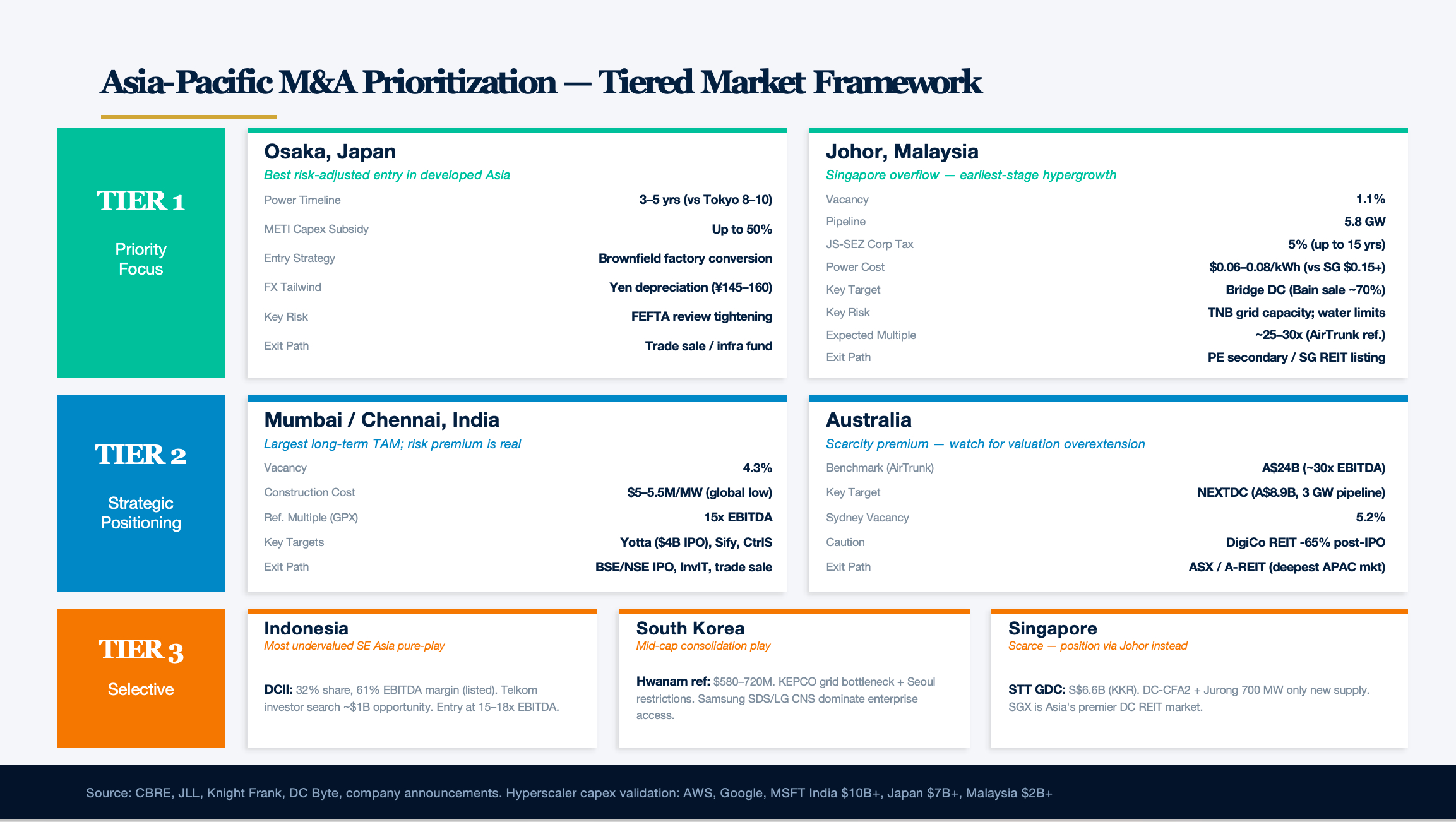

Southeast Asia — The Johor Frenzy and Singapore Scarcity

Singapore: The Tightest Supply and Highest Rents Globally

Singapore's data center market is characterized by extreme undersupply: operating capacity of approximately 1.4 GW, vacancy of just 1–2% (CBRE Q1 2025), available capacity dipping as low as 4 MW, and wholesale rents of $315–$480/kW/month — the highest in the world. This scarcity stems from a de facto construction moratorium imposed in 2019.

DC-CFA2 was released in December 2025, opening at least 200 MW of new capacity. Selection criteria are significantly more stringent than the first round: PUE ≤ 1.25, renewable energy share ≥ 50% (from qualified green pathways; conventional RECs ineligible), and mandatory Green Mark for Data Centres 2024 Platinum certification.

The Jurong Island 700 MW Low-Carbon Data Center Park, announced in October 2025, is a joint EDB-JTC development. At 700 MW, it represents 50% of Singapore's existing capacity — a transformative expansion.

Of particular note, KKR and Singtel are acquiring the remaining 82% of STT GDC for approximately S$6.6 billion, at an implied enterprise value of approximately S$13.8 billion, expected to close in H2 2026 — one of the largest data center M&A transactions in Southeast Asia.

Johor: Asia-Pacific's Most Aggressive Data Center Expansion

Johor is experiencing the most concentrated investment surge in data center construction history. Per DC Byte (July 2025), Johor has 487 MW operational, 324 MW under construction, 1.4 GW committed, and 3.4 GW in early-stage planning. Knight Frank H1 2025 reports total pipeline supply of approximately 5.8 GW (doubling within 12 months), with vacancy of just 1.1%. The Johor state government has approved 51 projects totaling RM 182.96 billion in investment. Cushman & Wakefield projects Johor will become a 1 GW market by end of 2026.

Key projects:

Operator Capacity Investment Status
YTL Data Centers 600 MW RM 10 billion Operational / Under construction
Bridge Data Centres MY07 400 MW Under construction
AirTrunk JHB1+JHB2 420 MW+ RM 9.7 billion Operational / Under construction
Princeton Digital JH1+ 350 MW+ Operational / Under construction
Microsoft Multi-phase US$2.2 billion Under construction / Planned
Currenc Group 500 MW Planned

TNB (Tenaga Nasional) grid expansion is the critical bottleneck. TNB has signed 31 ESAs totaling 4,700 MW of demand and received new DC applications exceeding 11,000 MW (over 40% of Peninsular Malaysia's existing installed capacity). Actual DC utilization is only 47% of allocated capacity, raising waste concerns. Base electricity rates were raised to 45.62 sen/kWh from July 2025, but remain among the lowest in Asia-Pacific (~US$0.10/kWh vs. Singapore's US$0.27/kWh).

Core risk — water constraints: Johor has mandated that DC investors defer water-cooled expansion by at least 18 months (to mid-2027) and has stopped approving Tier 1/2 data centers. 2024 DC water allocation was just 6.10 MLD — only 21% of the amount requested. Projected 2030 DC water demand reaches 384 MLD.

The JS-SEZ (Johor-Singapore Special Economic Zone), signed in January 2025, offers qualifying enterprises a 5% corporate tax rate (up to 15 years). Singapore-Johor fiber latency is <5 ms. Singapore enterprises are broadly adopting a "dual hub" strategy: latency-sensitive workloads remain in Singapore, while GPU training and AI inference migrate to Johor.

Indonesia, Thailand, Vietnam, and the Philippines Each Occupy Distinct Positions

Indonesia: Jakarta's market stands at approximately 660 MW in 2025, with vacancy declining from 36% to 31%. DCI Indonesia (DCII) is the largest operator with 155 MW of 2025 capacity, revenue of IDR 2.54 trillion (+40.1%), and EBITDA margin of 61%. DCI-H3 Sky Bintan is planned for over 1,000 MW. Telkom is seeking strategic investors, potentially unlocking a ~US$1 billion opportunity — a notable M&A target.

Thailand: H1 2025 saw 28 approved projects totaling $16.1 billion investment (20x YoY growth). BOI offers 8-year corporate income tax exemption for high-efficiency DCs, with 100% foreign ownership permitted. Construction cost of only $7.1M/MW, though power at $108/MWh is mid-range.

Vietnam: Market is emerging with 41 DCs and 221 MW. 100% foreign ownership became effective January 2025. Construction cost is among Asia-Pacific's lowest at $6–8M/MW. Power supply reliability remains the core challenge.

Philippines: Manila at approximately 560 MW in 2025, with power costs of $154/MWh among the highest in Southeast Asia. SM Investments' August 2025 exit from the DC business, citing power costs and natural disaster risk, is a signal M&A buyers should note.

India — 3 GW Ambition and 60% Idle GPUs

Four Markets Drive 1.5 GW of Operational Capacity

India's 2025 data center operational IT load capacity reaches 1,123–1,530 MW (JLL/CBRE), with national vacancy at just 4.3% — extremely tight. Investment commitments from 2019–2025 exceed $94 billion cumulatively. Construction cost is among the world's lowest at approximately $5–5.5M/MW.

Metric Mumbai Chennai Hyderabad Pune
Operating capacity ~594 MW ~550 MW ~50 → rapid growth ~90–100 MW
Market share 41–54% 20–23% ~13% ~5%
Power bottleneck 36-month backlog Grid delays Relatively better Better than Mumbai
Submarine cable connectivity 2+ landing stations 7+ cables / 420+ Tbps None direct None direct

Chennai's core advantage is submarine cable connectivity — 7+ active cables with aggregate bandwidth of 420+ Tbps, positioning it as the top choice for latency-sensitive use cases such as gaming and financial trading.

Operator Landscape: GPU Concentration Is Striking

Yotta Infrastructure (Hiranandani Group) confirmed in a February 2026 CNBC interview that it holds 60–70% of India's GPU capacity. Currently operating approximately 10,000 H100 GPUs, with thousands of B200s deployed and 20,736 Blackwell Ultra B300 GPUs planned for August 2026 deployment. IPO target valuation: $4 billion.

AdaniConneX (Adani 50:50 EdgeConneX JV) is targeting 1 GW by 2030. Most notably, it signed a $15 billion AI data center partnership with Google (Visakhapatnam, GW-scale), including submarine cable and renewable energy infrastructure.

Reliance Jio has planned the world's largest single data center — Jamnagar 3 GW, with $20–30 billion investment, powered by a 5,000-acre green energy complex, targeting 24-month completion. Jio IPO is planned for H1 2026 at a target valuation of $120 billion.

Indian Policy: Interstate Competition Is Fierce; National Framework Pending

India classified data centers in the "Harmonized Master List" in 2022, granting infrastructure status and access to long-term, low-cost financing. The latest 2025 draft national policy proposes up to 20-year conditional tax exemptions, 100% electricity duty exemption, and data center SEZs. However, significant state-level policy variation persists, with no unified national policy.

100% FDI is open through the automatic route, but border-country entities (China, etc.) require government approval. In practice, approximately 30 separate approvals are needed. Key reference transactions: Equinix acquired GPX at 15x forward EBITDA ($161 million), and Blackstone + Panchshil committed $2.3 billion (500 MW).

Australia — The AirTrunk Benchmark and NEXTDC Deep Dive

Sydney Vacancy Falls to 5.2%; Western Sydney Becomes the New Engine

Australia's operating capacity stands at approximately 1.3–1.5 GW (2025), with a total pipeline of ~2.8 GW. Sydney H1 2025 vacancy plummeted from 9% to 5.2%, with average lease-up time compressing from 40 months (2020) to 13 months.

AirTrunk was acquired by Blackstone + CPP for A$24 billion (US$16.1 billion) — the largest data center transaction in history. Five Australian campuses total over 1.2 GW, with 800+ MW committed to customers. Reports from April 2026 indicate AirTrunk is planning a REIT-style IPO in Singapore to raise $1.5 billion.

NEXTDC (ASX:NXT) — Australia's Only Large-Scale Independent Pure-Play Data Center Stock

NEXTDC is the key reference for understanding Australian data center valuations.

Metric FY25 1H26
Revenue A$350.2M (+14%) A$189.2M (+13%)
EBITDA A$216.7M (+6%) A$115.3M (+9%)
Contracted utilization 244.8 MW (+42%) 416.6 MW (+137%)
Billed utilization 110.9 MW 119.8 MW
Forward order book 296.8 MW (FY26–29 conversion)

Market cap of approximately A$8.9–9.3 billion; EV/EBITDA ~55x (TTM) — well above Equinix's 25–30x and Digital Realty's 20–25x, reflecting high growth expectations. Development pipeline totals over 3 GW, including S7 Eastern Creek (550+ MW, OpenAI MOU) and M4 Port Melbourne (150–162 MW, $2 billion AI Factory with liquid cooling). A full acquisition of NEXTDC would require approximately A$10–12 billion, which is feasible relative to AirTrunk's A$24 billion.

South Korea — Nuclear Advantage and Grid Bottlenecks

Seoul Vacancy Is Asia-Pacific's Second-Lowest; Power Limits Drive Decentralization

South Korea's data center operating capacity stands at approximately 850 MW (58 colocation facilities), with Seoul accounting for 52.1% and vacancy below 6% (Asia-Pacific's second-lowest after Singapore). Construction costs run approximately $10–11M/MW.

Seoul faces severe power supply constraints. KEPCO has announced restrictions on new power supply in the Seoul metropolitan area, extending power supply confirmation times to approximately 12 months. KEPCO debt exceeds KRW 202 trillion, severely constraining grid upgrade budgets.

SK + AWS Ulsan 1 GW Project: Asia-Pacific's Largest AI Data Center Partnership

Total investment of KRW 7 trillion (~$5.11 billion), with AWS contributing approximately $4 billion. First phase 41 MW (November 2027), second phase 103 MW (February 2029), long-term target 1 GW, deploying 60,000 GPUs — Korea's largest-scale deployment. Groundbreaking on August 29, 2025.

South Korea's nuclear fleet generates approximately 31% of total electricity, with 25 operating reactors totaling 30,054 MW. The government has reversed its predecessor's nuclear phase-out policy, planning 2 new reactors plus 1 SMR.

China — Accelerating Domestic Substitution and C-REIT Breakthrough

GDS and VNET Diverge; DayOne Could Reach $5 Billion Valuation

GDS Holdings FY2024 China revenue of RMB 10.322 billion (+5.5%), adjusted EBITDA margin of 47.2%. In Q1 2025, GDS secured 152 MW of AI-related orders — the largest single domestic booking ever. International operations, rebranded DayOne, raised over $2 billion in Series C funding (Coatue-led), with valuation potentially reaching $4–5 billion.

VNET Group FY2024 revenue of RMB 8.259 billion (+11.4%), with wholesale IDC revenue surging +125.4% in Q4. Turned to net profit (RMB 248 million) for the first time.

Chindata was taken private by Bain Capital for $3.16 billion (~9.4x EV/FY23E EBITDA). In March 2026, Bain is considering selling up to 70% of its stake (Citigroup/JPMorgan advising) — a significant M&A opportunity signal.

East-to-West Computing: 63% Rack Utilization Exposes Regional Imbalance

Across eight national hub nodes, total compute stands at 215.5 EFLOPS, with AI compute accounting for 80.8% and rack utilization of approximately 63% — meaning roughly half of installed cabinets remain idle. The core contradiction: eastern regions face undersupply while western regions lack sufficient local demand.

Domestic Chip Substitution Rate Surges from 15% to 30%

In China's 2024 AI accelerator market of 2.7+ million units: NVIDIA 66%, Huawei HiSilicon 23%, AMD 5%. Domestic brands shipped 820,000 units (penetration rate 30%, up from 15% in 2023). Jensen Huang acknowledged NVIDIA's China share fell from 95% four years ago to 50%. The April 2025 U.S. ban on H20 exports to China will further accelerate domestic substitution.

Huawei Ascend 910C (2025 mass production): FP16 peak 800 TFLOPS, HBM 128 GB. Inference performance reaches 60–80% of H100. Ascend holds 79% market share in municipal smart computing centers.

C-REIT Breakthrough: First Two Data Center REITs Approved

On June 18, 2025, the China Southern GDS Data Center REIT and China Southern Runze Technology REIT received CSRC registration approval — officially breaking the ice for China's public data center REITs. Globally, only 6 pure data center REITs exist (5 in the U.S. + 1 in Singapore); China's DC REITs are at a nascent stage, facing valuation challenges from rapid technology iteration and short hardware depreciation cycles (3–5 years).

The DeepSeek Effect: Jevons Paradox Drives Demand Up, Not Down

DeepSeek-V3 training cost was only $5.576 million (1/10th of Meta's open-source models); R1 inference costs are 95% lower than OpenAI o1. Yet the industry consensus holds: efficiency gains → cost reductions → broader enterprise adoption → net demand increase (Jevons Paradox). DeepSeek-V3.1 adopts UE8M0 FP8 Scale precision, specifically designed for domestic chips.

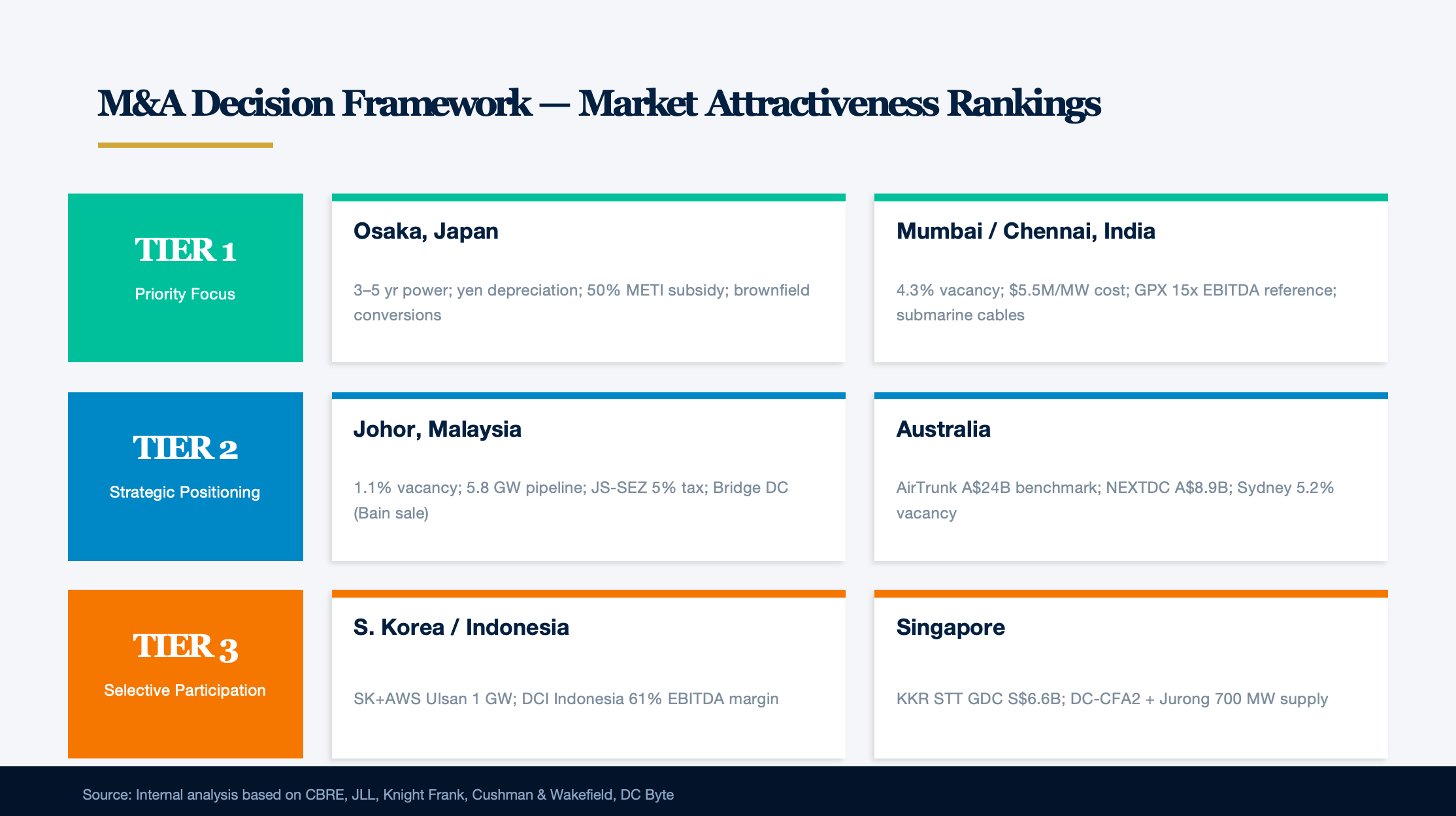

M&A Decision Framework: Key Takeaways

Tier 1 — Priority Focus

Osaka, Japan

Core thesis: Best risk-adjusted entry point in developed Asia.

Power access timeline of 3–5 years (far superior to Tokyo's 8–10 years), brownfield factory conversions with existing power capacity, yen depreciation lowering acquisition costs, and METI offering 50% capex subsidies. Domestic companies (NEC et al.) showing increased willingness to divest assets.
Key considerations:

  • Japanese enterprise customer relationships are dominated by NEC, Fujitsu, and NTT — foreign operator go-to-market capability is the critical success factor. Partnership or JV with a local incumbent may be required for customer access.
  • Osaka construction cost, while lower than Tokyo ($15.2/W, global highest), remains significantly above Southeast Asian markets. AI-ready retrofit costs (liquid cooling, high-density power distribution) may be underestimated.
  • FEFTA review for "critical infrastructure" category is tightening — timeline and conditions require early legal engagement.
  • Exit channels: Mature capital markets, but limited data center REIT universe. Trade sale to hyperscaler or infrastructure fund is the primary path. Tokyo Stock Exchange J-REIT structure available but underutilized for data centers.

Johor, Malaysia

Core thesis: Singapore overflow market with structural cost advantages at the earliest stage of hypergrowth.

1.1% vacancy and a 5.8 GW pipeline indicate a market in the early stages of explosive growth. Bridge Data Centres (Bain exploring sale of up to 70%) is an explicit, actionable M&A target. JS-SEZ's 5% corporate tax and electricity at $0.06–0.08/kWh (vs. Singapore $0.15+) provide structural cost advantages that are difficult to replicate.

Key considerations:

  • The strategic value is defined by geographic substitution — Singapore itself is nearly impossible to acquire new capacity (see Tier 3), making Johor the de facto expansion corridor for Singapore-centric workloads.
  • Water resource constraints are real but addressable through liquid cooling adoption (which is becoming standard for AI workloads regardless).
  • TNB grid capacity is the binding constraint — validate grid upgrade commitments and timelines before committing capital.
  • Bridge Data Centres (9 facilities, Bain Capital–backed, $2.8B secured financing in 2025) is the most clearly defined M&A opportunity in Southeast Asia. Valuation will likely reflect the 2024 AirTrunk benchmark (~25–30x EBITDA) given scarcity premium.
  • Exit channels: Limited public market options in Malaysia. Primary exit via secondary PE sale or strategic acquisition. Singapore REIT listing (Keppel DC REIT model) is a viable cross-border exit structure.

Tier 2 — Strategic Positioning

Mumbai / Chennai, India

Core thesis: Largest long-term TAM in Asia-Pacific, but risk premium is real, not mispriced.

4.3% vacancy and $5–5.5M/MW construction cost present compelling unit economics. Yotta IPO ($4 billion), Sify IPO, and potential CtrlS IPO provide valuation anchors. The GPX transaction at 15x EBITDA serves as a reference multiple. Chennai's submarine cable infrastructure is uniquely differentiated.

Key considerations:

  • The 15x EBITDA (GPX transaction) vs. 25–30x in developed markets reflects genuine risk premium, not pure valuation arbitrage. Grid reliability (frequent outages in secondary markets), land title complexity, and regulatory uncertainty in value-added telecom licensing for foreign investors are real discount factors.
  • Mumbai 4.3% vacancy requires granular analysis — distinguish Navi Mumbai/Airoli campus-level data from broader metro averages. Indian market internal dispersion is extreme.
  • Yotta's $4B IPO valuation requires scrutiny of underlying GPU asset composition — its reliance on NVIDIA H100 clusters and Huawei Ascend creates technology iteration risk analogous to CoreWeave's depreciation challenges.
  • AdaniConneX (1 GW planned, $10B+ investment) and NTT India (292 MW, 20% market share) are reshaping the competitive landscape — new entrants face both opportunity and intensifying competition.
  • Exit channels: Active IPO window (Yotta/Sify/CtrlS in pipeline). BSE/NSE listing is viable for scaled assets. Strategic sale to hyperscalers (AWS India expansion) provides alternative exit. InvIT (Infrastructure Investment Trust) structure available as REIT-equivalent.

Australia

Core thesis: Mature market with scarcity premium, but watch for valuation overextension.

AirTrunk's A$24 billion transaction (~A$30M/MW) establishes the valuation benchmark. NEXTDC (A$8.9 billion market cap, 3 GW pipeline) is the only large-scale independent target on the ASX. Sydney's 5.2% vacancy supports rental upside.

Key considerations:

  • AirTrunk's ~30x EBITDA was a peak-cycle Blackstone acquisition — using it as a floor valuation for other assets risks overpayment.
  • DigiCo REIT (Global Switch Australia) declined 65% post-IPO (A$5.00 → ~A$1.74) — a cautionary signal that Australian public markets do not uniformly support data center REIT premiums.
  • NEXTDC's A$8.9B market cap already prices in significant growth expectations from its 3 GW pipeline. Margin of safety is limited at current levels.
  • Melbourne and Perth are emerging as lower-cost alternatives to Sydney, with improving power availability.
  • Exit channels: Deep ASX liquidity. A-REIT structure well-established. Trade sale to global PE (Blackstone/KKR precedent) highly viable. Most liquid exit market in Asia-Pacific.

Tier 3 — Selective Participation

Indonesia

Core thesis: Potentially the most undervalued pure-play opportunity in Southeast Asia.

DCI Indonesia (DCII, listed, 32% market share, 61% EBITDA margin) is one of Southeast Asia's most attractive listed targets. Telkom's strategic investor search could unlock a ~$1 billion opportunity. 280 million population with early-stage digitalization provides the largest untapped demand pool in ASEAN.

Key considerations:

  • DCII's 61% EBITDA margin and 32% market share combination is exceptional — superior to most listed global peers. The listed status provides transparency and liquidity rare in emerging Southeast Asian markets.
  • Telkom's strategic investor process, if executed, could offer entry at 15–18x EBITDA — attractive relative to 25–30x in developed markets.
  • Long-term growth ceiling is higher than South Korea given demographic scale and digitalization trajectory.
  • Regulatory environment (data localization requirements, foreign ownership limits in telecom) requires careful structuring.
  • Exit channels: IDX listing provides liquidity for DCII. For private assets, exit depends on strategic sale or secondary PE transaction. No established REIT structure for data centers.

South Korea

Macquarie's Hwanam transaction ($580–720 million) provides valuation reference. Mid-cap operator consolidation opportunities exist. However, KEPCO grid bottlenecks and Seoul construction restrictions are binding constraints. Samsung SDS and LG CNS dominate enterprise relationships, limiting foreign operator customer access.

Exit channels: KOSPI/KOSDAQ listing viable but data center sector coverage is thin. K-REIT structure underdeveloped for digital infrastructure. Trade sale is primary path.

Singapore

Extremely scarce but nearly impossible to acquire new capacity. KKR's STT GDC 82% acquisition (S$6.6 billion) establishes valuation benchmark. Keppel DC REIT's S$1 billion internal transaction merits monitoring. DC-CFA2 and Jurong Island's 700 MW are the only new supply entry points.

Strategic note: Singapore's capacity scarcity is precisely what makes Johor (Tier 1) strategically valuable. Consider Singapore positioning through Johor assets with Singapore connectivity.

Exit channels: SGX is the premier REIT market in Asia for data centers (Keppel DC REIT, NTT DC REIT precedents). Highest exit liquidity for REIT-structured assets in the region.

Cross-Cutting Strategic Notes

Exit channel liquidity directly impacts achievable IRR. The ranking above implicitly factors in exit feasibility: Australia and Singapore offer the deepest public markets, India has an active IPO window, Japan has mature capital markets but limited DC REIT vehicles, while Johor and Indonesia depend primarily on private transactions.

The "Singapore + Johor" corridor should be evaluated as a single strategic unit. Singapore provides the demand anchor (financial services, regional HQs), Johor provides the supply capacity. Assets spanning both markets command a structural premium.

Hyperscaler capex allocation is the leading indicator. AWS, Google, and Microsoft's announced investments in specific markets (India $10B+, Japan $7B+, Malaysia $2B+, Indonesia $1.5B+) serve as demand validation. Markets without hyperscaler commitments carry higher demand risk regardless of supply-side attractiveness.

Five Structural Themes

Power is the binding constraint on everything. From Tokyo's 8–10 years to Seoul's 12+ months to Navi Mumbai's 36 months, power interconnection timelines determine project viability. Existing assets with secured power command premiums of up to 770% (Tokyo). TNB Johor has signed 4,700 MW but received 11,000 MW of applications — the gap is stark.

The AI density revolution is transforming the construction paradigm. Rack densities are leaping from 8–10 kW toward 20–40 kW (and as high as 140 kW at Princeton Tokyo). Liquid cooling is shifting from optional to standard. This means existing air-cooled facilities face costly retrofits, capex intensity for new builds is rising sharply, but per-square-meter revenue is rising commensurately.

REIT-ification is accelerating capital recycling. NTT DC REIT's SGX listing ($773 million), AirTrunk's planned REIT IPO ($1.5 billion), China's first C-REITs, and DigiCo REIT's ASX listing — REITs are becoming the core instrument for data center operators to recycle capital and fund expansion.

Domestic chip substitution creates unique risk and opportunity in the China market. Huawei Ascend penetration has moved from 15% to 30%, with further acceleration inevitable following the H20 export ban. Domestic chips' "volume-for-quality" strategy is driving mega-cluster and higher-density power demand. However, technology iteration uncertainty and geopolitical risk demand cautious assessment of China market exposure.

Water is scarcer than power. Johor has mandated an 18-month deferral of water-cooled expansion, with 2024 water allocation at just 21% of requested volumes. Singapore has only 733 km² of land area. This will drive zero-water cooling technologies (air cooling, closed-loop liquid cooling) to become a source of competitive differentiation and M&A valuation premiums.

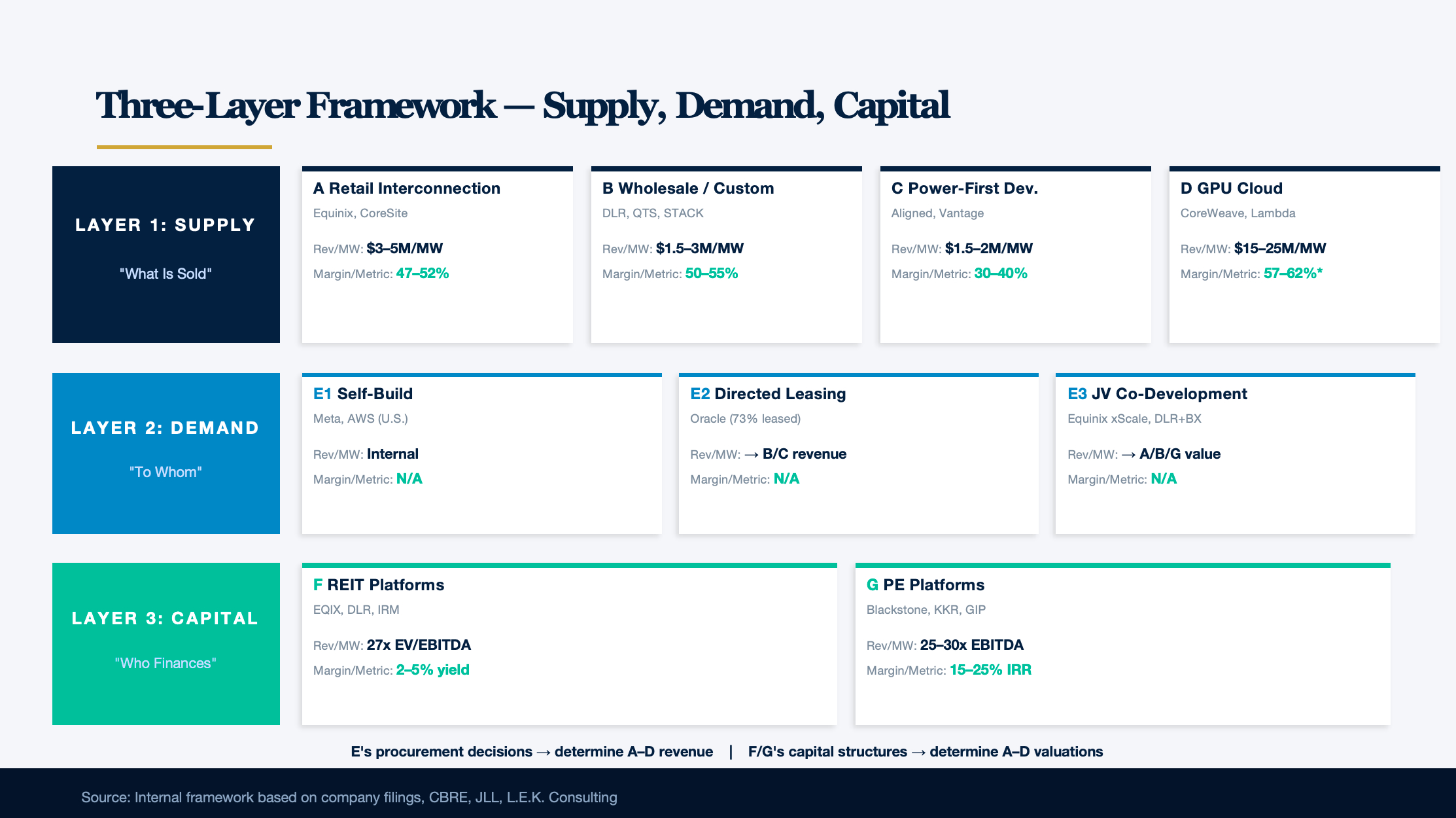

Chapter IV: Data Center Three-Layer, Seven-Category Business Model Framework: Landmark Companies & Financial Landscape

The data center industry has evolved from simple "rack-space rental" into a three-layer composite ecosystem spanning supply, demand, and capital. 2024–2025 saw unprecedented capital inflows — the top five hyperscalers' combined annual capex surged from ~$250 billion to ~$440 billion, while private-market transaction multiples climbed to 25–30x EV/EBITDA, driven by exponential demand for power and compute from AI training and inference.

This report maps the complete business-model taxonomy using a "Supply–Demand–Capital" three-layer framework:

  • Layer 1 (Supply): Four operator business models — A Retail Colocation, B Wholesale/Custom, C Power-First Development, D GPU Cloud. From A to D, product complexity, capital intensity, and technology risk increase progressively, but all four are "suppliers delivering products to customers for revenue."
  • Layer 2 (Demand): Hyperscale capacity procurement — Category E, encompassing self-build (E1), directed leasing (E2), and joint-venture co-development (E3). Shifts in hyperscale procurement strategy directly create or destroy value for Layer 1 targets.
  • Layer 3 (Capital): Asset ownership & financing structures — F REIT Platforms, G Private Equity Platforms. These determine ownership, cost of capital, and exit channels for Layer 1 assets.

Each layer answers a distinct question: Layer 1 answers "what is sold," Layer 2 answers "to whom," Layer 3 answers "who finances it." The inter-layer relationships are clear: E's procurement decisions determine A–D revenue; F/G's capital structures determine A–D valuations.

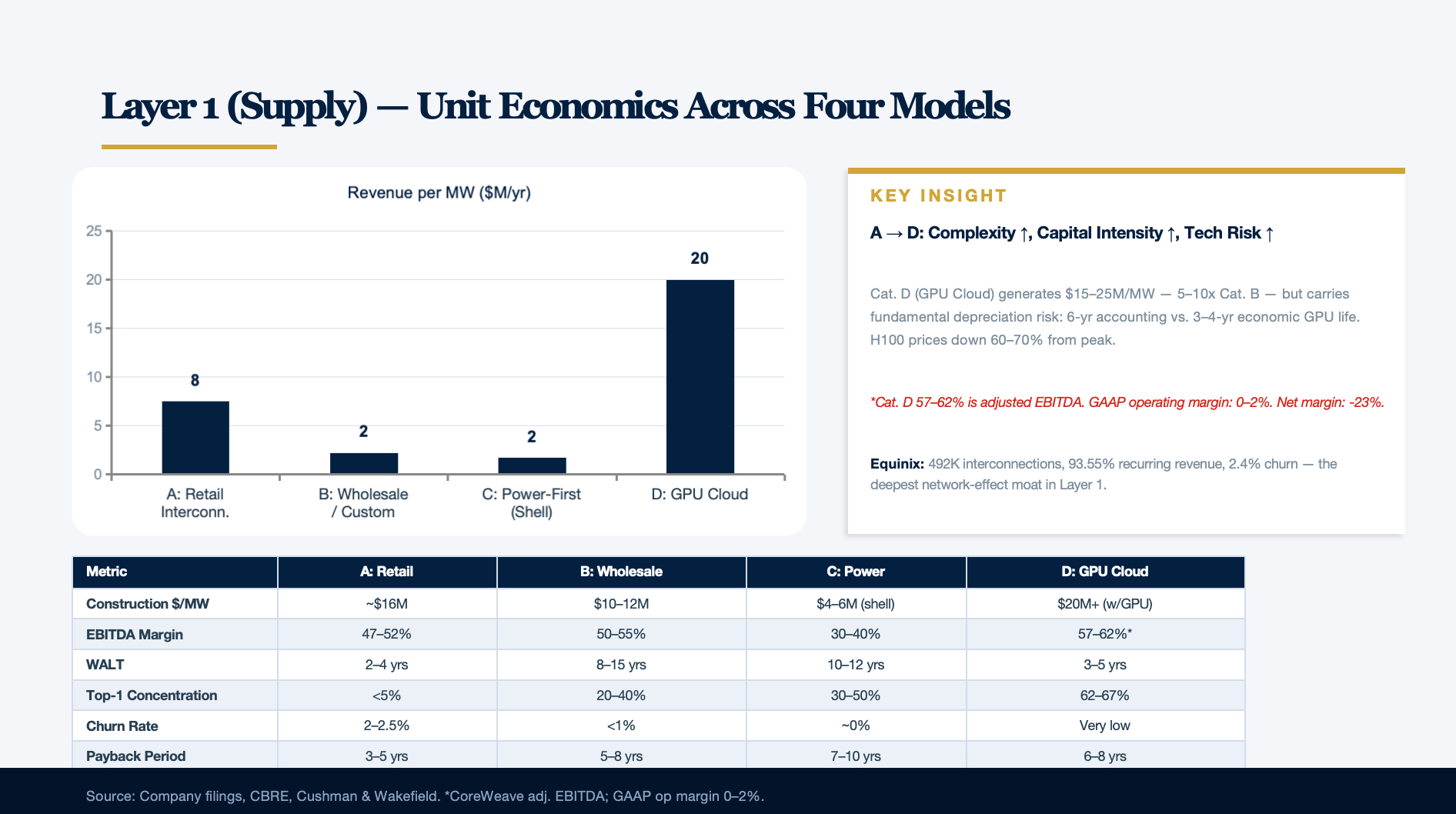

Layer 1: Supply — Four Operator Business Models

A. Retail Interconnection Colocation: Network Effects as Core Moat

Retail interconnection colocation charges by rack/cabinet/kW, with typical deployments ≤250 kW. The model's essence lies in the value-added revenue system built around cross-connects. Equinix, the global benchmark, achieved FY2024 revenue of $8.748 billion (+7% YoY, +8% normalized), adjusted EBITDA of $4.097 billion at a 47% margin (up 160 bps YoY), with FY2025 guidance rising further to 49%.

Unit economics & pricing. Average asking rates for North American Tier 1 retail colocation reached $195.94/kW/month in H2 2025, up 6.5% YoY. Equinix's global average cross-connect fee is $254/month (Americas $341, EMEA $158, APAC $232), annualizing to roughly $3,048/connection. Interconnection revenue accounts for 19% of Equinix's recurring revenue, grew 9% in FY2024, and exceeded $400 million in a single quarter for the first time in Q2 2025. On a per-MW basis, retail colocation generates approximately $3–5 million annually, significantly above wholesale's $1–2 million.

Equinix's value-added services matrix includes Smart Hands remote operations ($50–150/15 min), Equinix Fabric software-defined interconnection (provisioned capacity exceeding 100 terabits), Network Edge virtual network functions, and Equinix Metal bare-metal-as-a-service. Physical cross-connects generate 75% of interconnection revenue, with the remaining 25% from Fabric, Internet Exchange, and Metro Connect virtual interconnection services.

Contract structure & customer stickiness. Equinix enterprise customers average 3.8-year contract terms with annual escalators typically at 2.5–5% (CPI-linked or fixed). Quarterly MRR churn remains in the 2.0–2.5% range (2024 full-year average 2.4%), with "only single-digit percentages of churn representing customers leaving entirely — most are resizing or migrating within the Equinix ecosystem" (CEO Charles Meyers). Digital Realty recorded renewal spreads of 4.7% (cash) / 9.1% (GAAP) in Q4 2024, and 15.2% / 27.5% in Q3 2024, reflecting extreme supply-demand tightness.

Competitive moat analysis. Equinix operates 270+ data centers across 77 markets, serves 10,000+ customers and 2,000+ network providers, and held over 492,000 interconnections as of Q2 2025 — more than double its nearest competitor. This interconnection density required 25+ years of continuous accumulation and is virtually impossible for new entrants to replicate. Recurring revenue share stands at 93.55%. However, Hindenburg Research's March 2024 short report flagged that hyperscale customers are developing services that bypass Equinix interconnection, and interconnection revenue growth decelerated from 16.7% in 2018 to 3.4% in 2023.

The interconnection/network-hub model fundamentally relies on bilateral network effects: more networks and cloud providers → greater value for enterprise customers → more enterprises → attracting more networks. This flywheel required decades to build — Equinix has constructed 492,000+ interconnections since its 1998 founding.

Internet Exchange Points (IXP) commercial value. Roughly 1,200 IXP nodes exist globally, with core value in reducing transit costs, optimizing latency, and improving routing efficiency. The largest IXPs include DE-CIX (Frankfurt), AMS-IX (Amsterdam), and LINX (London). IXPs exhibit classic network effects, with revenue from port fees (1G/10G/100G/400G monthly), cross-connect fees, and private peering services.

Cloud On-Ramp strategic value. Equinix hosts 220+ cloud on-ramps, enabling direct access to AWS, Azure, Google Cloud, and Oracle Cloud via Equinix Fabric across 37 metros, including 8 of the world's top 10 GDP cities. Enterprises deploy at Equinix for low-latency private cloud connections, avoiding public internet transit, reducing egress costs, and ensuring data sovereignty compliance.

Why interconnection density is nearly unassailable. Physical cross-connects require actual cabling; migration involves physical reconnection, coordination with counterparties, and downtime risk — switching costs are extremely high. Each incremental cross-connect has near-zero marginal cost but contributes highly recurring revenue — meaning interconnection contributes disproportionate profit relative to its 19% revenue share. Carrier-neutral positioning is something hyperscale-owned data centers fundamentally cannot replicate — Equinix hosts competing cloud on-ramps, competing carriers, and competing financial exchanges within the same facility.

AI-era impact & opportunities. Traditional enterprise customers continue migrating to cloud, but AI inference's demand for low-latency edge deployment creates new retail colocation growth vectors. Equinix hosts approximately 40% of global Cloud On-Ramp nodes, with the top six cloud providers deploying 190+ cloud edge nodes at Equinix — 3x the runner-up. High-density AI racks (40–80+ kW) are driving retrofit demand: high-power cabinets (6.6 kW+) exceed 80% occupancy, while low-power (<4.4 kW) remain below 60%.

Key Companies

Equinix (EQIX) FY2024 revenue $8.748B (+7%); adjusted EBITDA $4.097B, 47% margin (+160 bps); AFFO/share $35.02 (+9%). Interconnection at 19% of recurring revenue (+9% YoY) is the core source of pricing power. Operates 260+ IBX data centers across 70+ cities / 30+ countries, serving 10,000+ customers. Two-thirds of recurring revenue comes from customers deployed across 10+ IBXs. FY2025 guidance: revenue $9.03–9.13B, EBITDA margin to 49%. Valuation: EV/EBITDA ~27x, P/AFFO ~25–28x, enterprise value exceeding $110B. Hindenburg Research's March 2024 short report alleged ~$3B cumulative AFFO inflation since 2015; SEC issued a subpoena but formally closed the investigation in November 2025 without recommending enforcement action; stock recovered from ~$701 lows.

CoreSite (American Tower subsidiary) Acquired by American Tower for $10.4 billion in 2021. FY2024 data center revenue $925M (+11%), representing 9.3% of AMT's total. Operates 30 data centers across 12 core U.S. markets; 39,250+ cross-connects (+4.9% YoY); average recurring revenue per cabinet $1,799/month (+8.5%); occupancy 85.5%.

Cyxtera — a cautionary bankruptcy case. This ~60-facility, 2,300-customer retail colocation provider filed Chapter 11 in June 2023. Pre-bankruptcy FY2022 revenue was $746M, EBITDA margin only 32% (vs. Equinix's 47%), occupancy 74.9%, cumulative losses $1.577B. The lethal combination: high-leverage SPAC listing + floating-rate debt (interest expense doubling to $75.7M/quarter) + ~$1B in loans maturing 2024. Brookfield acquired its assets for just $775M in January 2024 — a stark contrast to CoreSite's $10.4B price, with the core difference being interconnection revenue share (Cyxtera 11% vs. Equinix 19%) and customer stickiness.

APAC & European players. NTT Global Data Centers operates across 20+ countries, added 370+ MW in 2024, committed to investing at least ¥1.5 trillion (~$10B+) through FY2027. Telehouse/KDDI operates 45+ data centers; its London Docklands campus hosts LINX with Europe's highest carrier density. Interxion (Digital Realty subsidiary) operates 100+ European data centers as DLR's EMEA retail brand. Global Switch FY2024 revenue £437M, EBITDA margin 49%; sold Australian operations at 25x+ EBITDA for A$2.12B to HMC Capital in 2024.

China's retail market faces structural pressure. VNET FY2024 retail IDC revenue RMB 3.83B (down 3.1% YoY), while wholesale revenue RMB 1.95B surged 90.4% — clearly showing Chinese retail colocation is shrinking while wholesale/hyperscale is the growth engine. GDS FY2024 China revenue RMB 10.3B (+5.5%), adjusted EBITDA margin ~48%.

Company FY2024 Revenue EBITDA Margin Interconnections Data Centers EV/EBITDA
Equinix $8.75B 47% 482,000+ 260+ ~27x
CoreSite/AMT $925M ~49% (OP) 39,250+ 30 N/A (subsidiary)
Global Switch ~$550M ~49% N/A 12 25x (AU sale)
GDS ~$1.43B ~48% N/A Multiple ~16–18x
VNET ~$1.13B ~29% N/A 52,107 cabinets N/A
Cyxtera (pre-bankruptcy) $746M ~32% N/A ~60 Bankrupt

B. Wholesale/Custom Colocation: Hyperscale-Driven GW-Scale Competition

Wholesale colocation leases entire floors/buildings/campuses by MW to large customers. Delivery tiers range from Shell & Core, to Powered Shell, to Turn-key. CBRE data shows North American Tier 1 wholesale asking rates for 250–500 kW reached $184.06/kW/month in H2 2024 (+12.6% YoY); Northern Virginia broke through $215/kW/month in Q2 2025, a record high. This segment has entered the GW-scale competition era — QTS expanded from 330 MW at acquisition to 3 GW+, Digital Realty's developable capacity reaches 5 GW, and STACK's pipeline exceeds 6.5 GW.

Build-to-Suit (BTS) model. BTS is the dominant hyperscale development strategy. Developers build custom facilities to client specifications under 15+ year NNN leases. Average land transaction size increased to 224 acres in 2024 (up 144% from 2022), with average land cost at $5.59/sq ft ($244K/acre); parcels over 50 acres rose 23% YoY. Modular prefabricated construction is being widely adopted to compress delivery timelines.

Construction costs & returns. Standard wholesale data center construction costs approximately $10–12M/MW (Cushman & Wakefield 2025, 19-market U.S. average $11.7M/MW), ranging globally from $9.3M in San Antonio to $15M in Reno. AI-ready facilities (with liquid cooling) reach $20M+/MW; full-stack AI data centers (including GPUs) can reach $30–35M+/MW. Stabilized cap rates run approximately 4.25–6.25%, with 5-year unlevered IRR at 7.0–8.5%. Thunder Said Energy estimates a 30 MW non-AI data center requires ~$100M annual revenue ($3.3M/MW) to achieve 10% IRR.

Tier 1 market vacancy fell to a historic low of 1.9% by year-end 2024, declining further to 1.4% by year-end 2025. Under-construction capacity exceeded 6,350 MW, more than double the 3,078 MW at year-end 2023. Global annual transaction volume exceeded $6.5 billion in 2024, including 11 deals above $90M and 5 above $400M.

AI-era contract transformation. Traditional wholesale contracts run 5–10 years; hyperscale BTS projects extend to 15–25 years. Three critical AI-era shifts: First, single-deal sizes surged from 10–50 MW to 100–500 MW+ — in 2025, three hyperscalers each signed 400+ MW in Texas alone, and datacenterHawk tracked total North American absorption exceeding 15 GW. Second, contract terms extended further to 10–20 years. Third, pre-lease rates surged: hyperscale customers pre-lease 70–90% of capacity before construction begins, with some locking in capacity 3–4 years ahead.

Landmark M&A transactions. Blackstone acquired QTS in 2021 for $10B (~25x EV/EBITDA); as of September 2024, Blackstone had achieved over 2.5x return. KKR and GIP acquired CyrusOne in 2022 for $15B enterprise value (26.4x TEV/EBITDA). DigitalBridge and IFM acquired Switch in late 2022 for $11B. These transactions established the 25–30x EBITDA valuation center for premium wholesale platforms.

Key Companies

Digital Realty (DLR) FY2024 total revenue $5.555B (+1.4%). Q1 2025 Core FFO/share $1.77 (+6%). Global wholesale market share of 28%, #1 in the segment. Operates 310+ data centers across 50+ cities / 25+ countries. Operating capacity ~2,500 MW, under construction 769 MW, developable capacity 3+ GW, total potential ~5 GW. FY2026 guidance: Core FFO $7.90–8.00/share (~8% growth); signed-but-not-commenced lease backlog of $1.4B annualized rent. Joint venture with Blackstone for $7B hyperscale development. EV/EBITDA ~20–23x, P/FFO ~19–22x.

QTS (Blackstone) A textbook private-equity value creation case. Acquired in 2021 for $10B with 28 data centers and 330 MW capacity. By 2025: expanded to 70+ facilities, 3 GW+ capacity; leased capacity grew 12–14x; development pipeline grew 25x+. Completed a $3.5B CMBS refinancing in 2025 (the year's largest data center securitization); market rents up 84% since acquisition. Blackstone's overall data center portfolio reached $700B (including under construction), with pipeline exceeding $100B.

CyrusOne (KKR + GIP) Taken private in 2022 for $15B all-cash (26.4x EBITDA). Currently operates 80+ data centers across 7 countries and 30 markets. Raised $12.6B in 2024 financing (of which $11.2B linked to emission reduction targets), and $9.7B in 2025. Texas investments exceed $2.4B.

STACK Infrastructure Grew from 8 data centers (100 MW) in 2019 to 4.0+ GW built/under construction, with an additional 2.5+ GW planned, totaling 6.5+ GW pipeline. Cumulative financing exceeds $21B. Flagship Stafford campus (Virginia) plans 1+ GW, with Oracle committing 4.5 GW deployment. Sold European colocation business to Apollo in 2025 to focus on North America and APAC.

Compass Datacenters Acquired by Brookfield for $5.5B. Core differentiator is modular construction — patented since 2014, enabling delivery of large-scale data centers in as little as 9 months. $3B partnership with Schneider Electric; Red Oak factory produces 400+ power center modules annually. 5-year agreement with Siemens for up to 1,500 custom modular medium-voltage power units.

APAC wholesale market. AirTrunk acquired by Blackstone for A$24B (~US$16.1B) — the largest APAC data center platform (2x the runner-up), with 800+ MW contracted capacity and land supporting an additional 1+ GW. NEXTDC (ASX-listed) FY2024 revenue A$404M; contracted utilization grew from 172.6 MW to 244.8 MW; record forward order book of 133.9 MW; FY2026 capex guidance A$2.2–2.4B. Bridge Data Centres (Bain Capital) operates 9 data centers (Malaysia 6, Thailand 2, India 1), secured $2.8B senior secured facility in 2025; Bain exploring sale of up to 70% stake.

India's wholesale market is exploding. NTT India leads with ~20% market share, operating 292 MW with plans to expand to 400 MW within 18–24 months ($1.5B investment). AdaniConneX (Adani + EdgeConneX JV) plans 1 GW capacity with $10B+ investment, currently 210 MW under construction. CtrlS has invested $2B (~15% market share), supporting 135 kW/rack ultra-high density. Yotta deployed 16,000 NVIDIA H100s (~$1B GPU investment), exploring SPAC listing.

C. Power-First Development: Power Access Rights as Core Asset

Companies in this category are essentially engaged in "power arbitrage" — securing land, locking power, building shells, and leasing out. The core asset is not the building but the power access right and power reserve. Aligned's $40B acquisition price against 5 GW+ power reserve implies roughly $8B per GW.

The data center industry has undergone a decisive paradigm shift. Data centers are no longer a real estate story — they have become a test of power distribution, infrastructure governance, and political will. The U.S. Department of Energy estimates 100 GW of new peak generation capacity is needed by 2030, with half driven by data centers.

Power arbitrage economics. Developers lock in long-term nuclear PPAs (~$40–60/MWh fixed) then lease to customers at $184+/kW/month wholesale rates. Equinix CFO Keith Taylor revealed on the Q3 2025 earnings call that stabilized data centers achieve a 26% cash return on total PP&E, versus ~4% cost of debt — a spread he called "astronomical."

Powered vs. unpowered sites: the valuation chasm. The data is striking. Power-ready sites in Texas command approximately $20/sq ft (~$800K/acre), while sites without power infrastructure trade at just $2,500–10,000/acre — a power premium of 80–320x. A 124-acre parcel in Prince William County, Northern Virginia, sold to Microsoft for $465.5M (~$3.75M/acre), reflecting extreme power scarcity premiums. Digital Realty controls 5 GW of power land reserves, Equinix reserves 3 GW — competitive barriers few developers can replicate.

Behind-the-Meter (BTM) generation at scale. Goldman Sachs Research forecasts BTM systems will supply 25–33% of incremental data center power demand by 2030, with estimated incremental demand of 730 TWh. Bloom Energy surveys indicate data center leaders expect ~30% of sites to use on-site generation as their primary source by 2030. Landmark projects include Meta Ohio 200 MW gas turbines, Meta Louisiana Hyperion 2.26 GW (three H-class gas turbines + 1.5 GW solar, targeting 5 GW), and Oracle/OpenAI Stargate Abilene 1.2 GW BTM gas generation (total Stargate plan 7+ GW). Brookfield committed $5B to Bloom Energy for on-site fuel cells.

Nuclear PPAs as strategic focus. Constellation Energy signed a 20-year PPA with Microsoft to restart Three Mile Island (renamed Crane Clean Energy Center), 835 MW output, $1.6B investment (including $1B DOE loan), originally planned for 2028 and now advanced to 2027. Constellation signed a 1,100 MW Clinton nuclear PPA with Meta (June 2027 delivery). Amazon is most aggressive — signed a 1,920 MW Susquehanna nuclear front-of-meter PPA with Talen Energy (through 2042), investing $20B in Pennsylvania data centers (the state's largest-ever private investment); simultaneously advancing X-energy SMRs (initial 320 MW, expandable to 960 MW) and Dominion Energy Virginia SMRs (at least 300 MW). Google signed the first corporate SMR fleet agreement with Kairos Power — 500 MW pipeline by 2035 (6+ reactors), first unit online 2030.

Key Companies

Aligned Data Centers Acquired in October 2025 by AI Infrastructure Partnership (BlackRock/GIP/MGX/Microsoft/NVIDIA alliance) for approximately $40 billion — the largest data center transaction in history. Total capacity exceeding 5 GW across 50 campuses in the Americas. Seller Macquarie first invested in 2018 when Aligned had just 2 facilities and 85 MW capacity; exiting 7 years later at $40B implies an extraordinary return multiple (20x+). Aligned's Delta³ patented cooling technology (supporting 50+ kW/cabinet density) and DeltaFlow liquid cooling are key differentiators.

Vantage Data Centers Global capacity exceeding 2.6 GW across 25+ campuses on 5 continents. Completed $9.2B equity investment in 2024 (DigitalBridge and Silver Lake co-led), with over $13B total debt and equity financing for the year. Frontier campus (Texas): $25B+ investment, 1.4 GW design, 10 data centers, 3.7M sq ft, first building expected H2 2026. Also co-developing Lighthouse campus (~1 GW) in Wisconsin with OpenAI/Oracle as part of Stargate expansion. DigitalBridge's overall platform holds nearly 21 GW of secured power reserves.

EdgeConneX (EQT) Acquired by EQT in 2020 for approximately $2.7B (24x EBITDA). Since then, capacity grew 3x+, expanding to 80 data centers across 50+ markets. EQT sold a minority stake to Sixth Street Partners in September 2024; current enterprise value estimated at $10B+.

D. GPU Cloud: Data Center Shell + GPU Assets + Cloud Platform

GPU-as-a-Service deploys owned GPUs atop leased data center shells, billing by compute-hour. CoreWeave, with FY2025 revenue of $5.1B (+168%), RPO of $60.7B, and 3.1 GW contracted power, entered the ranks of major tech infrastructure companies in its IPO year — while simultaneously carrying $21B+ in debt and extreme customer concentration risk (Microsoft at 67% of revenue).

Key Companies

CoreWeave (CRWV) IPO'd on NASDAQ in March 2025 at $40/share, raising ~$1.4B. FY2024 revenue $1.92B (+737%); FY2025 revenue $5.1B (+168%). Q3 2025 revenue $1.365B (+134%), adjusted EBITDA $838M. RPO surged from $15.1B at year-end 2024 to $60.7B at year-end 2025. 250,000+ GPUs, 850+ MW active power, ~3.1 GW contracted power. Net loss widened from $863M (2024) to $1.2B (2025). Complex debt structure: DDTLs 1.0–4.0 cumulative maximum ~$21B+, $3.75B senior notes (9–9.25%), $2.6B convertible notes. DDTL 4.0 (March 2026, $8.5B) received Moody's A3 investment-grade rating — the first-ever investment-grade GPU-backed loan, anchored by Meta's $14.2B contract. Extreme customer concentration: Microsoft at 67% of 2025 revenue, OpenAI $22.4B contract, Meta $14.2B, NVIDIA $6.3B strategic partnership. 2026 capex guidance: $30–35B.

Lambda Labs Completed $1.5B+ Series E in November 2025 (TWG Global-led), cumulative funding ~$2.3B. 2024 estimated revenue ~$425M (+70%), ~50% gross margin. Core differentiators: developer-friendly experience and pricing advantage (H100 at $1.89–2.49/GPU·hour vs. CoreWeave ~$4.25). NVIDIA signed a $1.5B leaseback in September 2025, renting 18,000 Lambda GPUs for 4 years, making NVIDIA its largest customer. Multi-billion dollar multi-year agreement with Microsoft.

Crusoe Energy Uniquely vertically integrated GPU cloud — full-stack control from energy procurement to data center design/construction to AI cloud platform, with energy costs 30–50% below traditional hyperscalers. Sold Bitcoin mining operations to NYDIG in 2024, fully pivoting to AI cloud.

Applied Digital (APLD) Transitioning from "data center developer" to "HPC leasing platform." FQ2 2026 revenue $127M, of which HPC hosting contributed $85M. Former cloud services business classified as "held for sale," planned spin-off with EKSO to form ChronoScale.

Voltage Park Operates as a nonprofit, funded by a $1B grant from Navigation Fund (Stellar co-founder Jed McCaleb). H100 on-demand pricing at just $1.99/GPU·hour (among the lowest), enabled by zero debt costs and nonprofit status. Merged with Lightning AI in January 2026.

Together AI Completed $305M Series B-2 in February 2025, at $3.3B valuation. Hybrid GPU cloud + open-source model platform supporting 200+ open-source models and 450,000+ registered developers.

Neocloud vs. hyperscale GPU pricing: the gap is narrowing. In June 2025, AWS cut H100 on-demand pricing by 44% to ~$3.90/GPU·hour — a landmark inflection point. Pre-cut neocloud advantage was 30–70%; post-cut it narrowed to ~30–50%.

Company 2024 Revenue 2025 Revenue Valuation / Market Cap Core Model
CoreWeave $1.92B $5.1B Mkt cap ~$40–70B GPU cloud (leased shell + owned GPU + platform)
Lambda Labs ~$425M ~$520M $2.5–4B (private) Developer-friendly GPU cloud
Crusoe Energy ~$276M ~$0.5–1B $10B+ (private) Energy + DC + GPU vertical integration
Applied Digital ~$165M (FY25) ~$350M (FY26E) Mkt cap ~$3B DC developer → HPC leasing
Together AI ~$50–130M ~$120–300M $3.3B (private) GPU cloud + open-source models

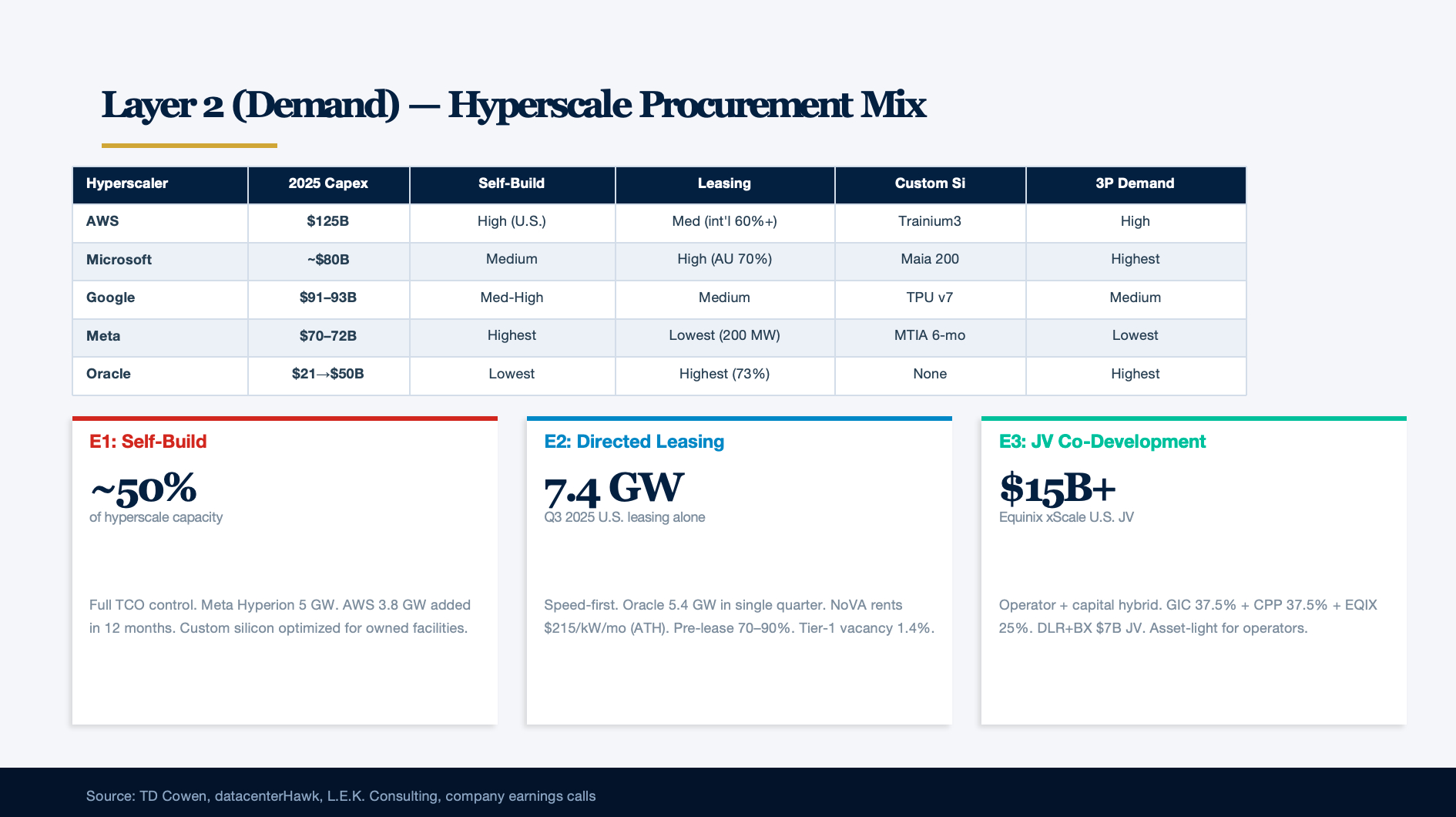

Layer 2: Demand — Hyperscale Capacity Procurement

E. Hyperscale Capacity Procurement: Three Distribution Paths for Trillion-Dollar Demand

Hyperscale enterprises are the data center industry's largest demand engine, but their capacity acquisition is not monolithically "self-build" — it is a dynamic combination of self-build, directed leasing, and joint-venture co-development. Understanding how these three procurement paths allocate trillion-dollar-scale capex is a prerequisite for valuing Layer 1 targets.

Synergy Research Group data shows that as of early 2025, hyperscalers operated 1,189 large data centers globally, controlling 41% of global data center capacity. "Slightly over half" were self-built, with the remainder provided by third-party operators. But this ratio is shifting rapidly — AI demand growth far outpaces self-build timelines (24–36 months), Q3 2025 U.S. hyperscale leasing reached 7.4 GW in a single quarter, exceeding all of 2024, and L.E.K. Consulting (2025) projects hyperscalers will continue sourcing the majority of capacity from third-party operators over the next 10–15 years.

Capex magnitude. Combined capex of the four largest hyperscalers (AWS, Google, Microsoft, Meta) surged from $155B in 2023 to $251B in 2024 (+62%), with 2025 guidance at approximately $315–350B and 2026 projected at $500–600B. Approximately 75% of 2026 capex will target AI infrastructure. JLL estimates total hyperscale data center spending in 2024–2026 will approach $1 trillion. How this capital is distributed among the three procurement paths directly determines value flows throughout the data center supply chain.

E1. Self-Build: TCO Optimization & Custom Silicon Vertical Integration

Self-build is the preferred model for hyperscalers in core markets and mature regions, with the central advantage being full-stack TCO control.

Quantifying self-build TCO advantages. Hyperscale self-built facilities achieve PUE of 1.05–1.25, significantly better than the industry average of 1.5–1.6. Self-build captures land appreciation, eliminates rent escalation, and enables customized power/cooling optimization. Meta has the strongest self-build preference — Q3 2025 U.S. leasing was only 200 MW, and its Hyperion campus (Louisiana) covers an area equivalent to Manhattan, expandable to 5 GW. AWS is similarly self-build-dominant in the U.S., with 39 regions, 120 availability zones, 353 data centers, and 3.8 GW of power capacity added in the past 12 months.

Custom silicon as a core extension of self-build. Self-built facilities provide the optimal deployment environment for custom chips — power, cooling, and network architecture can be precisely optimized for proprietary silicon, something third-party hosting cannot fully match. Key developments:

  • AWS Trainium3 (December 2025): First 3nm AI chip, 2.52 PFLOPS FP8 per chip; Graviton5 (3nm) delivers 25% improvement over G4; 2M+ Graviton chips produced cumulatively.
  • Google TPU v7 Ironwood (April 2025): 4,614 TFLOPS FP8 per chip; 9,216-chip Superpod delivers 42.5 Exaflops; TCO approximately 44% lower than NVIDIA GB200. Agreement with Anthropic for up to 1M Ironwood TPUs.
  • Meta MTIA: Extremely aggressive roadmap — one generation every 6 months (vs. industry 12–24 months). MTIA 300 in production, MTIA 400 imminent, MTIA 500 planned for 2027.
  • Microsoft Maia 200 (January 2026): 3nm inference-optimized AI accelerator, 216 GB HBM3e.

Impact on A–D targets: Self-build is a direct competitive substitute for B-class (wholesale) and C-class (power-first) operators. Meta's and AWS's self-build preferences mean less of their demand flows to third-party markets. Custom silicon maturation further reduces dependence on the NVIDIA GPU ecosystem, potentially eroding D-class (GPU cloud) differentiation long-term.

E2. Directed Leasing: Speed-First Demand Source for B/C Classes

Directed leasing is the model through which hyperscalers acquire capacity from third-party operators via long-term NNN leases. It is fundamentally the demand side of B-class (wholesale) and C-class (power-first) operators — the single largest revenue source for A–D targets.

Five drivers sustaining lease growth. First, speed — leasing is 12–24 months faster than self-build; Microsoft CFO Amy Hood acknowledged on the Q2 2024 earnings call: "We are capacity-constrained on AI... we have signed with third parties to help us close the leasing gap." Second, international market entry — markets with insufficient scale to justify self-build favor leasing (AWS sources ~60% of Australian capacity from lessors; Microsoft was 100% leased in Australia until recently, expected to remain ~70% leased through 2028). Third, capital efficiency — converting capex to opex, preserving balance sheet capacity for GPUs, chips, and software. Fourth, local resource access — local operators have decades-long relationships with utilities, governments, and supply chains. Fifth, operational bandwidth — self-building in every market dilutes engineering and operations teams. CreditSights (2026) further notes hyperscalers are increasingly shifting toward leasing as it "reduces cash capital expenditure and provides long-term flexibility."

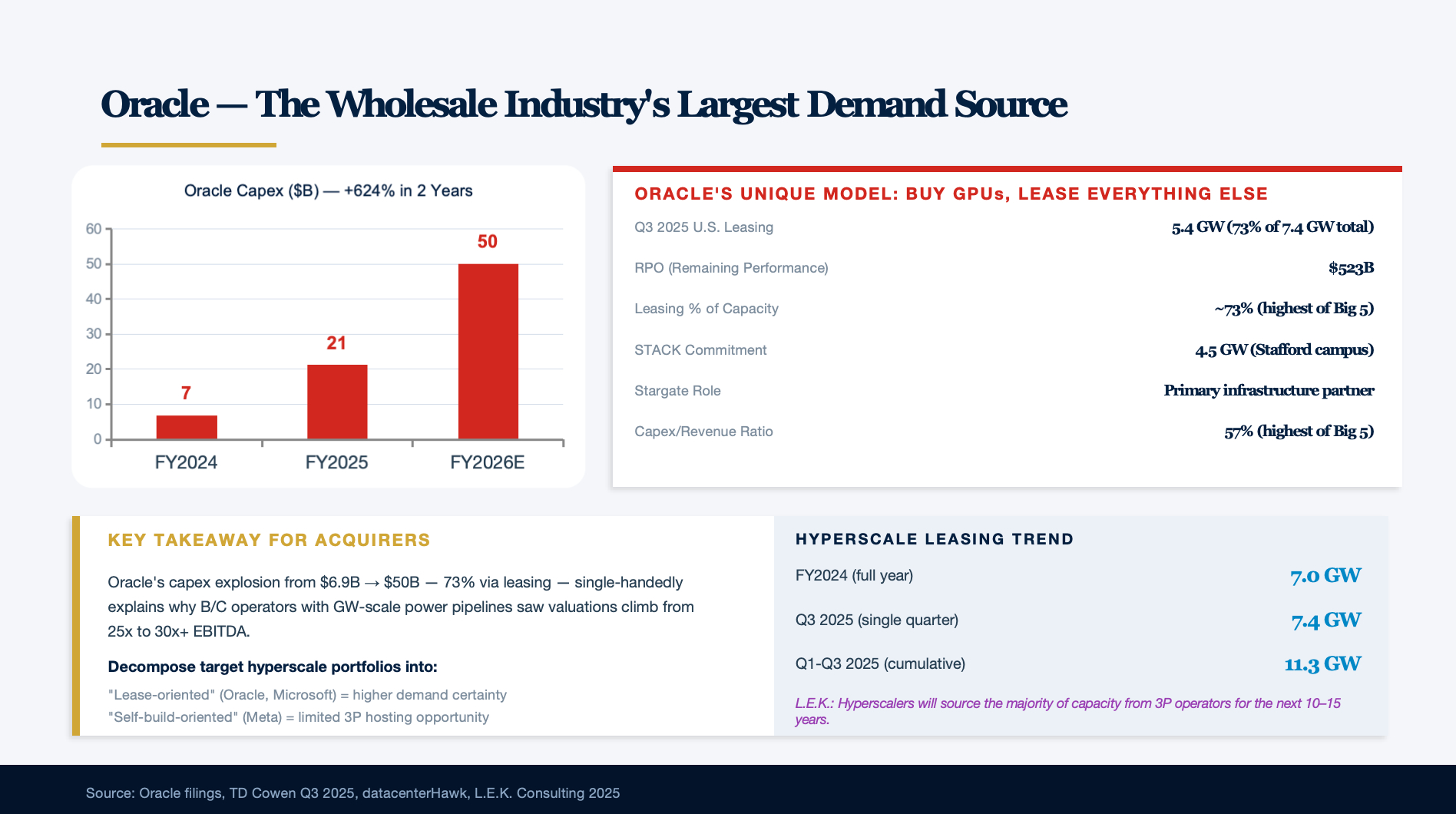

Oracle is the key sample for understanding E2. Oracle's capacity acquisition strategy differs fundamentally from the other four hyperscalers — GPUs/servers are self-purchased but land/buildings/power are primarily leased. FY2025 capex: $21.2B (vs. $6.9B in FY2024, +207%); FY2026 guidance raised to $50B. Q3 2025 U.S. leasing: 5.4 GW in a single quarter (73% of the 7.4 GW total, exceeding all of 2024). RPO reached $523B. Oracle serves as Stargate's primary infrastructure partner, signing an additional 4.5 GW capacity agreement with OpenAI in July 2025. Oracle's model makes it the wholesale colocation industry's single largest incremental demand source — STACK's flagship Stafford campus (Virginia) plans 1+ GW, with Oracle committing 4.5 GW there.

Leasing market data confirms accelerating trends. Northern Virginia rents reached $215/kW/month (all-time high, +20–35% YoY). In 2025, three hyperscalers each signed 400+ MW in Texas alone. datacenterHawk tracked North American full-year absorption exceeding 15 GW. Tier 1 market vacancy declined from 1.9% (year-end 2024) to 1.4% (year-end 2025).

Impact on A–D targets: Accelerating E2 growth directly benefits B-class and C-class operators — platforms with GW-scale power pipelines and investment-grade tenant long-term NNN leases benefit most. QTS's expansion from 330 MW to 3 GW+ and 84% market rent appreciation were driven precisely by the explosion in hyperscale leasing demand. This is the signal acquirers should focus on: the stronger the hyperscale leasing preference, the higher the demand certainty for B/C targets.

E3. Joint Venture (JV) Co-Development: Operator + Capital Hybrid Innovation

The JV model sits between self-build and pure leasing — hyperscalers co-develop capacity through joint-venture structures with operators and financial investors. This model spans B-class (operating capability) and G-class (capital structure), and is becoming the largest incremental deployment pathway.

Equinix xScale is the most successful JV paradigm. In October 2024, Equinix formed a $15B+ U.S. JV with GIC (37.5%) and CPP Investments (37.5%), planning to add 1.5 GW+ of capacity, nearly tripling xScale's invested capital. Prior to this, global xScale commitments exceeded $8B across 35+ facilities / 725+ MW. In February 2026, CPP Investments and Equinix acquired Nordic operator atNorth for $4B. The xScale model's elegance: Equinix contributes only 20–25% equity but supplies operating expertise and customer relationships, achieving asset-light expansion.

Other JV models emerging. MC Digital Realty (Mitsubishi Corporation 50% + Digital Realty 50%) has operated in Japan since 2017, expanding to Dallas in March 2024. Digital Realty and Blackstone formed a $7B JV covering Frankfurt, Paris, and Northern Virginia (500 MW / 10 data centers). NTT committed to investing ¥1.5 trillion ($10B+) through FY2027. Blackstone + CPP Investments acquired AirTrunk for A$24B ($16.1B) — the world's largest data center transaction.

Structural logic of JV proliferation. Hyperscalers need speed and scale but don't want full capex burden; operators need capital but don't want to dilute control; sovereign wealth funds and pension funds need long-duration stable returns — JV structures satisfy all three parties. For operators, JVs upgrade hyperscale customers from "tenants" to "partners," deepening lock-in. For financial investors, hyperscale credit backing provides bond-like cash flow predictability.

Impact on A–D targets: JVs are especially favorable for A-class operators (e.g., Equinix) — entering hyperscale markets through asset-light structures without diluting retail margins. For G-class (PE platforms), JVs provide entry into hyperscale infrastructure buildout; CPP Investments' and GIC's large-scale participation validates sovereign capital's preference for this structure. However, JVs may also squeeze pure B-class operators — when hyperscalers form exclusive JV relationships with top-tier operators, mid-tier wholesalers risk marginalization.

Hyperscale Procurement Mix Comparison

Hyperscaler 2025 Capex Self-Build Preference Leasing Intensity JV Participation Custom Silicon Third-Party Demand Contribution
AWS $125B High (U.S. primary) Medium (international 60%+) MC Digital Realty et al. Trainium3 / Graviton5 High — primary international demand source
Microsoft ~$80B (FY25) Medium High (Australia 70% leased) Multiple Maia 200 Highest — CoreWeave's largest customer ($10B)
Google $91–93B Medium-High Medium Limited TPU v7 Ironwood Medium — leans toward self-build
Meta $70–72B Highest Lowest (Q3: only 200 MW) No major JVs MTIA (6-month cadence) Lowest — overwhelmingly self-built
Oracle $21.2B → $50B Lowest Highest (73% leased) Stargate partnership None Highest — largest wholesale incremental source

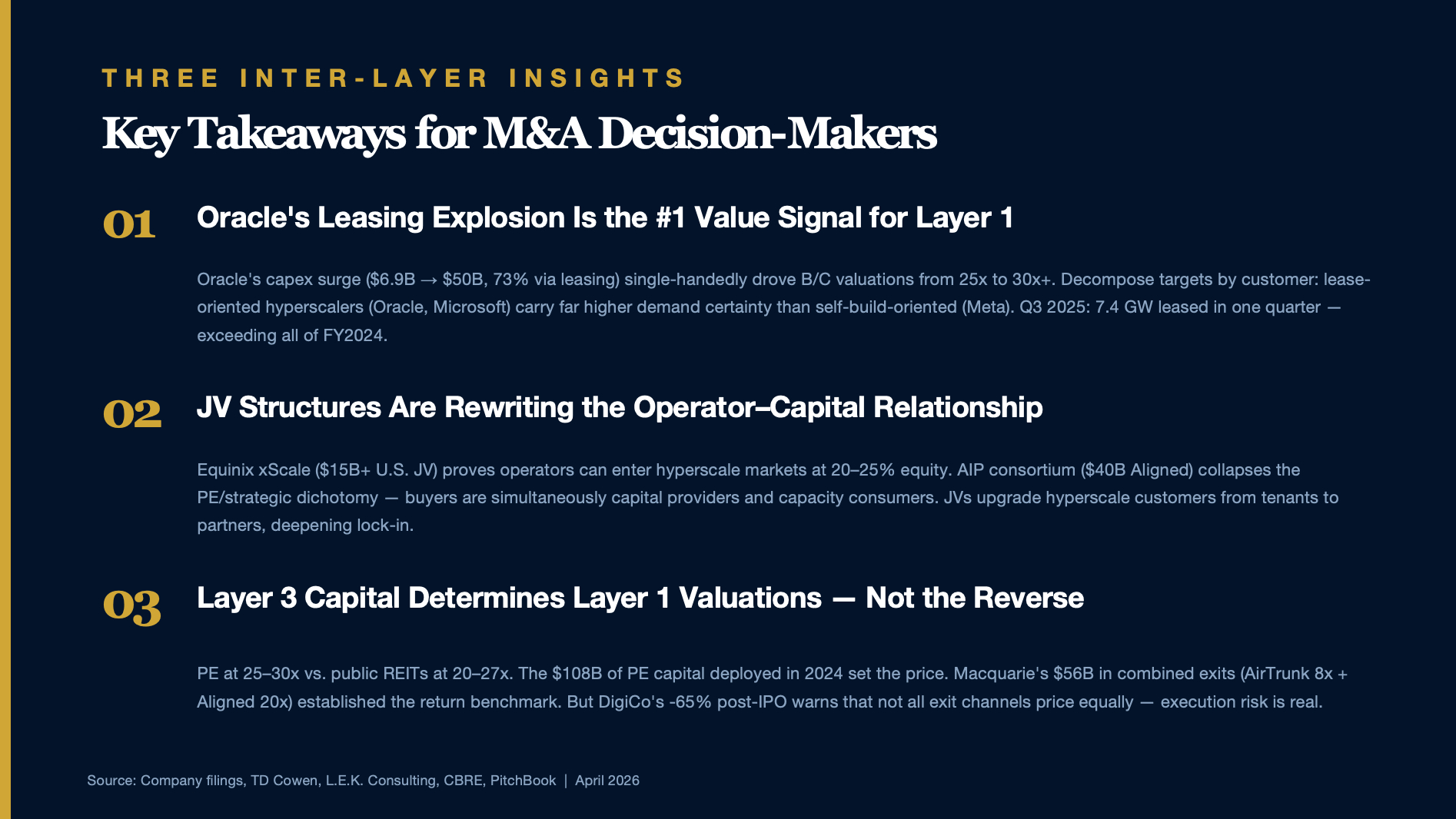

Key takeaway for acquirers: Hyperscalers are not acquisition targets, but their procurement strategy shifts directly create or destroy value for A–D targets. Oracle's capex explosion from $6.9B to $50B — 73% via leasing — single-handedly explains why B/C operators with GW-scale power pipelines saw valuations climb from 25x to 30x+ EBITDA. Conversely, Meta's near-total self-build strategy means third-party hosting opportunities for Meta are extremely limited. Acquirers should decompose target companies' hyperscale customer portfolios into "self-build-oriented vs. lease-oriented customers" — the latter carry far higher demand certainty and contract value.

Layer 3: Capital — Asset Ownership & Financing Structures

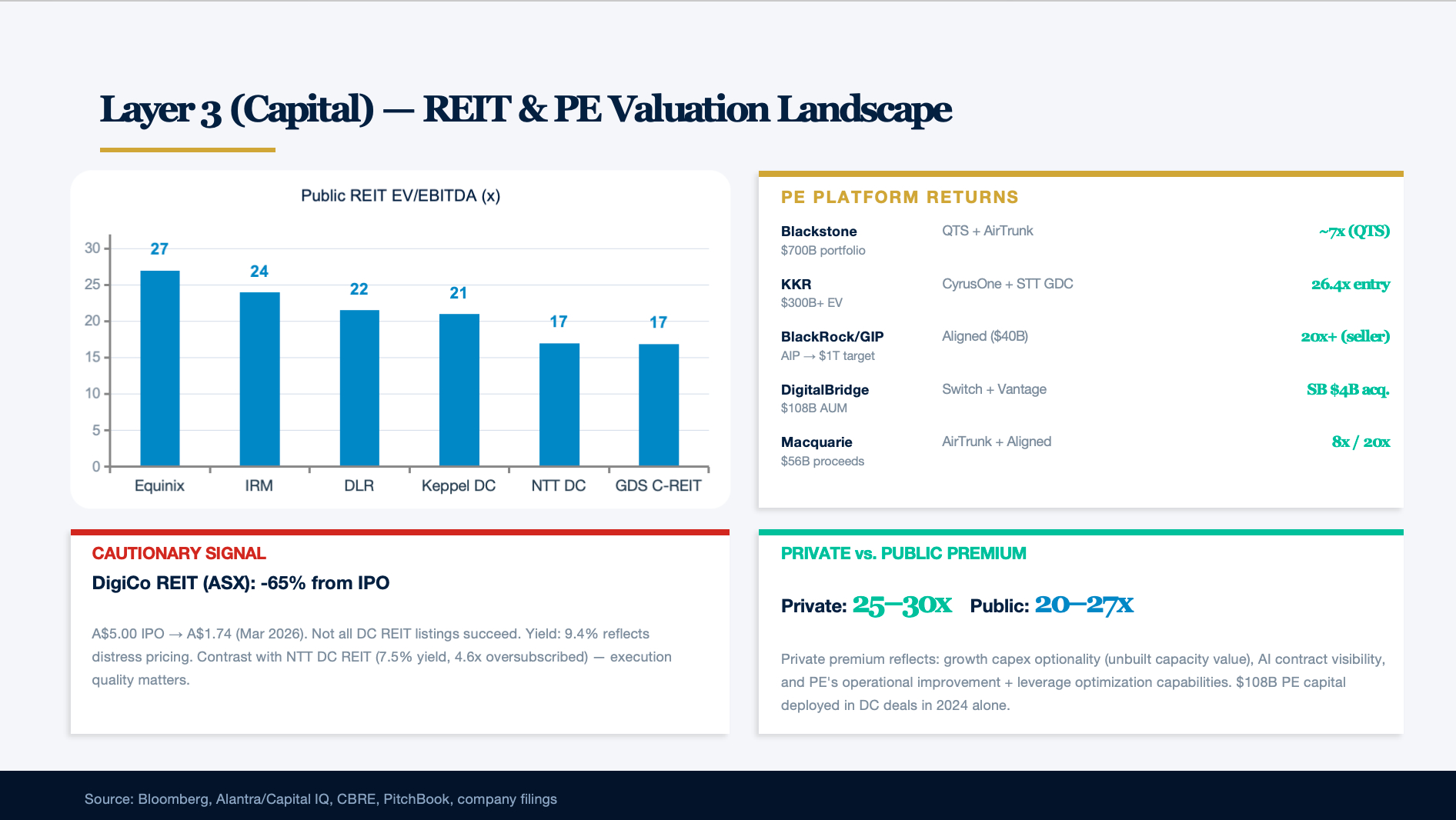

F. REIT Platforms: Widening Valuation Divergence in Public Markets

Data center REITs offer liquidity, tax advantages, and stable distributions, but valuations have become highly divergent — large U.S. REITs trade at 27x EV/EBITDA, while newly listed APAC REITs attract yield investors at 7–8%, and China's C-REITs trade at 16.9x reflecting risk premiums.

Key Companies

Equinix REIT Enterprise value exceeding $110B, EV/EBITDA ~27x — the highest among global data center REITs, reflecting its interconnection network effects and global footprint. P/AFFO ~25–28x, dividend yield ~2.1% (10th consecutive year of 10% growth). Credit ratings: Moody's Baa2 (positive outlook) / S&P BBB / Fitch BBB+.

Digital Realty REIT EV/EBITDA ~20–23x, P/Core FFO ~19–22x, dividend yield ~2.7–3.5%. FY2024 Core FFO/share $6.72; FY2025 guidance $7.05–7.15/share (+5–6%). The $7B JV with Blackstone is its key lever for the hyperscale market. Net debt/EBITDA ~4.8x.

Iron Mountain (IRM) Data center business has become the growth engine — 2025 data center revenue ~$800M, up ~30% YoY, with Q3 single-quarter growth of 33%. Data centers represent ~12% of total revenue. Operates 29–30 data centers, total capacity 1,280 MW. 2024 stock price gain of ~79.7% (far exceeding S&P 500's 21.2%). P/FFO ~23–25x.

APAC newly listed REITs offer higher yields. Keppel DC REIT (SGX) operates 25 data centers (10 countries, 13 cities); FY2024 total revenue $310M (+10.3%); distribution yield ~4.8–5.1%; occupancy 97.5%. NTT DC REIT listed on SGX July 14, 2025 — the exchange's largest REIT IPO in 10 years; raised US$773M; initial portfolio of 6 data centers (U.S. 4, Austria 1, Singapore 1); designed IT load 90.7 MW; projected distribution yield 7.5–7.8%; GIC subscribed US$101M.

GDS C-REIT (508060, SSE) Listed August 8, 2025 at RMB 3.00/unit, raising RMB 2.4B. Institutional subscription 166x oversubscribed; retail subscription 456x oversubscribed (early close). Underlying asset appraised at ~RMB 1.933B, implying EV/EBITDA of 16.9x, projected distribution yield 5.2%. GDS retained 20% stake.

DigiCo REIT (DGT, ASX) is a cautionary case. Listed December 13, 2024 at A$5.00/unit, IPO market cap A$2.75B; core asset is Global Switch Australia. Post-listing price collapsed — March 2026: ~A$1.74 (down 65% from IPO price), current market cap just A$960M. Current distribution yield ~9.4%, but fundamentals under pressure.

REIT Exchange Enterprise Value EV/EBITDA Yield NAV Premium/Discount
Equinix NASDAQ ~$111.6B ~27x ~2.1% Significant premium
Digital Realty NYSE ~$61B ~20–23x ~2.7–3.5% Premium
Iron Mountain NYSE ~$40B ~23–25x ~2.5–3% Significant premium
Keppel DC REIT SGX ~S$5B ~20–22x ~4.8–5.1% Premium ~50%+
NTT DC REIT SGX ~US$1.6B ~17x (IPO) 7.5–7.8% Near par
GDS C-REIT SSE ~RMB 2.3B 16.9x 5.2% Near par
DigiCo REIT ASX ~A$1B N/A ~9.4% Deep discount

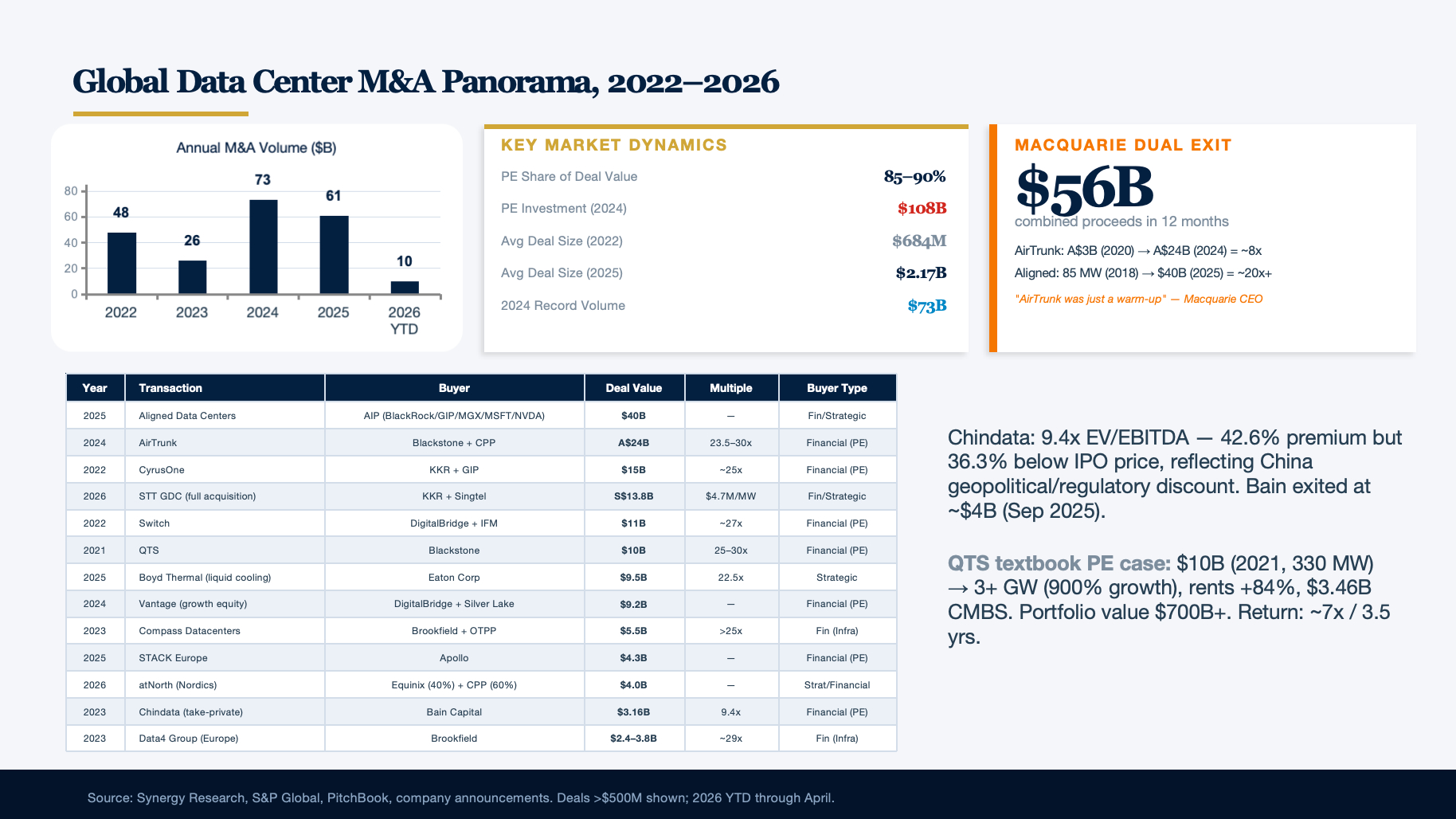

G. Private Equity Platforms: The Arena for Outsized Returns

Private equity has generated arguably the most remarkable returns in contemporary alternative asset management within the data center sector. Transaction multiples climbed from 24x EBITDA in 2020 to 25–30x+ in 2025, far exceeding the 16x average for private infrastructure transactions and significantly above public REITs' 20–27x. Over $108B in PE capital flowed into data center deals in 2024.

Key Companies

Blackstone Has built the world's largest data center empire. Total portfolio: $700B (including under construction), pipeline exceeding $100B. Core asset QTS has seen leased capacity grow 8x since the 2021 $10B acquisition, with property value at least doubling several times over. Acquired AirTrunk in September 2024 for A$24B (~US$16.1B) — APAC's largest data center transaction and 2024's largest global LBO. $7B JV with Digital Realty. Plans to launch a publicly traded data center acquisition vehicle.

KKR Total data center enterprise value exceeding $300B. Core asset CyrusOne acquired for $15B (26.4x EBITDA), now operating 80+ facilities. Acquired 82% of STT GDC in February 2026 for S$6.6B (~US$5.1B) (implied enterprise value ~$10.9B), KKR 75% / Singtel 25%. STT GDC designed capacity: 2.3 GW. Also invested in Global Technical Realty (Europe), CoolIT (liquid cooling), and others.

BlackRock/GIP Completed the $40B Aligned acquisition through AI Infrastructure Partnership — the largest data center transaction in history. AIP comprises BlackRock, GIP, MGX, Microsoft, and NVIDIA; anchor investors include Kuwait Investment Authority and Temasek; targeting $300B equity mobilization (with debt potential reaching $1 trillion). BlackRock acquired GIP in 2024 for $12.5B (managing $100B+ in assets).

Brookfield Total data center equity investment exceeding $5B, operating capacity ~485 MW+. Core platforms include Data4 (Europe, ~$2.4B acquisition), Compass (~$5.5B), and DCI (APAC). Announced €20B AI infrastructure investment plan at the Paris AI Summit in February 2025 (€15B led by Data4 for French data centers); launched $100B AI infrastructure plan in November 2025. Acquired Cyxtera bankruptcy assets for $775M.

DigitalBridge AUM ~$108B, data center capacity 5.4 GW. Acquired by SoftBank in December 2025 at $16/share (65% premium), enterprise value ~$4B. Core portfolio includes Switch (SoftBank separately negotiating ~$50B valuation), DataBank, Vantage, and Yondr. Led Vantage's $9.2B equity investment in 2024.

Macquarie delivered two historic exits. AirTrunk: acquired at ~A$3B valuation in 2020, sold for A$24B in 2024 — ~8x return in 4 years, with estimated performance fees up to $1.3B. Aligned: invested in 2018 at 2 facilities / 85 MW; exited at $40B in 2025 — estimated 20x+ return in 7 years. Macquarie CEO called the AirTrunk exit "just a warm-up"; the group holds 4.3 GW of data center capacity, with nearly one-third of asset management investments in digital infrastructure.

Other active PE. EQT holds EdgeConneX (2020 $2.7B acquisition, current valuation $10B+). Stonepeak holds Cologix (2022 $3B recapitalization) and launched Montera Infrastructure ($1.5B). Silver Lake co-invested with DigitalBridge in Vantage and established a $400M "electrified land" platform with Commonwealth. GLP Capital Partners completed its first RMB 2.6B digital infrastructure fund in China.

Private vs. public market valuation premium. Private transactions at 25–30x EV/EBITDA vs. public REITs at 20–27x. CBRE Investment Management data shows that data center platform acquisition multiples over the past 4 years have been approximately 60–90% above the 16x average for private infrastructure transactions. The premium stems from growth capex optionality (implied value of planned-but-unbuilt capacity not captured in current EBITDA), AI-driven long-term contract visibility, and PE's ability to execute operational improvements and leverage optimization.

PE Firm Core DC Assets Acquisition / Investment Estimated Current Value Key Transaction
Blackstone QTS, AirTrunk $10B + A$24B $700B portfolio Planning listed acquisition vehicle
KKR CyrusOne, STT GDC $15B + $5.1B $300B+ EV STT GDC 2.3 GW
BlackRock/GIP Aligned $40B $40B (new acquisition) AIP alliance, $1T potential
Brookfield Data4, Compass $5.5B+ 1.25 GW+ €20B France commitment
DigitalBridge Switch, Vantage $9.2B (Vantage) $108B AUM SoftBank $4B acquisition
Macquarie APLD, VIRTUS, et al. Multiple 4.3 GW Two historic exits

Deep-Dive: Business Model Comparisons

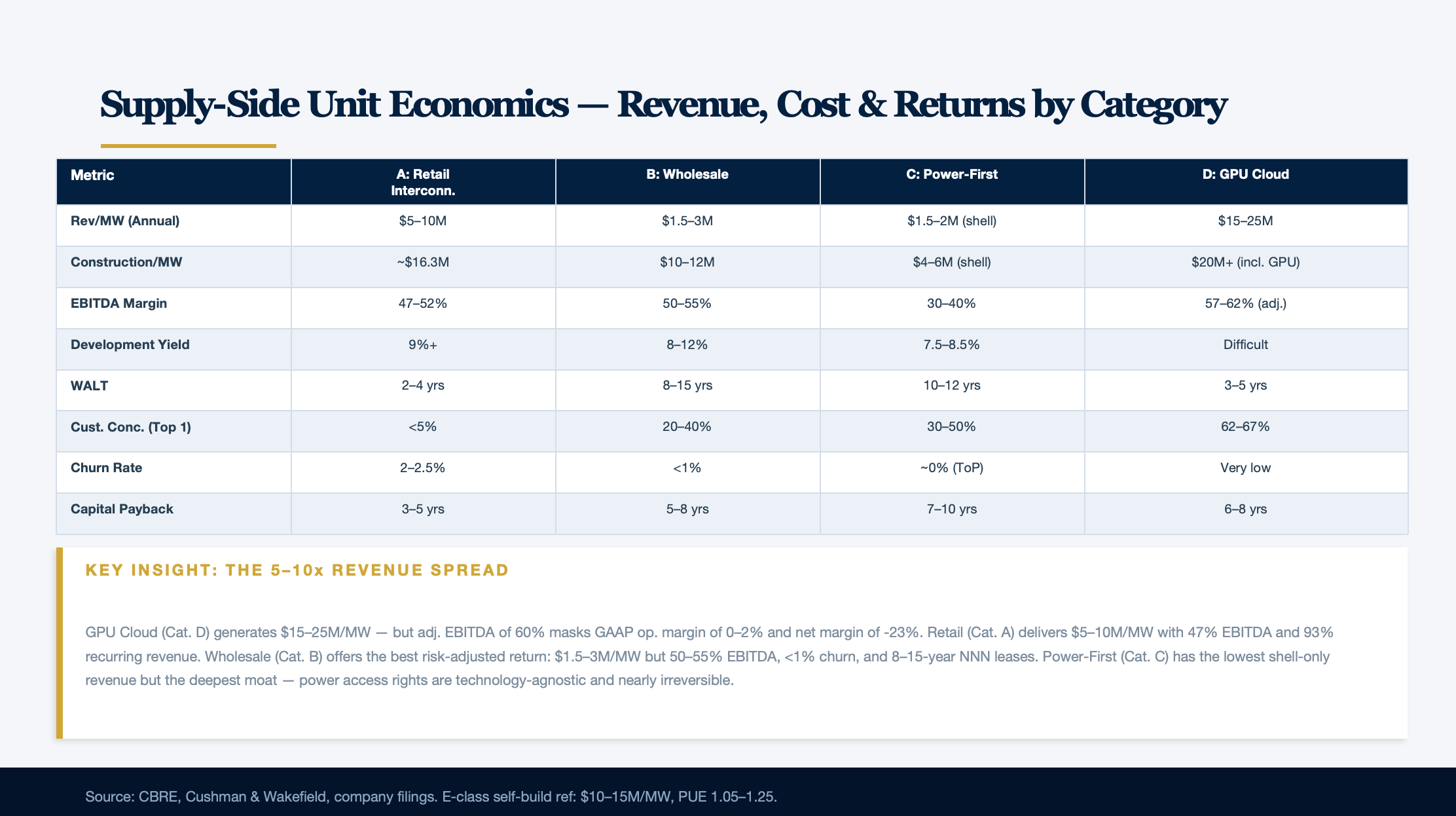

Section 1: Supply-Side Unit Economics Panorama

Unit economic differences among the four supply-side business models stem from the distinct "products" each delivers — from the most basic "powered space" to the most complex "compute capacity," per-MW revenue can vary 5–10x.

Key Metric A: Retail Interconnection B: Wholesale C: Power-First D: GPU Cloud
Annual Revenue per MW $5–10M $1.5–3M $1.5–2M (pure shell) $15–25M
Construction Cost/MW (full-stack) ~$16.3M $10–12M $4–6M (shell) + tenant equipment $20M+ (incl. GPU)
EBITDA Margin 47–52% 50–55% 30–40% (shell) 57–62% (adjusted)
Development Yield 9%+ 8–12% (DLR ~11.9%) 7.5–8.5% Difficult to stabilize
WALT 2–4 years 8–15 years 10–12 years 3–5 years (contracted)
Customer Concentration (Top 1 / Top 5) <5% / <15% 20–40% / 60–80% 30–50% / 70–90% 62–67% / 77%+
Churn Rate 2–2.5% <1% ~0% (Take-or-Pay) Very low (contracted)
ROIC High single to low double digits 8–12% Difficult in dev phase Low single digits to negative
Capital Payback Period 3–5 years 5–8 years 7–10 years 6–8 years (incl. GPU depreciation)

Hyperscale self-build cost benchmarks (E-class reference data). Although E-class belongs to the demand layer rather than a supply-side business model, its self-build costs provide an important reference for assessing B/C operator pricing power: hyperscale self-build facility costs are approximately $10–15M/MW with PUE of 1.05–1.25; AWS cloud business ROIC is approximately 30%+. When self-build costs significantly undercut total leasing costs, hyperscalers have incentive to increase self-build share — this sets the pricing power ceiling for B/C operators.

Section 2: Contract Structures & Financing Innovation

AI-Era Contract Transformation

AI demand is fundamentally reshaping data center contract paradigms. Traditional hosting contracts centered on "area × rate" are evolving toward "power × capacity × obligation."

Contract Feature Retail (A) Wholesale (B) Power-First (C) GPU Cloud (D)
Typical Term 1–5 years (auto-renew) 5–25 years (NNN) 7–12 years (Take-or-Pay) 3–5 years (Take-or-Pay)
Pricing Model Per cabinet/kW/month + interconnection Per kW/month (NNN) Power pass-through + hosting fee Per GPU·hour or monthly
Annual Escalator CPI or 2–3% 3–4% (DLR new signings 4%) CPI + power cost pass-through Typically fixed
Pre-lease Rate Low 73–80% of under-construction pre-leased Very high N/A (contractually locked)
Financing Collateral Value Medium High (investment-grade tenant NNN) High Emerging (GPU-backed)

CoreWeave's contract structure typifies the D-class model. As of year-end 2025, contracted backlog reached $66.8B: OpenAI up to $22.4B (signed in three tranches), Meta $14.2B (through December 2031), Microsoft ~$10B (contributing 67% of revenue), NVIDIA $6.3B capacity floor commitment (through April 2032, NVIDIA commits to purchase CoreWeave's unsold cloud capacity). This Take-or-Pay structure provides the foundation for large-scale debt financing — but extreme customer concentration is a double-edged sword.

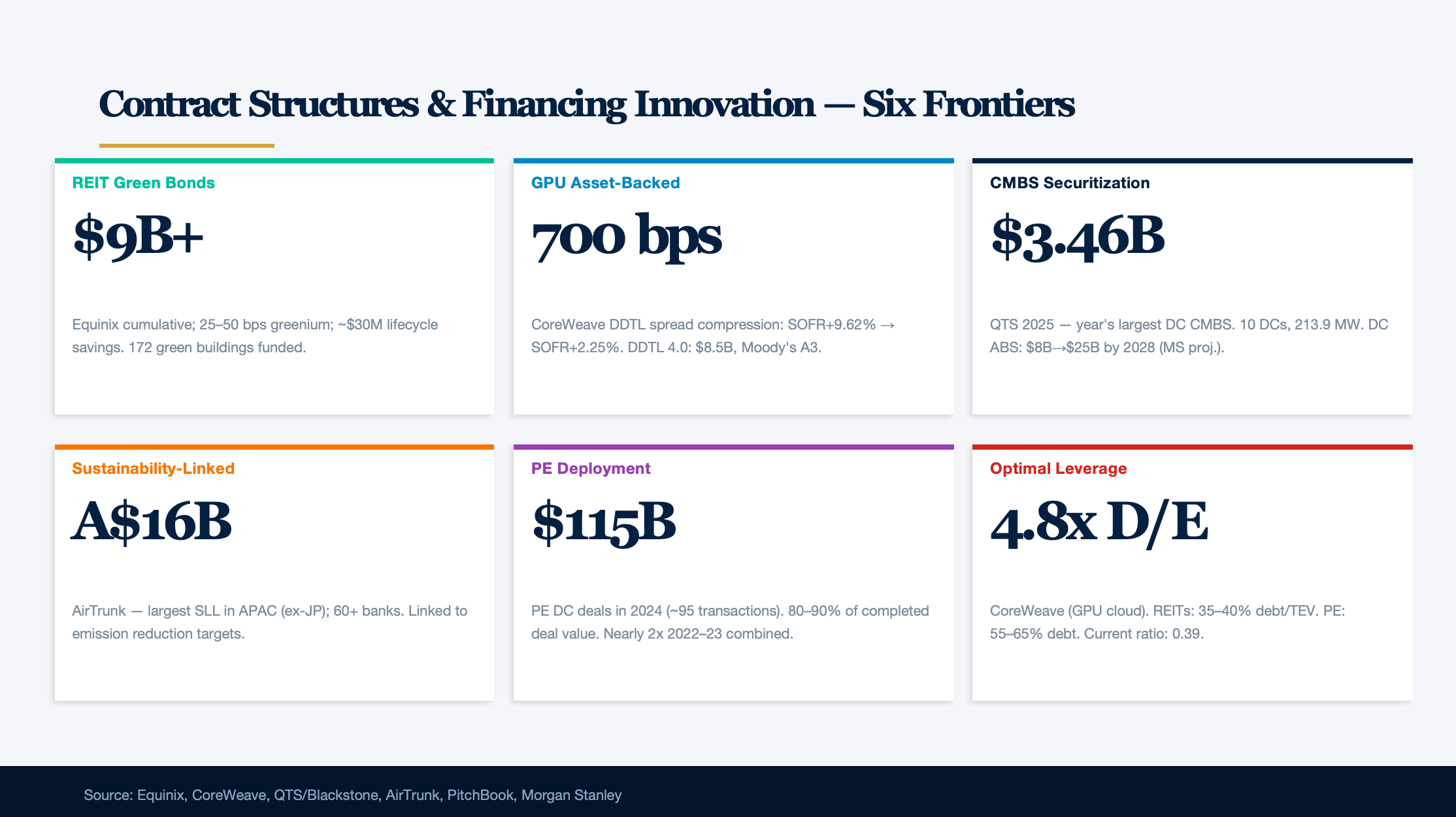

Six Frontiers of Financing Innovation

1. REIT Green Bonds (A/B + F classes): Equinix had cumulatively issued approximately $9B in green bonds through June 2025, with $7B allocated to 172 green building projects and 33 energy efficiency projects. Estimated greenium of 25–50 bps, with lifetime savings of approximately $30M.

2. GPU Asset-Backed Financing (D class): CoreWeave's DDTL spread compression represents the most striking innovation in this space — from early DDTL at SOFR+9.62% compressing to DDTL 4.0 at SOFR+2.25%, approximately 700 bps of spread compression in under 2 years. DDTL 4.0: $8.5B facility, Moody's A3 rated (first-ever investment-grade GPU-backed loan), arranged by Morgan Stanley, MUFG, Goldman Sachs, and JPMorgan, with Blackstone Credit as lead investor.

3. CMBS Securitization (B + G classes): QTS (Blackstone) issued $3.46B CMBS in November 2025 — the year's largest data center securitization, covering 10 data centers across 6 U.S. markets (213.9 MW), floating rate 6.25%. Morgan Stanley projects data center ABS issuance will grow from $8B in 2025 to approximately $25B by 2028.

4. Sustainability-Linked Financing (B class): AirTrunk completed an A$16B refinancing — APAC's (ex-Japan) largest sustainability-linked financing, backed by 60+ banks.

5. PE Platform Deployment (G class): PE spent over $115B on data center deals in 2024 (~95 transactions), nearly doubling the 2022–2023 combined total of $59.3B. PE accounted for 80–90% of completed transaction value.

6. Optimal Leverage by Model: REITs typically maintain 35–40% debt-to-total-enterprise-value, net debt/EBITDA 4.9–5.5x; PE platforms can optimize to 55–65% debt / 35–45% equity; GPU cloud leverage is most aggressive — CoreWeave's debt/equity ratio is approximately 4.8x with a current ratio of just 0.39.

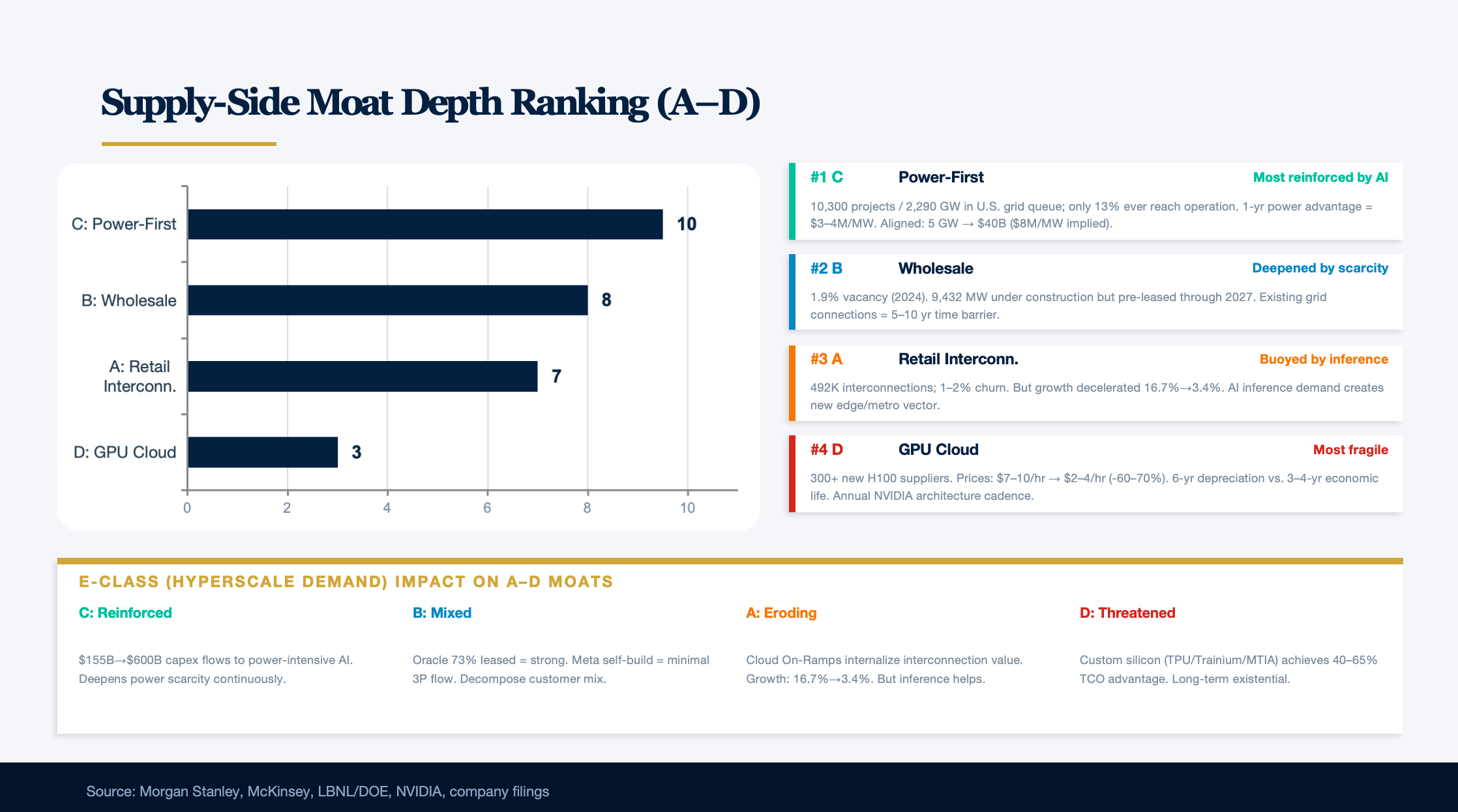

Section 3: Supply-Side Moat Depth Ranking (A–D Only)

The following ranking covers only the four supply-side business models (A–D). E-class (hyperscale procurement), as the demand side, protects customer positioning rather than supplier competitive advantage, and is therefore not ranked alongside A–D. Instead, E-class's impact on A–D moats is analyzed separately at the end of this section.

#1: C-Class (Power-First) — The moat most strengthened by AI. Power access is the industry's binding constraint. The U.S. grid interconnection queue contains approximately 10,300 projects (1,400 GW generation + 890 GW storage) awaiting access, but only 13% of projects entering the queue between 2000–2019 achieved commercial operation, with median wait times extending from under 2 years to approximately 5 years. Morgan Stanley estimates a 1-year power time advantage is worth $3–4M/MW. Aligned held 5 GW of operating and planned capacity, selling at $40B — implying ~$8M/MW on committed capacity. AI demand is projected to grow 3.5x by 2030 (McKinsey), far outpacing any feasible grid expansion, continuously deepening the power moat.

#2: B-Class (Wholesale) — Traditional moat deepened by power scarcity. Existing grid connections and expansion rights provide 5–10-year time barriers. U.S. major market vacancy fell to 1.9% by year-end 2024; under-construction capacity reached 9,432 MW but is largely pre-leased through 2027. Data center construction spending reached $77.7B in 2025 (+190% YoY), but demand is growing faster. Operators with existing grid connections and expansion capacity hold nearly irreplicable first-mover advantage.

#3: A-Class (Retail Interconnection) — Network effect moat buoyed by AI inference. Equinix's 500,000+ interconnections constitute a genuine network-effect barrier, with customer churn at just 1–2%. However, interconnection growth has decelerated from 16.7% in 2018 to 3.4% in 2023. On the positive side, AI inference workloads increasingly demand low-latency, distributed deployment — precisely matching Equinix's edge/metro footprint. Yet hyperscalers' Cloud On-Ramps are internalizing some interconnection value.

#4: D-Class (GPU Cloud) — The most fragile moat. GPU procurement priority was a valuable moat during the 2023–2024 GPU shortage, but is rapidly eroding as Blackwell capacity expands and 300+ new providers enter the H100 cloud market. Technology iteration is an existential risk: NVIDIA's annual architecture cadence (Hopper → Blackwell → Rubin → Rubin Ultra) means hardware depreciates far faster than accounting recognition — CoreWeave depreciates GPUs over 6 years, but their economic life is only approximately 3–4 years. H100 cloud lease prices collapsed from peak $7–10/hour to $2–4/hour (-60–70%); although inference demand surges in late 2025 to early 2026 lifted prices from $1.70 to $2.35/hour (+40%), this is cyclical, not structural.

Hyperscale Procurement Strategy: Erosion & Reinforcement of A–D Moats

Shifts in hyperscale procurement strategy are the largest exogenous variable affecting A–D moat strength. Core dynamics:

Reinforcement of C-class is most pronounced. Hyperscale capex surging from $155B to $500–600B flows overwhelmingly toward power-intensive AI infrastructure. Exponential power demand growth continuously deepens the scarcity of power access rights — directly reinforcing C-class moats.

B-class impact depends on individual enterprise leasing preferences. Oracle (73% leased) and Microsoft (highly lease-dependent internationally) directly benefit B-class operators; Meta (near-total self-build) means its demand barely flows to third-party markets. Acquirers should decompose target customer portfolios into "self-build-oriented vs. lease-oriented customers" to assess demand certainty.

A-class erosion from cloud internalization. Hyperscalers are developing services that bypass third-party interconnection (e.g., AWS Direct Connect, Azure ExpressRoute) — the structural driver behind Equinix's interconnection growth decelerating from 16.7% to 3.4%. But distributed AI inference demand provides a new growth vector for retail interconnection.

D-class threat from custom silicon. Google TPU, AWS Trainium, and Meta MTIA can achieve 40–65% TCO advantages. Custom silicon maturation means hyperscalers increasingly do not need third-party GPU clouds for AI compute — this is the biggest long-term threat to D-class moats.

F/G-class (Capital Layer) barriers differ in nature. REIT tax exemptions and PE leverage flexibility are valuable but replicable financial structures. REITs' core challenge: 90%+ distribution requirements constrain reinvestment capacity. Equinix mitigates this by maintaining AFFO payout at just 47% and through xScale JV structures. PE creates outsized returns through unconstrained distributions, higher leverage, and operational improvements. F/G competitive advantages reflect cost-of-capital differences and operational capabilities rather than traditional "moats."

Section 4: AI Data Center Value Chain Profit Distribution

Extreme Value Concentration at Chip Design

The AI data center value chain exhibits a pronounced "smile curve," but the upstream end (chip design) captures far higher margins than the downstream end (applications/platforms).

Value Chain Layer Representative Gross Margin Operating Margin Market Share
Chip Design NVIDIA 73–76% (GAAP) ~55–60% AI accelerator market >80%
Chip Manufacturing TSMC 56–59% 45–51% Advanced nodes >90%
GPU Cloud Platform CoreWeave 25–30% (incl. depreciation) 0–2% (GAAP) Neocloud market leader
DC Shell (Interconnection) Equinix ~69% (cash gross margin) EBITDA 47–52% #1 global retail colocation
DC Shell (Pure Shell) Wholesale operators EBITDA 30–40%
Power / Utilities Regulated utilities ROE ~10%

NVIDIA FY2025 (through January 2025): data center revenue $115.2B, total revenue $130.5B (+114%), net income $72.9B (55.8% net margin). H100 per-unit manufacturing cost ~$3,320 (die $300 + HBM3 $1,350 + packaging $750), selling price $28,000, per-unit margin approximately 88%. Processors account for 60%+ of total AI infrastructure spending; AI accelerator market growing at approximately 40% CAGR.

Upstream migration paths differ across the four supply-side models: A-class adds interconnection and SDN services to boost per-unit revenue; B-class captures premiums via "AI-ready" design (liquid cooling, high-density power); C-class vertically integrates by controlling power sources (nuclear PPAs, BTM generation); D-class directly operates GPUs but bears depreciation risk. On the demand side, hyperscalers (E-class) fully internalize upstream profits through custom silicon — this is the most profound potential shift in value chain profit distribution.

Section 5: Technology Iteration Impact on Supply-Side Models

The GPU Depreciation Time Bomb & Liquid Cooling Transition

GPU technology's annual iteration cadence creates unprecedented asset depreciation challenges. NVIDIA's architecture roadmap: Hopper (2022) → Blackwell (2024) → Blackwell Ultra/GB300 (H2 2025) → Rubin (H2 2026) → Rubin Ultra (2027). Each generation delivers massive iso-power performance improvements: Blackwell achieves 25x tokens/watt improvement over Hopper in inference. GB300 already accounts for two-thirds of Blackwell revenue.

H100 residual value issues are materializing: secondary hardware prices are approximately 61% of new SXM list price ($25,000–$30,000 vs. $40,000+ original). At $2.50/hour cloud lease pricing, 10,000–12,000 hours (~14–16 months at 100% utilization) are needed to recover acquisition cost; below $1.65/hour, recovery never occurs. Michael Burry warns the top five hyperscalers will cumulatively understate depreciation by $176B in 2026–2028.

Liquid cooling is inevitable. Air cooling reaches physical limits at approximately 41 kW/rack. NVIDIA GB200 NVL72 racks require 120+ kW; future Vera Rubin targets 600 kW/rack, with industry expectations for 1 MW/rack within several years. The liquid cooling market will grow from approximately $4.9B in 2024 to a projected $15–21.3B by 2030 (CAGR 18–26%). Retrofit costs: ~$2–3M/MW; new-build liquid-cooled data centers: ~$8–12M/MW. PUE improves from air-cooled 1.3–1.6 to liquid-cooled 1.02–1.10 — each 0.1 PUE improvement per 10 MW facility saves approximately $1M annually.

Differential impact ranking: C-class (power-first) is least impacted — power access rights are technology-agnostic, cooling systems can be designed for any density, and value resides in MW rather than IT equipment. D-class (GPU cloud) is most impacted — the entire business model depends on GPU economics, and the 6-year accounting vs. 3–4-year economic life mismatch creates systemic risk. B-class and A-class are intermediate — shell/power infrastructure persists across GPU generations, but some facilities require expensive liquid cooling retrofits. Approximately 68% of enterprise data centers built before 2015 lack AI-ready power/cooling capability, facing stranded asset risk.

Section 6: Supply-Side M&A Attractiveness Scoring (A–D Only)

The following assessment covers the four acquirable supply-side business models (A–D). E-class is excluded (not an acquisition target); F/G classes are discussed separately as capital structure tools.

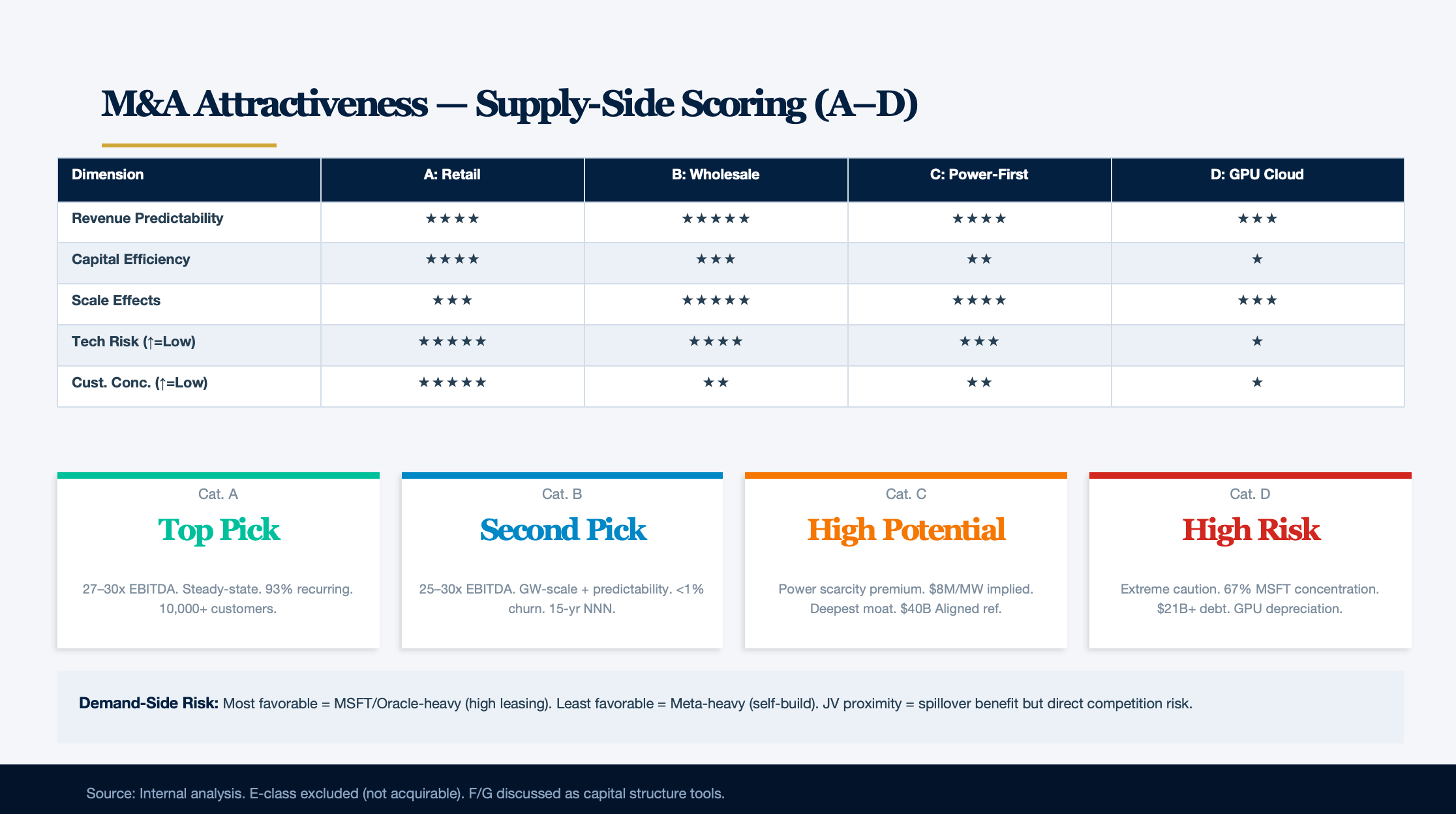

Dimension (5-point scale) A: Retail Interconnection B: Wholesale C: Power-First D: GPU Cloud
Revenue Predictability ★★★★ ★★★★★ ★★★★ ★★★
Capital Efficiency ★★★★ ★★★ ★★
Scale Effects ★★★ ★★★★★ ★★★★ ★★★
Technology Risk (higher = lower risk) ★★★★★ ★★★★ ★★★
Customer Concentration (higher = lower concentration) ★★★★★ ★★ ★★
Overall M&A Attractiveness Top Pick Second Pick High Potential High Risk / High Return

Demand-Side Risk Assessment: Impact of Hyperscale Procurement Shifts on Target Value

Acquirers evaluating A–D targets must incorporate hyperscale procurement strategy as a core risk variable in valuation models:

Most favorable demand mix: Target's customer base skewed toward Microsoft (high leasing dependence) and Oracle (73% leased), with 10+ year NNN leases across multiple geographies. These targets carry the highest demand certainty and justify valuation premiums.

Least favorable demand mix: Target primarily serves Meta (near-total self-build) or depends on a single hyperscaler's short-term contracts. Meta's self-build preference means third-party hosting opportunities are extremely limited, with high non-renewal risk at contract expiration.

JV structure's dual impact: The xScale model enables Equinix to enter the hyperscale market through asset-light structures, but also means exclusive JV relationships may squeeze same-region mid-tier B-class operators. Acquirers should assess whether targets sit within hyperscale JVs' "radiation zone" — proximity benefits from spillover effects, but excessive proximity creates direct competition.

F/G Classes as Capital Structure Tools in M&A

F-Class (REIT) — Liquidity tool & exit channel. REIT investors should note geographic valuation dispersion: U.S. (27–31x) vs. APAC (7–8% yield) vs. China C-REIT (16.9x). REITs' core value lies in providing liquidity premiums and tax optimization, but the 90%+ distribution requirement becomes a constraint as AI-era capital intensity surges.

G-Class (PE) — The arena for outsized returns. PE's success formula: enter at 25–30x EBITDA → operational expansion (QTS model achieves 8x capacity growth) → leverage Blackstone/KKR-tier cost of capital → exit at 30–40x+. Avoid chasing late-cycle high multiples without a clear value-creation pathway.

Key M&A Transaction Multiple Reference Database

Transaction Buyer Amount Year EBITDA Multiple Type
Aligned / AIP-BlackRock BlackRock/GIP/MGX/MSFT/NVDA/xAI $40B 2025 ~40x revenue C-class
AirTrunk / Blackstone+CPP Blackstone A$24B ($16.1B) 2024 ~30x B-class
CyrusOne / KKR+GIP KKR $15B 2021/22 ~26.4x B-class
Switch / DigitalBridge+IFM DigitalBridge $11B 2022 B→C class
CoreSite / American Tower AMT $10.1B 2021/22 ~27–29x A-class
QTS / Blackstone Blackstone $10B 2021 ~25x B-class (current value $700B+)
Vantage / DigitalBridge+Silver Lake DigitalBridge $9.2B equity 2024 B-class
Opcore / Aermont Aermont €1B 2024 ~30x B-class (Europe)

Five Transformation Case Studies & Framework Mapping

Case 1: Equinix xScale (A-class operator → E3 demand-side JV partnership). Equinix entered the hyperscale wholesale market through JV structures with GIC/CPP. The October 2024 U.S. JV deployed $15B+ (GIC 37.5%, CPP 37.5%, Equinix 25%), planning 1.5 GW of U.S. capacity. The elegance: an A-class operator enters B-class markets via E3 (JV) structures while utilizing G-class (PE/sovereign) capital, achieving asset-light expansion while creating a flywheel — hyperscale customers deploying core workloads in xScale facilities further drive interconnection revenue at adjacent IBXs.

Case 2: QTS PE Value Creation (B-class supply + G-class capital = $10B → $700B+). Blackstone acquired QTS in 2021 for ~$10B (25x EBITDA), then achieved approximately 7x value creation through four levers: capacity expansion exceeding 8x to 3+ GW, geographic expansion ($8.2B Spain investment), hyperscale customer long-term NNN lease lock-in (E2 demand-side driven), and innovative financing including $3.46B CMBS (G-class capital innovation).

Case 3: CoreWeave (Crypto mining → D-class GPU cloud). The transformation from 2017's Atlantic Crypto to $5.1B in 2025 revenue represents the data center industry's most dramatic business model leap — 320x revenue growth in three years. Key catalyst: ChatGPT's 2022 launch and deep NVIDIA partnership. But IPO pricing at $40 below the $47–55 target range reflects the market's cautious pricing of D-class structural risks.

Case 4: Switch EVO AI Factory (B-class → C-class upgrade). After DigitalBridge+IFM's $11B acquisition, Switch leveraged Rob Roy's 500+ patented cooling technologies to develop the EVO AI Factory — supporting up to 2 MW per rack power density. This demonstrates how traditional B-class wholesale operators can upgrade to C-class power-first models through proprietary cooling technology and strategic partnerships.

Conclusions: Three Non-Consensus Judgments

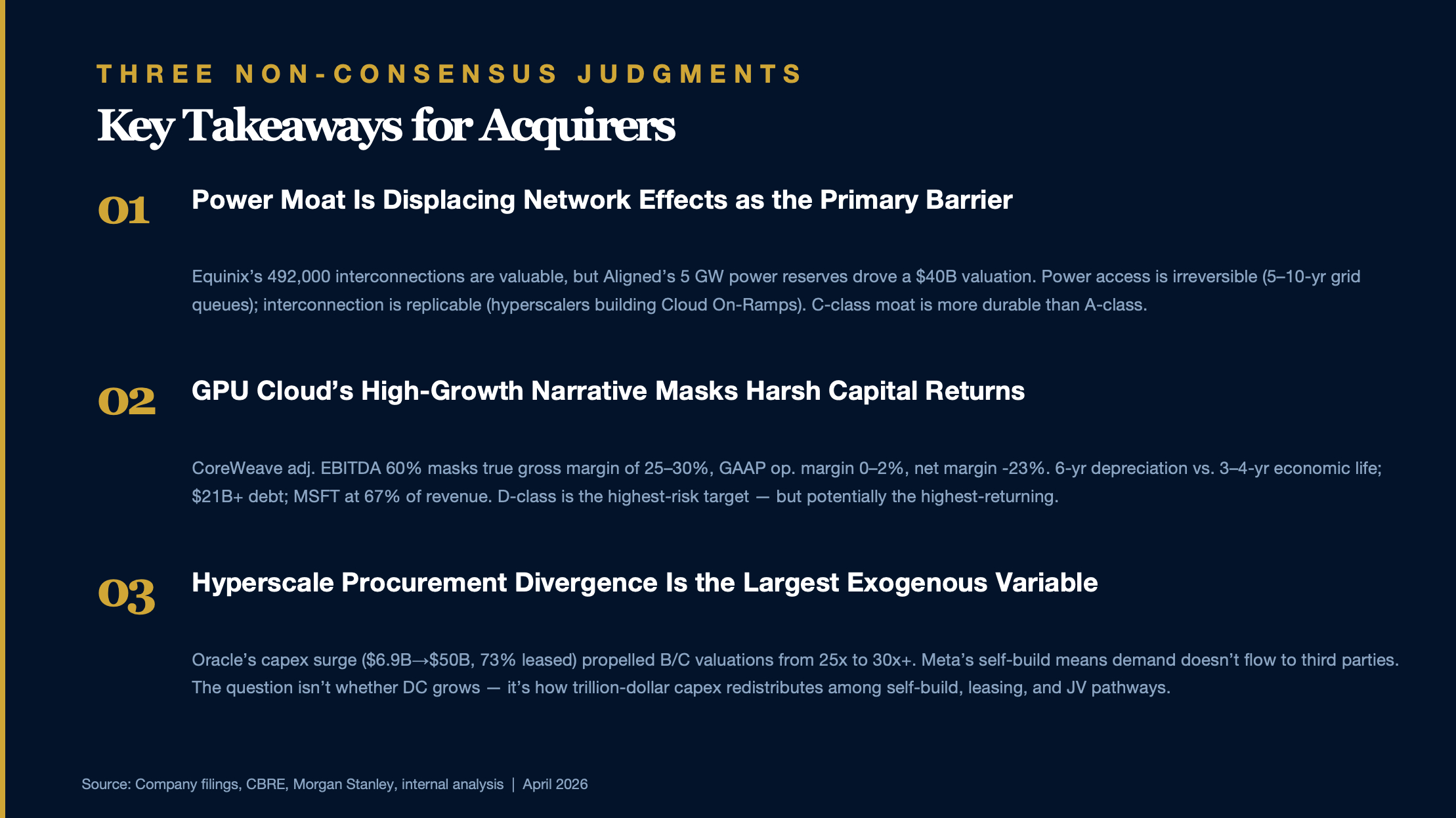

First, the power moat is displacing network effects as the data center industry's primary competitive barrier. Against the backdrop of AI-driven power demand explosion, Equinix's 500,000 interconnections are undoubtedly valuable, but Aligned's 5 GW power reserve carries greater weight in its $40B valuation. The irreversibility of power access (5–10-year grid queues) versus interconnection's replicability (hyperscalers can self-build Cloud On-Ramps) gives the C-class moat greater durability than A-class.

Second, GPU cloud's "high-growth narrative" masks a harsh capital-return reality. CoreWeave's adjusted EBITDA margin of 60% appears impressive, but true gross margin including GPU depreciation is only 25–30%, GAAP operating margin hovers at 0–2%, and net margin is -23%. The 6-year depreciation vs. 3–4-year economic life mismatch, $14B in debt generating $1.1B in annual interest expense, and Microsoft's 67% revenue concentration make D-class the highest-risk investment target among the four supply-side models — though potentially also the highest-return.

Third, hyperscale procurement strategy divergence is the largest exogenous variable for supply-side target valuations. Oracle's capex surge from $6.9B to $50B — 73% via leasing — directly propelled B/C operator valuations from 25x to 30x+ EBITDA. Conversely, Meta's near-total self-build means its demand does not flow to third parties. The question acquirers should focus on is not "whether the data center industry is growing" — the answer is obviously yes — but rather "how the trillion-dollar capex budget is being redistributed among self-build, leasing, and JV pathways," because every percentage-point shift in this allocation implies billions in value creation or destruction for B/C targets.

Chapter V: M&A Ecosystem and Valuation Benchmarks

AI compute demand is reshaping the global valuation system for data center assets at unprecedented speed. Global data center M&A reached a record $73 billion in 2024 (Synergy Research), and remained above $61 billion in 2025 (S&P Global), with average deal size leaping from $684 million in 2022 to $2.17 billion in 2025. Private equity commands 85–90% of total deal value, with financial buyers such as Blackstone, KKR, and DigitalBridge dominating landmark transactions from QTS to AirTrunk to Aligned. At the same time, valuation divergence between AI-ready and traditional data center assets has grown starkly — facilities equipped with liquid cooling, abundant power, and long-term PPAs trade at 25–40x EV/EBITDA, while traditional enterprise colocation assets command only 13–18x. This chapter systematically catalogs every major M&A transaction from 2022–2026, dissects buyer competitive dynamics, codifies the valuation benchmark framework, and analyzes the mechanisms through which AI is reshaping asset values.

1. Global Data Center M&A Panorama, 2022–2026

Global data center M&A experienced sharp volatility followed by sustained growth from 2022–2025. Total 2022 deal value was approximately $48 billion (187 transactions); 2023 declined to approximately $26 billion amid rising rates; 2024 then surged to a record $73 billion on AI-driven demand; and 2025 held above $61 billion (113 transactions). As of April 2026, over $10 billion in deals have been publicly announced. Private equity-related investment hit $108 billion in 2024 (PitchBook), holding an absolutely dominant position.

Major Transaction Register (>$500M)

Key 2022 Transactions

Transaction Buyer Deal Value (EV) Multiple Buyer Type
CyrusOne take-private KKR + GIP ~$15.0B ~25x EV/EBITDA Financial (PE)
Switch take-private DigitalBridge + IFM $11.0B ~27x EV/EBITDA Financial (PE)
American Tower DC business (partial stake) Stonepeak $3.07B Implied EV ~$10.5B Financial (infra)
Teraco (55% stake) Digital Realty ~$1.7B (EV $3.5B) Undisclosed Strategic (REIT)
Entel Data Centers (Chile/Peru) Equinix $705M Undisclosed Strategic (REIT)
MainOne (West Africa) Equinix $320M ~14x EBITDA Strategic (REIT)
DataBank (35% stake) DigitalBridge + consortium ~$1.5B Undisclosed Financial (PE)

Key 2023 Transactions

Transaction Buyer Deal Value (EV) Multiple Buyer Type
Compass Datacenters Brookfield + OTPP ~$5.5B >25x EV/EBITDA Financial (infra/pension)
Data4 Group (Europe) Brookfield ~$2.4–3.8B ~29x EBITDA Financial (infra)
Chindata take-private Bain Capital $3.16B (equity) ~9.4x EV/EBITDA Financial (PE)
Vantage EMEA (minority) AustralianSuper ~$1.6B (€1.5B) Undisclosed Financial (pension)
Nxera (20% stake) KKR ~$800M (S$1.1B) Undisclosed Financial (PE)

Key 2024 Transactions

Transaction Buyer Deal Value (EV) Multiple Buyer Type
AirTrunk Blackstone + CPP A$24B (~US$16.1B) ~23.5–30x EBITDA Financial (PE/pension)
Vantage (growth equity) DigitalBridge + Silver Lake $9.2B (equity) Undisclosed Financial (PE)
STT GDC (18% stake) KKR + Singtel ~$1.3B (S$1.75B) Undisclosed Financial/Strategic
Edgecore Partners Group $1.9B Undisclosed Financial (PE)
Nabiax (Spain) Aermont Capital ~€1.0B ~30x EBITDA Financial (PE)
Digital Realty JV Blackstone $7.0B (hyperscale JV) Undisclosed Financial + Strategic

Key 2025 Transactions

Transaction Buyer Deal Value (EV) Multiple Buyer Type
Aligned Data Centers AIP (BlackRock GIP + MGX) ~$40B Undisclosed Financial/Strategic consortium
Boyd Thermal (liquid cooling) Eaton Corp $9.5B 22.5x 2026E EBITDA Strategic (supply chain)
Stream Data Centers Apollo Undisclosed (4+ GW pipeline) Undisclosed Financial (PE)
STACK Infrastructure Europe Apollo $4.3B Undisclosed Financial (PE)
Fibrebond Eaton Corp $1.4B Undisclosed Strategic (supply chain)

Key 2026 Transactions (through April)

Transaction Buyer Deal Value (EV) Multiple Buyer Type
STT GDC (full acquisition) KKR + Singtel S$13.8B (~US$10.9B) ~$4.7M/MW Financial/Strategic
atNorth (Nordics) Equinix (40%) + CPP (60%) $4.0B Undisclosed Strategic/Financial
DigitalBridge SoftBank ~$4.0B Undisclosed Strategic

Landmark Transaction Deep Dives

Blackstone's acquisition of AirTrunk (A$24 billion / ~US$16.1 billion) was the most consequential transaction of 2024 and, at the time, the largest data center M&A in history. Blackstone, together with CPP Investments, acquired the Asia-Pacific's largest independent data center platform from Macquarie Asset Management and PSP Investments — AirTrunk held 800+ MW of committed capacity and over 1 GW of expansion land bank, spanning Australia, Japan, Singapore, Malaysia, and Hong Kong. The valuation was approximately 23.5–30x EBITDA (based on ~A$1 billion in EBITDA). The transaction followed a highly competitive 12-month auction process with Silver Lake, DigitalBridge, IFM, GIP, and Brookfield all bidding. Notably, Macquarie/PSP had acquired an 88% stake in 2020 at an A$3 billion valuation — implying approximately 8x value creation in four years. Blackstone deployed capital from four of its strategies (real estate partners, infrastructure partners, tactical opportunities, and retail PE), reflecting its extreme conviction in AI digital infrastructure.

The AIP/MGX/BlackRock GIP acquisition of Aligned Data Centers (~$40 billion) was announced in October 2025, breaking AirTrunk's record after just one year and becoming the largest data center transaction ever. The buyer is the AI Infrastructure Partnership (AIP), formed in September 2024 with founding members BlackRock, GIP, MGX, Microsoft, and NVIDIA, later joined by xAI (Elon Musk), Kuwait Investment Authority, and Temasek. AIP's target is to raise $30 billion in equity with potential total capacity of $100 billion (including debt). Seller Macquarie Asset Management had, since its initial 2018 investment, grown Aligned from 2 facilities / 85 MW to 50+ campuses and 5+ GW of capacity spanning the U.S. and Latin America. The transaction's deepest significance lies in the fact that the buyer consortium members are simultaneously investors and end-users of the data centers — marking the deep integration of tech giants with financial capital in AI infrastructure. Macquarie's consecutive sales of AirTrunk and Aligned within 12 months generated approximately $56 billion in combined proceeds.

KKR + Singtel's acquisition of STT GDC (S$13.8 billion / ~US$10.9 billion) was announced in February 2026, making it the second-largest Asia-Pacific data center transaction. The deal follows a phased acquisition strategy: KKR first invested S$1.75 billion in 2024 in redeemable preferred shares plus warrants (gaining approximately 18% economic interest), then acquired the 82% stake held by ST Telemedia for S$6.6 billion in 2026. Post-closing: KKR 75% / Singtel 25%. STT GDC holds 2.3 GW of design capacity across 12 Asia-Pacific markets plus the UK/Europe (including the VIRTUS brand in the UK). Implied enterprise value per megawatt is approximately $4.7 million/MW. Since STT GDC remained in net loss position in FY2024 (−S$185 million), traditional EV/EBITDA multiples are not meaningful — this deal was priced on growth potential and platform consolidation logic.

Blackstone's acquisition of QTS (~$10 billion, 2021) was the seminal transaction kicking off the current wave of PE data center M&A. Blackstone took QTS private at $78/share in cash, a 21% premium (to the June 4 close), at approximately 25–30x 2021 EBITDA. Within 3.5 years post-acquisition, QTS's scale grew over 900%, market rents rose 84%, and it has become the textbook case of PE value creation in data centers through active management.

Bain Capital's take-private of Chindata ($3.16 billion) is the paradigmatic example of valuation discounts on Chinese data center assets. The August 2023 agreement at $8.60/ADS (a 42.6% premium to the unaffected price) reflected only 9.4x EV/FY23 EBITDAwell below the 25–30x level of comparable U.S./European assets. The deal price was also a 36.3% discount to the 2020 IPO price of $13.50, profoundly reflecting the geopolitical and regulatory discount applied to the Chinese market. In September 2025, Bain sold Chindata for approximately $4 billion to a Chinese consortium led by Shenzhen Dongyangguang.

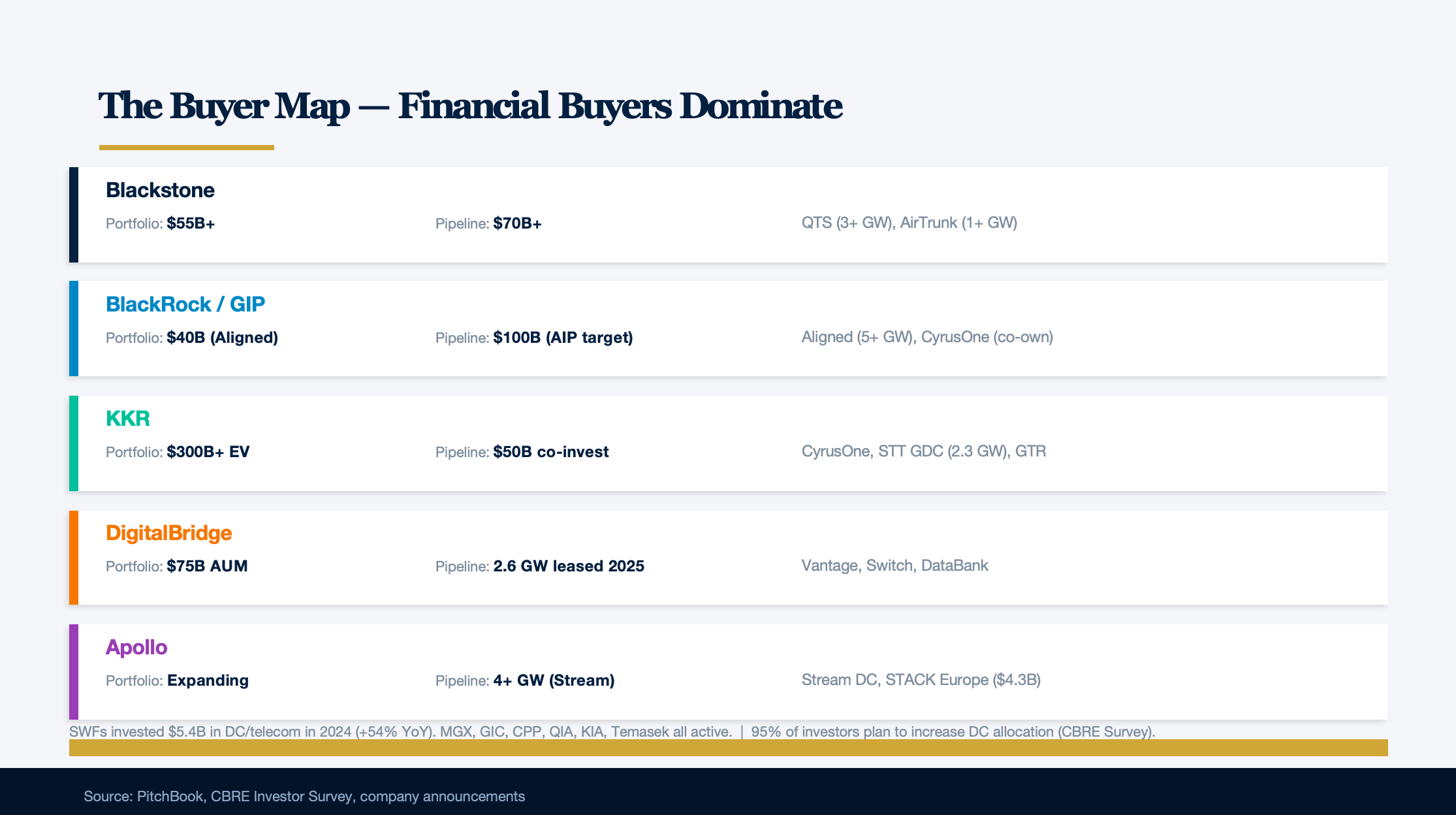

2. The Buyer Map and Divergent Acquisition Logic

Financial Buyers Now Absolutely Dominate

Since 2021, private equity and financial buyers have commanded 85–90% of data center deal value — far above the 54% level of 2020. This shift marks data centers' deep transformation from a traditional real estate / telecom asset into a core infrastructure asset class. PE-related investment reached $108 billion in 2024 (PitchBook), and 95% of investors report plans to increase data center allocations in 2025 (CBRE Investor Survey), with none planning to reduce.

Private Equity — Platform Building and Scale Exits

Blackstone is the world's single-largest data center investor, with a data center portfolio exceeding $55 billion and a construction pipeline over $70 billion. Its strategy has evolved from pure data center investment into a vertically integrated model — acquiring power assets (Potomac Energy Center, a 774 MW gas plant), electrical services companies (Shermco Industries), energy intelligence platforms (Enverus), and data storage technology companies (DDN) to build a complete value chain from power to operations. KKR employs a multi-platform strategy, simultaneously operating CyrusOne (50+ facilities), STT GDC (2.3 GW), and Global Technical Realty (Europe), and has established a $50 billion co-investment platform with Energy Capital Partners for data center + power asset development. DigitalBridge manages over $75 billion in digital infrastructure assets as a pure-play digital infrastructure alternative asset manager, with its Vantage and Switch platforms signing a combined 2.6 GW of leases in 2025. Apollo has accelerated aggressively in 2025, acquiring Stream Data Centers (4+ GW pipeline) and STACK Infrastructure's European business ($4.3 billion).

Typical PE characteristics include: 5–7 year hold periods (Macquarie held Aligned for approximately 7 years before exit); target IRR of 15–25% for stabilized assets, with hyperscale development projects reaching 25–40% gross IRR (over 3–4 year holds); and development yields of 7.5–8.5% (based on 15-year NNN leases with hyperscale tenants). Exit paths include secondary sales to infrastructure funds / sovereign wealth funds, IPO (REIT conversion), or strategic buyer acquisition.

Infrastructure Funds — Long-Duration Cash Flows and Inflation Hedging

BlackRock/GIP (managing over $100 billion of client assets) executed the $40 billion Aligned transaction through the AIP consortium and co-owns CyrusOne with KKR. Brookfield (the world's largest infrastructure equity fund manager, having raised $104 billion cumulatively from 2020–2024) holds a digital infrastructure portfolio of approximately $50 billion. IFM Investors (Australian industry superannuation) focuses on core/core-plus infrastructure assets. Infrastructure funds are characterized by hold periods of 10–15+ years (often in open-ended permanent funds), target net IRR of 8–14%, annual cash distributions of 4–6%, and a preference for stabilized enterprise colocation facilities and long-lease hyperscale assets, achieving inflation hedging through CPI-linked leases.

Sovereign Wealth Funds — Strategic Allocation and AI Positioning

In 2024, global sovereign wealth funds invested $9.4 billion across 53 transactions in digital infrastructure, with data center and telecom investments reaching $5.4 billion (+54% YoY) (IFSWF). MGX (Abu Dhabi / Mubadala's AI investment platform) is the most active sovereign capital, participating as a core AIP member in the $40 billion Aligned deal. GIC (Singapore's sovereign wealth fund) has established hyperscale data center JV platforms with Equinix and CPP Investments. CPP Investments (Canada's pension fund, AUM over $600 billion) participated in the AirTrunk (20% stake) and atNorth (60% majority stake) transactions, and committed $1.3 billion as anchor investor to Ares-managed Japanese data center fund. Qatar Investment Authority (QIA, AUM $524 billion) has partnered with Blue Owl to launch a $3+ billion data center platform. Kuwait Investment Authority and Temasek have also joined the AIP consortium. Sovereign fund hold periods typically exceed 15–30 years, with target net IRRs of 7–10%, and a preference for "trophy-grade" hyperscale platforms with long-term contracts against investment-grade tenants.

The Evolving Role of Strategic Buyers

Telecom operators are shifting from direct data center ownership to joint venture / minority stake holders. Singtel maintains a network + data center integration strategy through its co-acquisition of STT GDC (25% stake) and the Nxera platform with KKR, but capital intensity is borne by the PE partner. NTT is planning a data center REIT listing on the Singapore Exchange. Several European telecom operators (such as Belgium's Proximus) have chosen sale-leaseback structures to divest data center assets (13.3x EV/EBITDA).

Hyperscale cloud providers' build-versus-lease ratio has shifted from roughly 50:50 to approximately 30:70 (CBRE), increasingly leasing capacity from third-party operators. In Q3 2025 alone, hyperscale leasing reached 7.4 GW in the U.S. — exceeding the full-year 2024 total of 7 GW. Oracle signed 5.4 GW in a single quarter (Stargate project), Google 600 MW, Amazon 300 MW, and Meta 200 MW. Core reasons for leasing rather than self-building include: 24–36-month self-build timelines versus 6–12-month lease deliveries; 3–5-year grid interconnection queues; and operators' specialized expertise. Microsoft spends approximately $219 million per day on AI data centers (approximately $80 billion in FY2025).

Platform operator REITs (Equinix, Digital Realty) are pursuing geographic expansion and cross-sell through acquisition. Equinix plans to double its capacity by 2029 (a 5-year build exceeding the prior 27 years combined), with annual capex of $4–5 billion, and is providing capacity to hyperscalers through the xScale JV program (partnering with GIC, CPP, and PGIM). Digital Realty has established a $7 billion hyperscale JV with Blackstone, with 75% of under-construction capacity pre-leased.

Key 2024–2025 Competitive Shifts

The most active buyer rankings are: (1) Blackstone ($55B+ portfolio, $70B+ pipeline); (2) BlackRock/GIP ($40B Aligned deal, AIP consortium targeting $100B deployment); (3) KKR (CyrusOne + STT GDC + GTR multi-platform); (4) DigitalBridge ($75B AUM pure digital infrastructure); (5) Apollo (rapid expansion via Stream DC + STACK Europe). The capital sourcing structure is undergoing profound change: data center debt issuance nearly doubled from $92 billion (2024) to $182 billion (2025) (S&P Global); average ABS deal size grew from $320 million (2022) to approximately $1.1 billion (2025); and green bonds and sustainability-linked financing have become standard practice.

3. Industry Valuation Benchmark Framework and Core Metrics

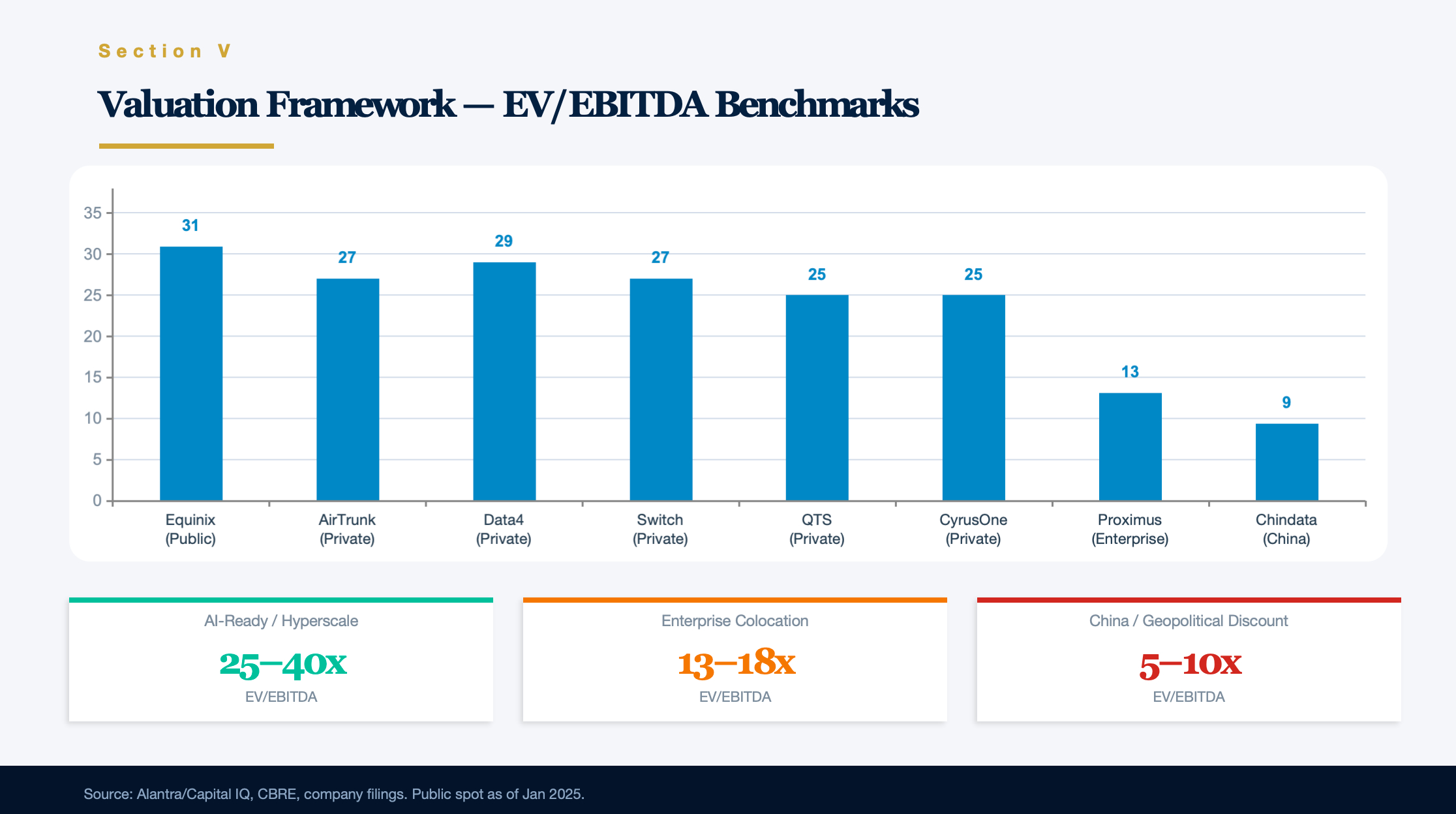

EV/EBITDA: The Core Transaction Pricing Metric

Adjusted EBITDA in the data center industry typically excludes stock-based compensation, one-time transaction fees, asset disposal gains/losses, and non-recurring items — making it the standard profitability metric for this highly capital-intensive, high-depreciation sector.

In January 2025, the listed data center index (Equinix + Digital Realty) traded at a spot EV/EBITDA of 30.9x, with an LTM average of 28.1x and a 3-year average of 26.3x — substantially above the S&P 500's 17.4x (Alantra/Capital IQ). The historical evolution: approximately 20–25x in 2020 → 2021 peak (Equinix reached 42.3x at one point) → compressed to approximately 30x in 2022 due to rate hikes → recovered to the 26–31x range in 2024–2025.

Private transaction valuations have sustained the 25–30x EV/EBITDA range over the past four years (2021–2024) (CBRE), far above the 16x average for infrastructure PE transactions. Case distribution: QTS (2021, ~25–30x), CyrusOne (2022, ~25x), Switch (2022, ~27x), Data4 (2023, ~29x), AirTrunk (2024, ~23.5–30x), Nabiax/Spain (2024, ~30x). However, enterprise colocation asset valuations are significantly lower: Proximus Belgium data centers (2024) at just 13.1x, and Chindata (2023) at only 9.4x — reflecting sharp divergence by asset quality and regional risk.

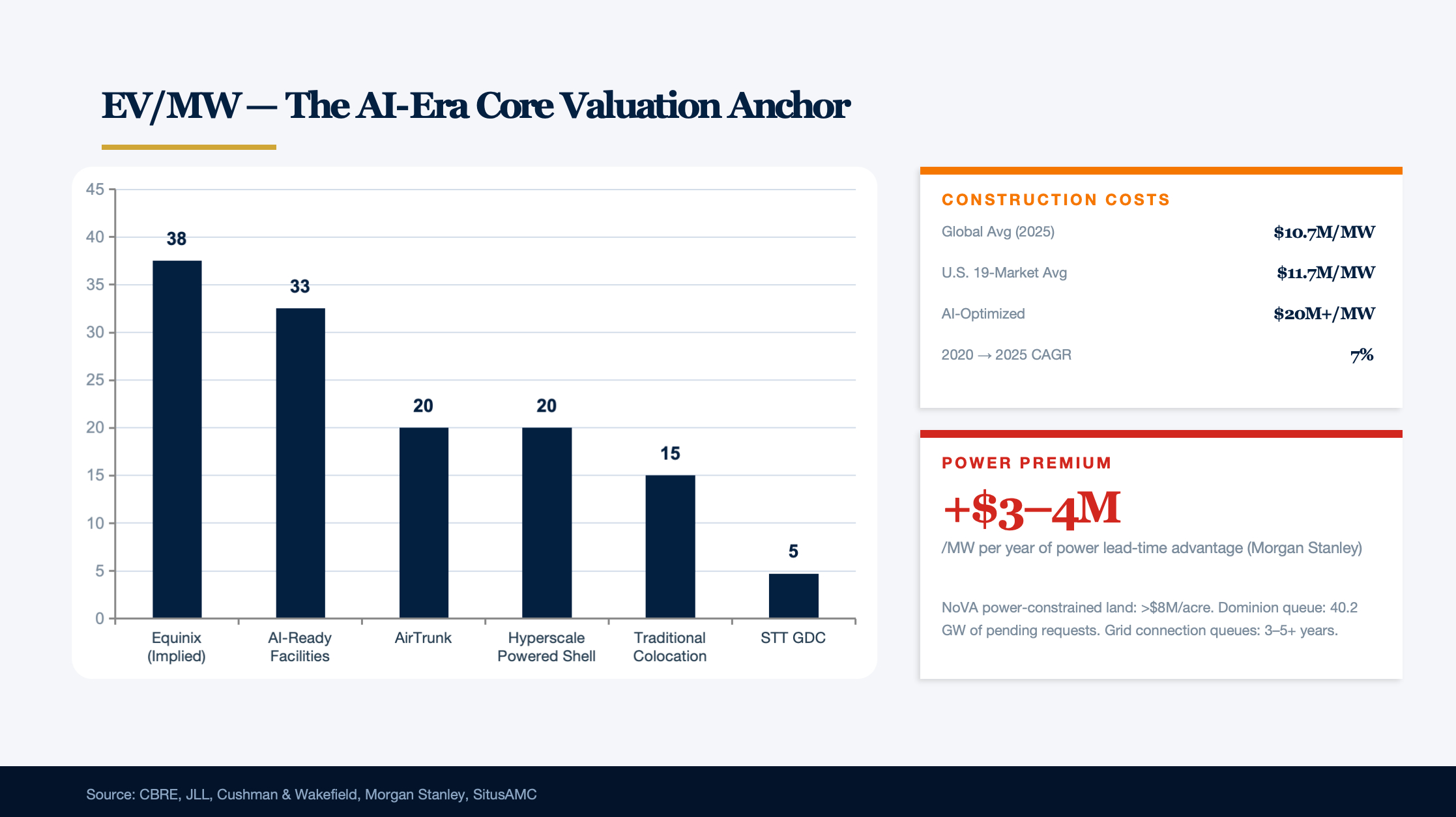

EV/MW: The Core Valuation Anchor for the AI Era

Enterprise value per megawatt (EV/MW) is emerging as a metric of equal importance to EV/EBITDA, because power capacity has displaced square footage as the core value driver of data centers. From known transactions: AirTrunk at approximately $20M/MW (including expansion capacity); STT GDC at approximately $4.7M/MW (including significant undeveloped capacity); Equinix implied at approximately $35–40M/MW (reflecting retail colocation and interconnection premiums). Traditional colocation assets trade at approximately $10–20M/MW; hyperscale Powered Shell at $15–25M/MW; and AI-ready facilities may transact at $25–40M/MW. Morgan Stanley estimates that each additional year of power-delivery lead time creates $3–4 million/MW of incremental value.

Construction Costs and Lease Pricing (Price per kW)

Global average construction costs have risen from $7.7 million/MW in 2020 to $10.7 million/MW in 2025 (JLL, CAGR of 7%), with 2026 forecast at $11.3 million/MW. The 19-market U.S. average is $11.7 million/MW (Cushman & Wakefield 2025), with San Antonio lowest ($9.3M/MW) and Reno highest ($15M/MW). AI-optimized facility construction costs reach $20+ million/MW — nearly double traditional facilities — driven primarily by liquid cooling infrastructure and higher power density requirements.

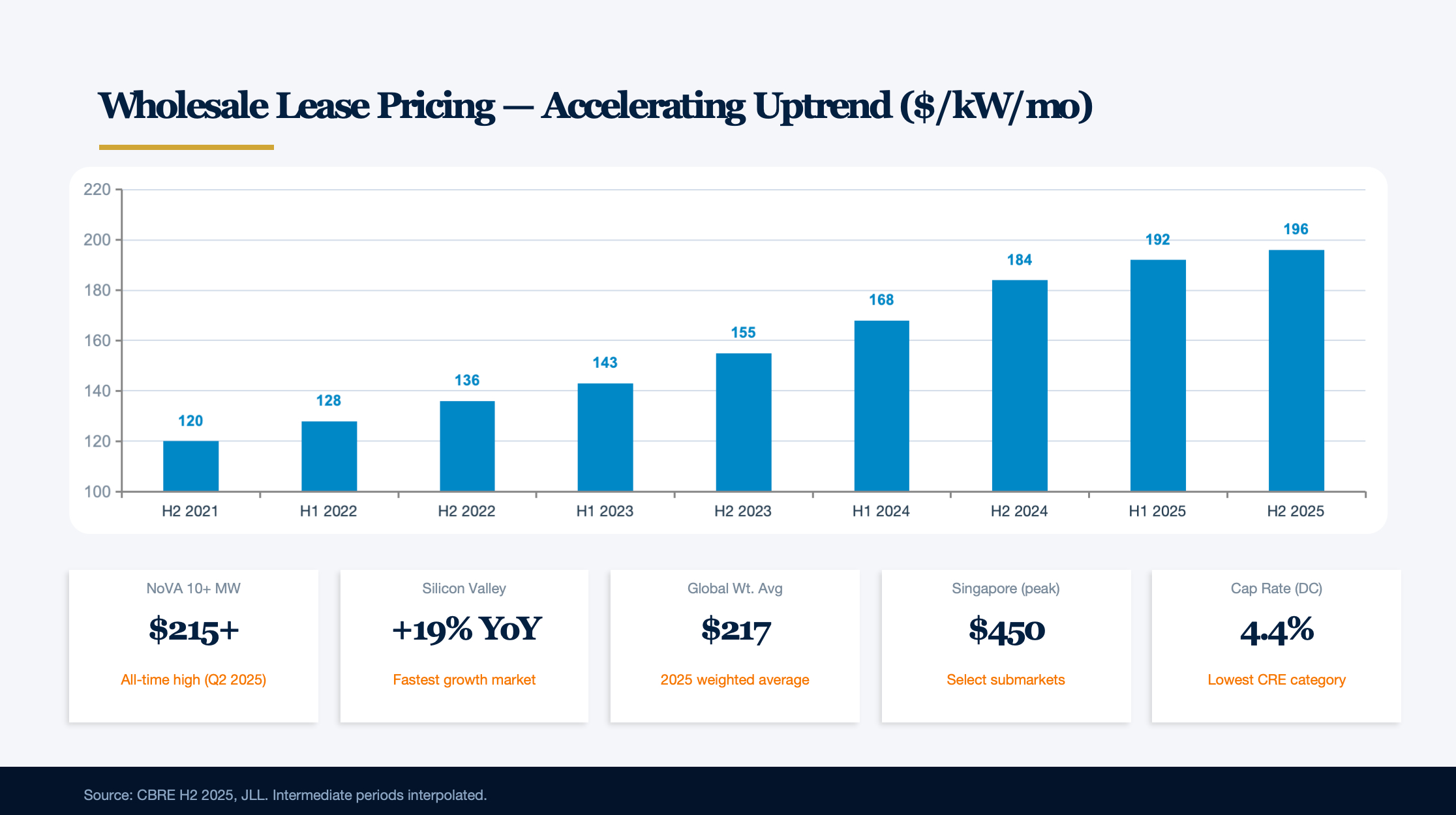

North American wholesale lease pricing shows an accelerating upward trend: from approximately $120/kW/month in H2 2021 to approximately $196/kW/month in H2 2025 (CBRE), the highest level since 2011–2012. Northern Virginia 10+ MW transactions have breached $215/kW/month; Silicon Valley 10+ MW pricing is up 19% YoY. The global weighted average is approximately $217/kW/month (2025). Asia-Pacific colocation rent benchmarks run approximately $100–120/kW/month, with certain Singapore submarkets reaching $450/kW/month.

Cap Rates

Data center REIT implied cap rates are the lowest among all commercial real estate categories, at just approximately 4.4% (Colliers/Barclays 2025), below industrial (5–6%) and Class A multifamily (4–5.5%). Stabilized institutional-grade data center cap rates range from 4.25–6.25% (RCLCO), with 5-year unlevered IRRs of approximately 7.0–8.5%. Small CMBS-securitized colocation facilities price at approximately 6.5% (Trepp 2025). Development project yield targets are typically 7.5–8.5% (based on 15-year NNN hyperscale leases), representing a 75–150 bps premium to market cap rates. CBRE's 2025 investor survey shows 53% of investors expect cap rates to hold flat and 28% expect them to rise.

Listed Company Comparable Valuations

Company Market Cap / EV EV/EBITDA EV/Revenue P/AFFO Notes
Equinix (EQIX) ~$96.3B / $92.0B 26–31x 10–13x ~18–28x 260+ global data centers; retail colocation leader
Digital Realty (DLR) ~$53–63B / $77B ~20.7x ~13.2x ~18–22x Wholesale / hyperscale-oriented
CoreWeave (CRWV) ~$37–46B N/A (loss-making) ~7.7x P/S N/A March 2025 IPO @ $40; GPU cloud / "neocloud"
GDS Holdings ~$6.6B 15.8–18.4x ~4.2x N/A China leader, >20% market share
VNET Group Smaller <5–8x ~2.3x N/A Deep discount, high leverage
Chindata (delisted) $3.16B (take-private) ~9.4x N/A N/A 2023 Bain take-private price

Private vs. Public Valuation Differences

The 2021–2022 U.S. trio of data center take-privates (QTS, CyrusOne, CoreSite) were valued at approximately 25–26x forward EBITDA, roughly level with then-prevailing public multiples — reflecting a 20–25% control premium. In 2023–2024, despite public multiples compressing due to rate hikes, private transaction multiples held in the 25–30x range (e.g., Data4 at 29x), reflecting PE's willingness to pay extra for growth optionality (land banks, power pipelines). After public multiples recovered in 2024–2025, the gap narrowed, but for "trophy-grade" assets with significant expansion capacity, private transactions may still pay premiums beyond what current operating EBITDA would imply.

Significant Regional Valuation Divergence

North America is the largest and most liquid market, hosting 54% of global hyperscale data centers. Tier-1 city stabilized asset cap rates run 4.25–5.5%, with transaction multiples of 25–30x+. European FLAPD markets (Frankfurt, London, Amsterdam, Paris, Dublin) see premium hyperscale asset valuations similarly above 25–30x (Opcore Paris ~25x, Nabiax Madrid ~30x), but enterprise colocation trades at only around 13x. European construction costs run 30–40% above the best U.S. markets. Asia-Pacific established a 23.5–30x benchmark through the AirTrunk transaction, but the China market carries a significant discount — GDS at approximately 15–18x, VNET below 5–8x, Chindata at just 9.4x — a 40–60% discount to comparable U.S./European assets, reflecting geopolitical and regulatory risk premiums. Middle East and emerging market transactions are less frequent but growing rapidly under sovereign capital drive.

4. How AI Demand Is Rewriting the Asset Value Mechanism

Exponential Compute Demand Is Rewriting Valuation Fundamentals

Global data center capacity is projected to grow from approximately 100 GW in 2025 to approximately 200 GW by 2030 (JLL 2026 Global Outlook) — incremental 97 GW over 5 years at a 14% CAGR. AI workloads are projected to rise from approximately 25% share in 2025 to 50% by 2030, with inference overtaking training as the dominant workload around 2027. Yole Group estimates the AI data center TAM will grow from $242 billion in 2025 to $1.2 trillion by 2030. Top five hyperscalers' announced 2026 capex plans total $710 billion (JLL).

Single-chip power consumption has leapt from 150–200 W for traditional CPUs to 700 W for NVIDIA H100, 1,200 W for Blackwell, and a projected 1,500 W in 2026. Per-rack power density has surged from the traditional 7–10 kW to 60–120+ kW for AI-specific workloads (NVIDIA GB200 NVL72 at approximately 120 kW/rack), potentially reaching 1,000 kW/rack by 2029. The IEA projects global data center electricity consumption will double to approximately 945 TWh by 2030, representing roughly 3% of global electricity consumption.

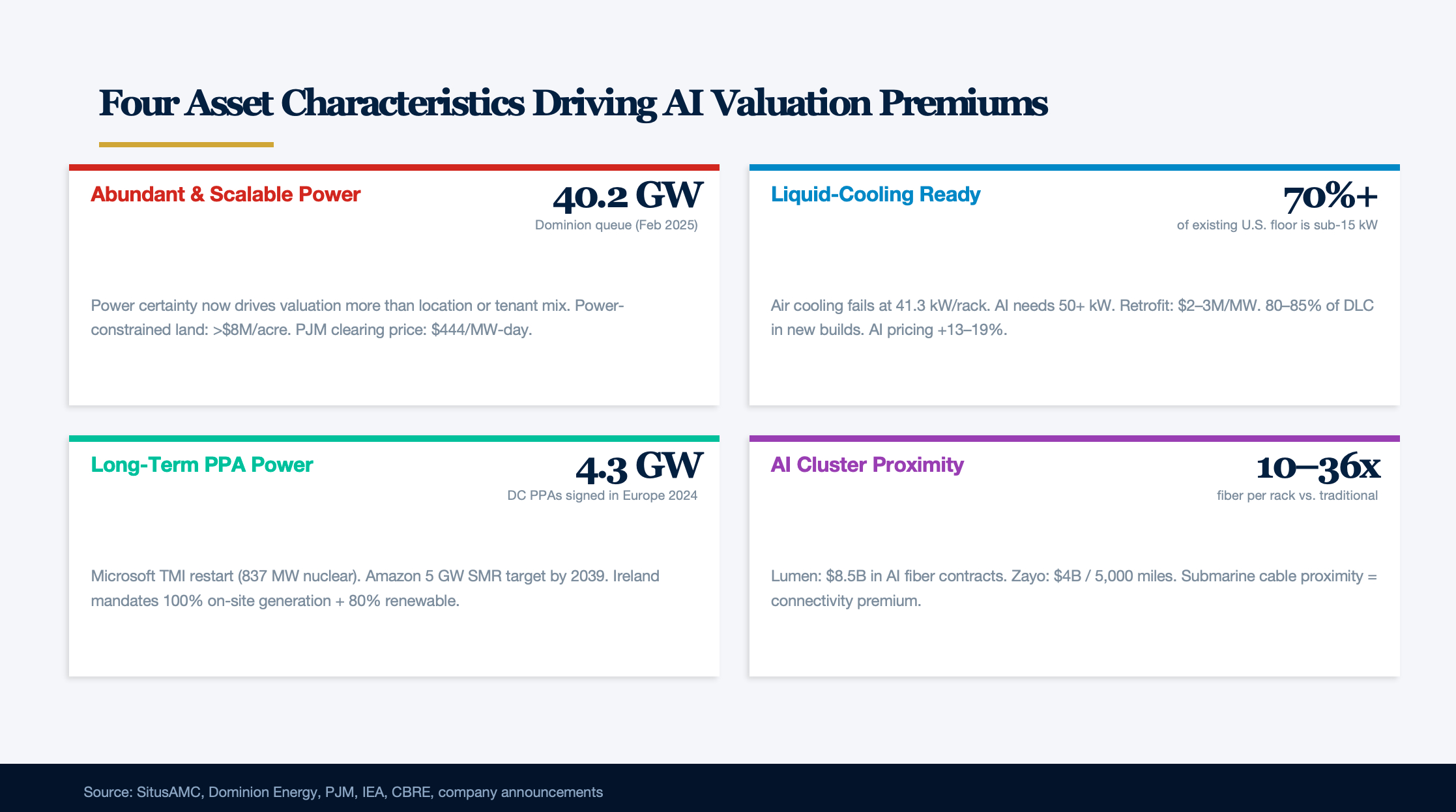

Four Asset Characteristics Driving AI Valuation Premiums

Abundant and scalable power capacity has displaced location and tenant mix as the primary driver of data center valuation. SitusAMC's 2025 analysis states: "Power certainty now drives valuation more than location or tenant mix." In Northern Virginia, Dominion Energy had received 40.2 GW of power connection requests as of February 2025 (nearly doubling from 21.4 GW in July 2024), with grid connection queues exceeding 3–5 years. PJM's Dominion zone capacity auction clearing price surged to $444.26/MW-day (for the July 2025 delivery period), with data center load growth contributing $16.6 billion in incremental capacity market revenue. Existing assets with locked-in power access command structural competitive advantages, with power-constrained parcels commanding over $8 million/acre (CBRE H2 2025).

Liquid-cooling-ready / high-density design matters because air cooling fails above approximately 41.3 kW/rack, while AI workloads typically require over 50 kW. The liquid cooling market is projected to grow from approximately $4.8–5.5 billion in 2025 to $15.8–27.1 billion by 2030 (CAGR 18–23%). Critically, over 70% of existing U.S. data center floor space is designed for sub-15 kW/rack air cooling densities, unable to serve AI workloads. Retrofit costs run approximately $2–3 million/MW, and liquid cooling deployment is 50–100% more expensive than in new builds. Approximately 80–85% of liquid cooling deployments occur in new facilities. Liquid-cooling-ready facilities can support AI customers' high-density needs and thus command rent premiums — 10+ MW AI-scale deployment pricing is up 13–19%.

Long-term PPA-secured low-cost power is increasingly consequential to asset value. One-third of Europe's PPA market is now focused on data centers, with 4.3 GW of PPAs signed in 2024 (+18% YoY). Microsoft's restart of Three Mile Island Unit 1 (837 MW nuclear) dedicated to AI data centers is the most emblematic example. Google and Amazon are also investing in SMRs, expected to deliver in 2028–2030. On-site generation trends are increasingly prominent — Meta is using on-site gas equipment in Ohio, and the Stargate project is using modular gas turbines in Texas. Ireland's December 2025 new rules require new data centers to maintain on-site/near-site generation equal to 100% of demand and 80% renewable energy matching.

Proximity to AI training clusters also commands a premium. AI racks require 10–36x the fiber of traditional racks. Lumen has signed $8.5 billion in AI-specific fiber contracts, and Zayo is investing $4 billion to lay 5,000 miles of fiber. Facilities proximate to existing interconnection hubs and submarine cable landing stations enjoy significant connectivity premiums.

Capacity Scarcity Is Driving Regional Asset Values Upward

Northern Virginia is the world's largest data center market (approximately 16 GW, projected to reach 43.5 GW by 2031), with a colocation vacancy of just 0.72%. Loudoun County has ended by-right data center zoning (March 2025), adding 12–24 months to the approval process. Dallas–Fort Worth absorbed 470.8 MW in 2025 (+424 MW YoY), with 89% of under-construction space pre-leased. Silicon Valley is the fastest pricing-growth market, with 10+ MW pricing up 19% YoY. U.S. tier-1 market vacancy fell to a record low of 1.6%.

European FLAPD hubs face 7–10 year grid connection wait times (IEA November 2025). Dublin has suspended new data center connections through 2028. Amsterdam has banned new data center construction through 2035. Growth is shifting to the Nordics (Stockholm, Finland), Spain, Italy, and Poland. In Asia-Pacific, Singapore has implemented new data center permit caps (PUE < 1.2), and Sydney core zones have vacancy below 5% with rents breaching $150/kW/month.

Brownfield Retrofit vs. Greenfield New-Build: The Valuation Logic

Brownfield (existing conversion) core advantages are 10–15% lower costs (QTS data, achievable at $7–8 million/MW) and faster time-to-market — bypassing lengthy grid approval cycles by leveraging existing power access. In power-constrained markets, existing facilities with locked-in power may command higher valuations than greenfield sites without grid queue position. But structural limitations are significant: 70%+ of U.S. existing space is designed for sub-15 kW density; 40% of older buildings require major structural reinforcement for liquid cooling; and retrofit cycles run 18–36 months (vs. 12–24 months for new builds).

Greenfield (new-build) AI-purpose-built facilities can achieve the highest absolute valuations post-completion — designed from the ground up for 50–120 kW/rack densities, liquid cooling, and optimal electrical architecture. But the challenges are heavy capital deployment (AI-optimized facilities at $20+ million/MW) and long construction timelines. The core factor determining the valuation winner remains power availability — a brownfield with secured power may beat a greenfield without a grid queue position.

The Critical Impact of Pre-Lease Rates on Valuation

Current U.S. under-construction data center capacity has a pre-lease rate of 74–92% (CBRE/JLL 2025), with developers almost entirely avoiding speculative construction. Hyperscale customers typically pre-lease 70–90% of capacity before construction begins. Lease contracts are being securitized into ABS structures (over $9 billion issued through April 2025), enabling locked-in revenue streams to be financed at lower cost. "Data center leases have evolved into infrastructure debt." In the current market environment, high pre-lease rates — particularly with investment-grade hyperscale tenants under long-term take-or-pay contracts — can materially compress cap rates and expand valuation multiples.

Bubble Risk: Arguments For and Against

The core counter-bubble arguments include: tier-1 market vacancy of just 1.6% (a historic low), with JLL reporting 99% industry occupancy; grid physical constraints (queues of 4–8+ years) naturally preventing unchecked overbuild; tenants being the world's most profitable tech giants with long-term contracts backed by investment-grade credit; and AI adoption remaining in early innings, with inference demand poised to continue expanding infrastructure requirements. JLL's 2026 report explicitly states: "99% occupancy is difficult to reconcile with a bubble thesis — this is not a bubble, but a supercycle."

The core bubble / overvaluation risk arguments merit equal attention. Man Group warns that the current debt-driven AI capex cycle is "one of the most concentrated in modern business history," bearing structural parallels to the 1990s fiber bubble — in which $500+ billion of fiber was laid based on faulty forecasts. Hyperscalers are pushing liabilities into SPVs, infrastructure funds, and private credit, creating "dangerous expectation mismatches." 73% of pre-leased projects are concentrated among a handful of hyperscale customers; CoreWeave derives 62% of revenue from a single customer (Microsoft); and the market is "locked in rather than liquid." 2025–2026 is considered a potential inflection window, as supply may begin catching up with demand. Separately, 142 grassroots groups across 24 U.S. states are opposing data center construction, with $64 billion in projects blocked or delayed as of March 2025. Switch's valuation progression — from $4.2 billion in 2017 → $11 billion in 2022 (take-private) → a potential $40 billion in 2025, nearly 10x in 8 years — raises sustainability questions.

Synthesized assessment: In the short to medium term (2025–2027), current absorption rates and supply-demand gaps support prevailing valuation levels. In the medium term (2027–2030), however, there is localized overbuild risk in specific submarkets, technology obsolescence risk (GPU architecture turns over every 1–2 years, while building life is 30–50 years), upward interest rate pressure, and intensifying regulatory/environmental resistance. Even within a secular uptrend, the probability of sharp cyclical drawdowns should not be underestimated.

Conclusion: A Paradigm Shift from Real Estate Asset to Compute Infrastructure

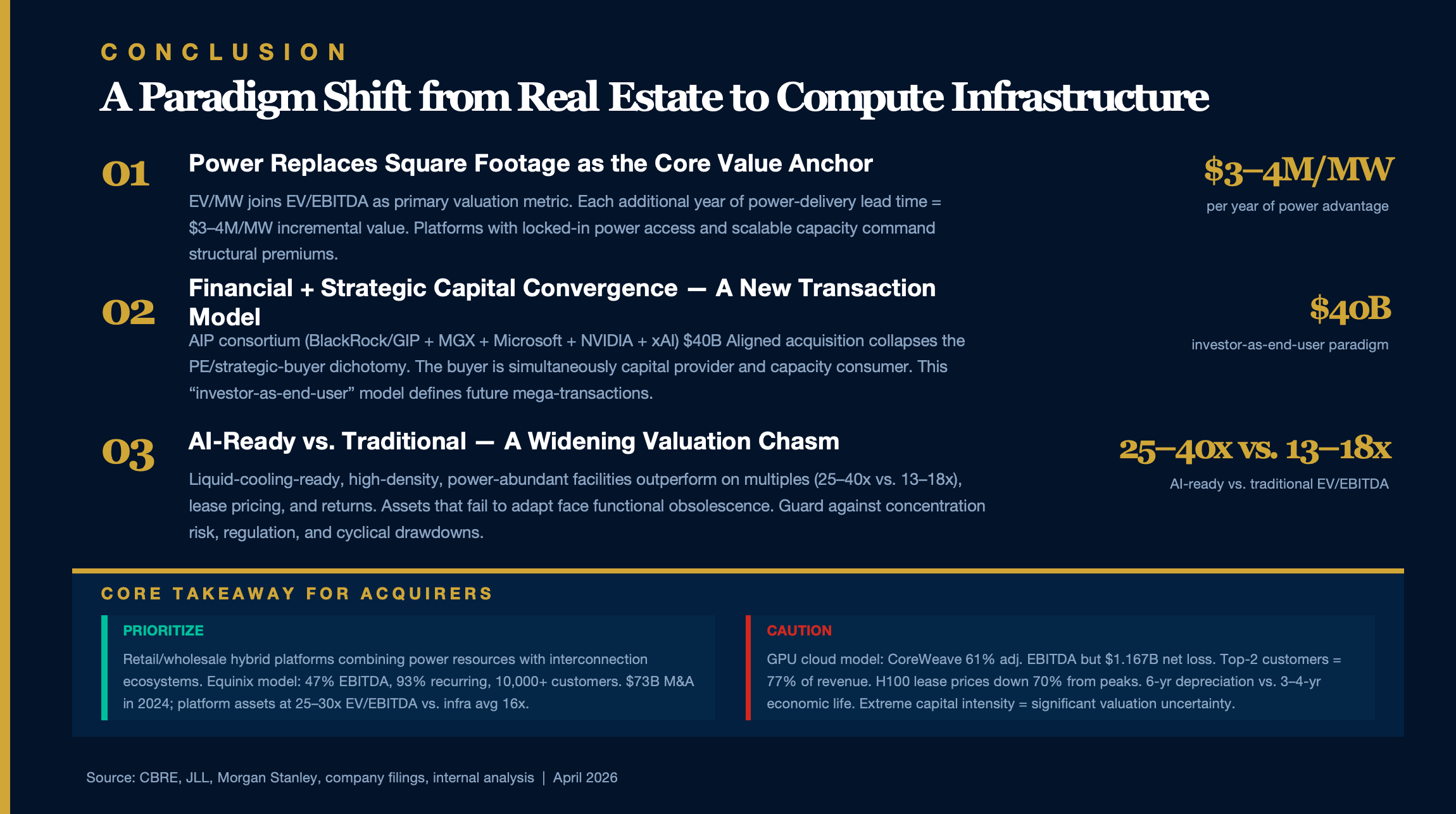

The global data center M&A ecosystem is undergoing a fundamental transition from traditional commercial real estate to a core infrastructure asset class. Three structural changes warrant particular attention.

First, power is replacing square footage as the core value anchor. EV/MW is joining EV/EBITDA as a primary valuation metric, and each additional year of power-delivery lead time creates $3–4 million/MW of incremental value. This means platforms with locked-in power access and scalable capacity will continue to command valuation premiums.

Second, the deep convergence of financial capital with technology strategic capital is pioneering an entirely new transaction model. The AIP consortium (BlackRock/GIP + MGX + Microsoft + NVIDIA + xAI) $40 billion Aligned acquisition marks the collapse of the traditional PE/strategic-buyer dichotomy — the buyer is simultaneously a capital provider and a capacity consumer. This "investor-as-end-user" structure may become the paradigm for future mega-transactions.

Third, the valuation chasm between AI-ready and traditional assets continues to widen. Liquid-cooling-ready, high-density, power-abundant facilities comprehensively outperform traditional colocation assets on transaction multiples, lease pricing, and development returns. Existing assets that fail to adapt to AI demand face functional obsolescence risk, while platforms possessing the above characteristics enjoy unprecedented capital pursuit. Market participants must capture the historic AI supercycle opportunity while simultaneously guarding against concentration risk, tightening regulation, and cyclical drawdowns.

Core Takeaway: The data center industry is undergoing a paradigm shift from "real estate operator" to "AI compute factory." Through the M&A lens, power access has displaced interconnection density as the deepest moat. At opposite ends of the business-model spectrum, high-interconnection-density retail colocation (the Equinix model, 47% EBITDA margin) and GPU cloud services (the CoreWeave model, 61% adjusted EBITDA margin but $1.167 billion net loss) exhibit fundamentally different risk-reward profiles. Global data center M&A totaled $73 billion in 2024, with PE funds driving 80–90% of deals and platform assets trading at 25–30x EV/EBITDA — far above the infrastructure industry average of 16x. Acquirers should prioritize retail/wholesale hybrid platforms combining power resources with interconnection ecosystems, and maintain caution toward the GPU cloud model — its customer concentration (CoreWeave's top two customers account for 77% of revenue), GPU depreciation risk (H100 cloud lease prices down 70% from 2023 peaks), and extreme capital intensity constitute significant valuation uncertainties.
